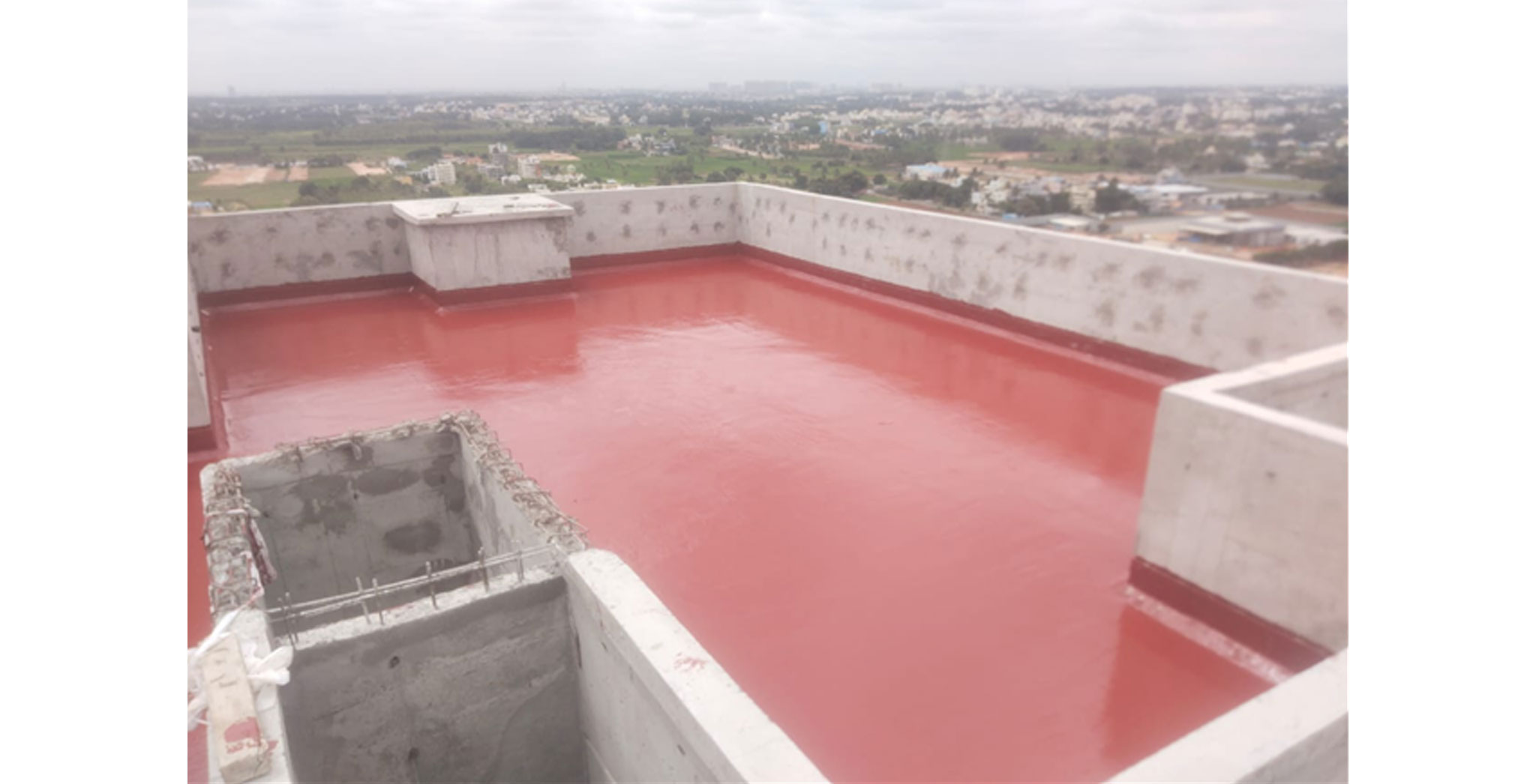

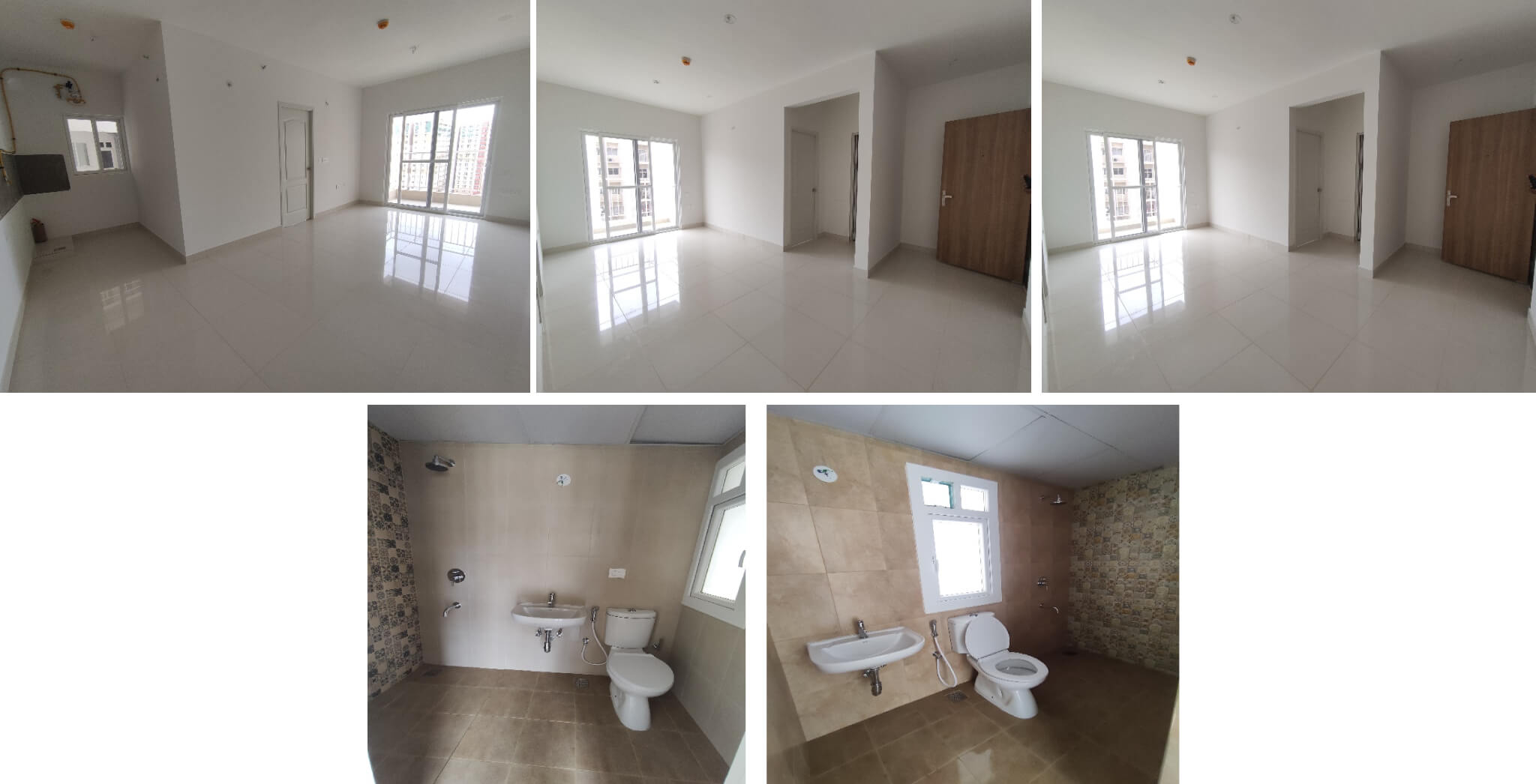

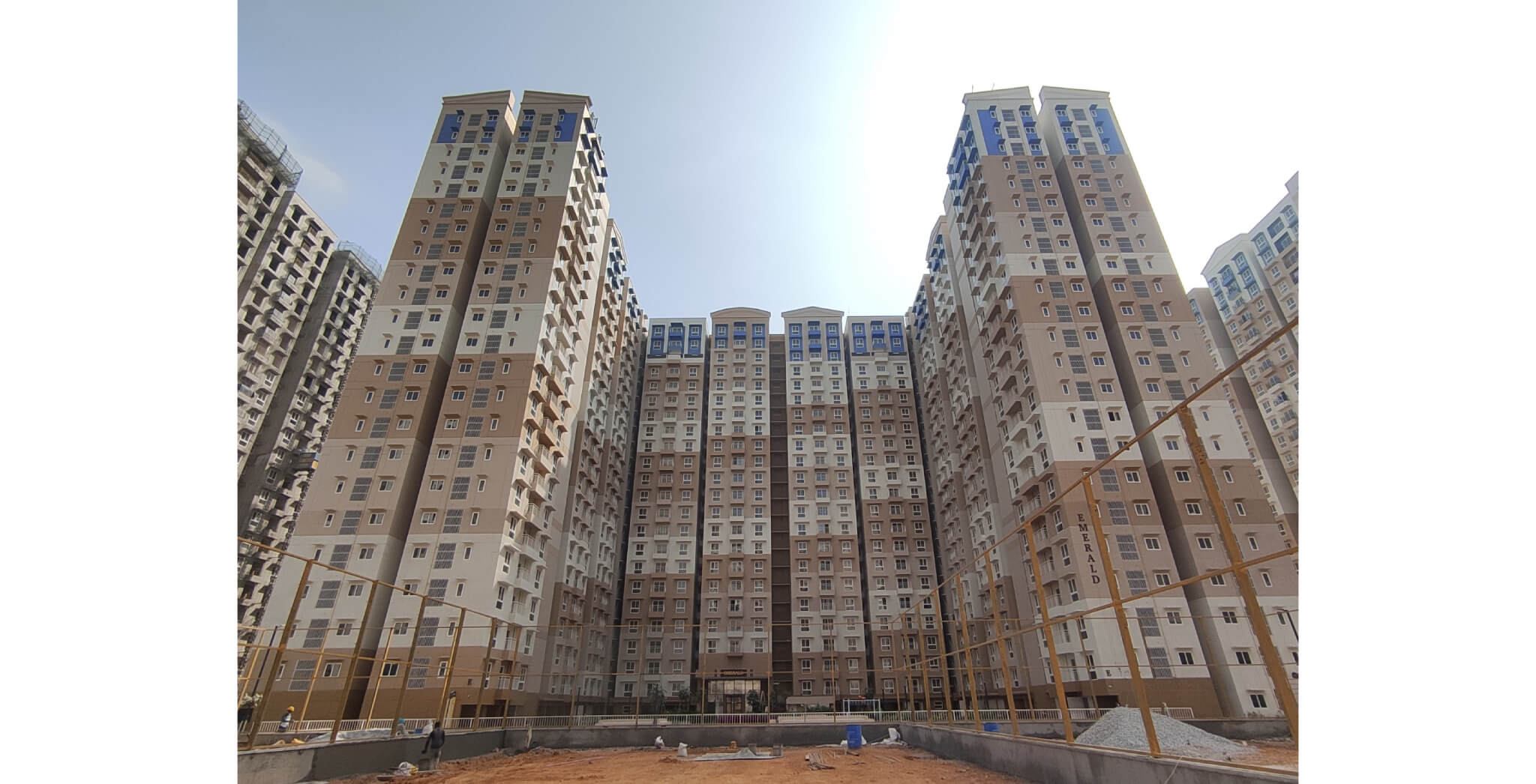

Structure & Finishes completed
Nov 2025

DRAG

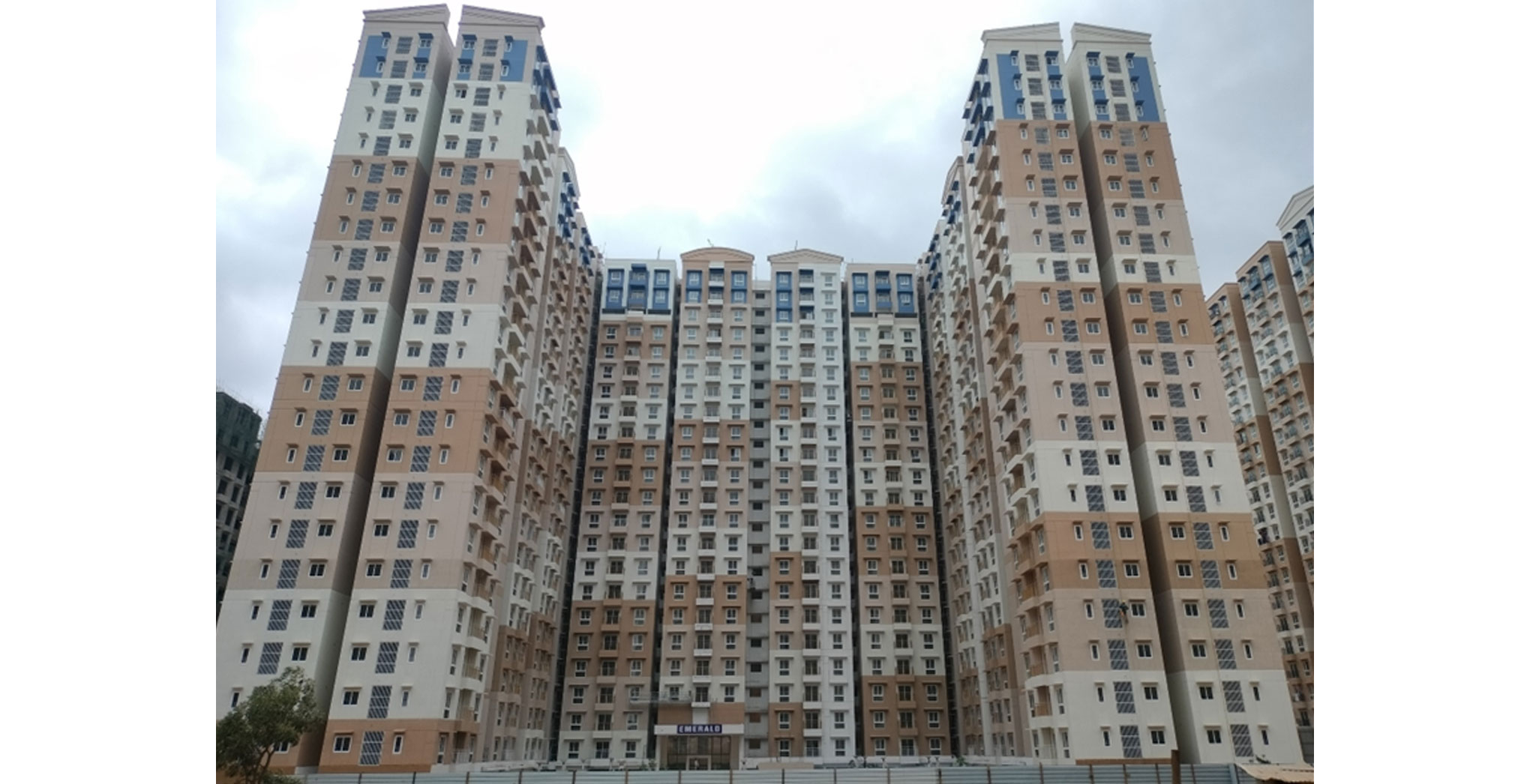

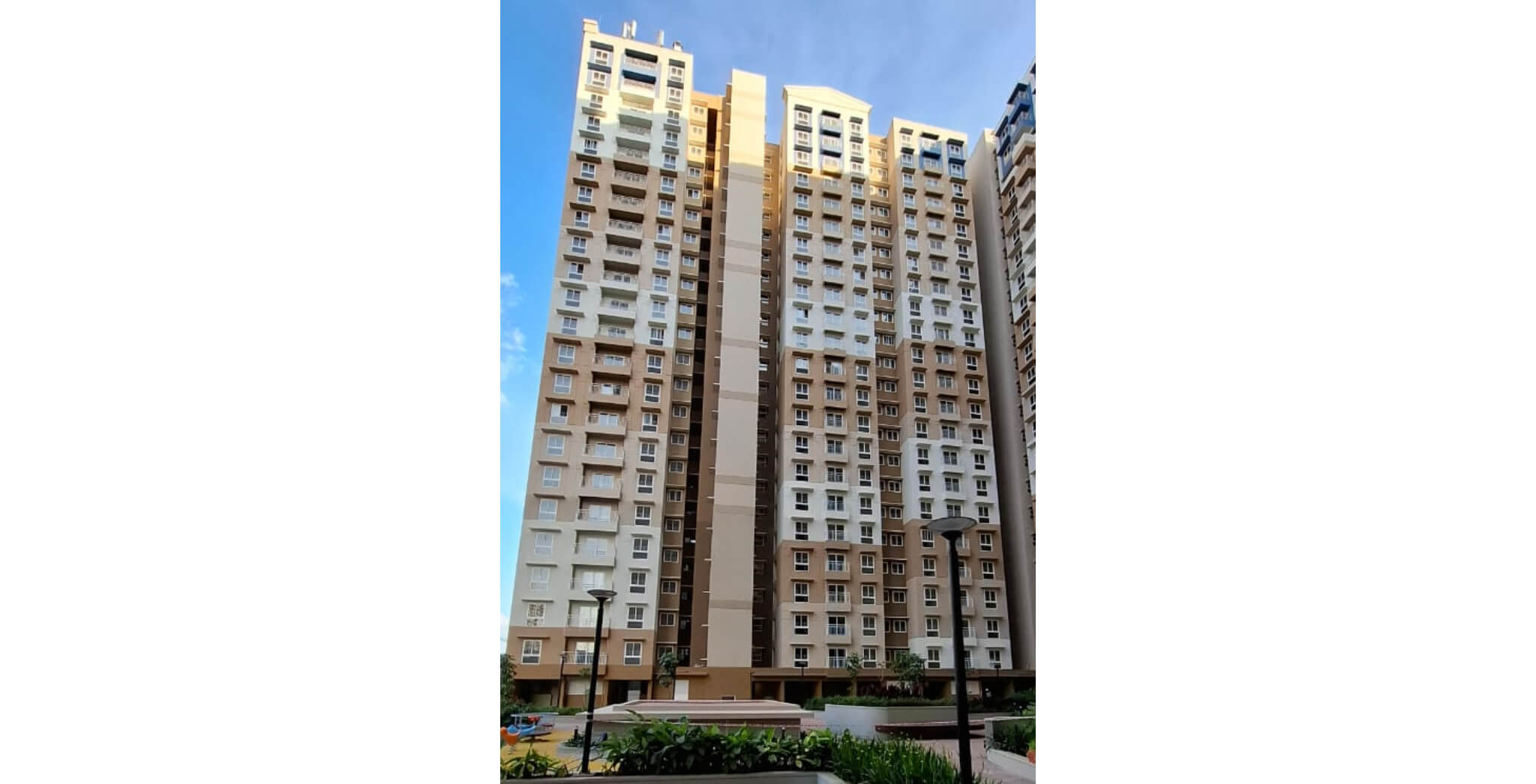

East Wing

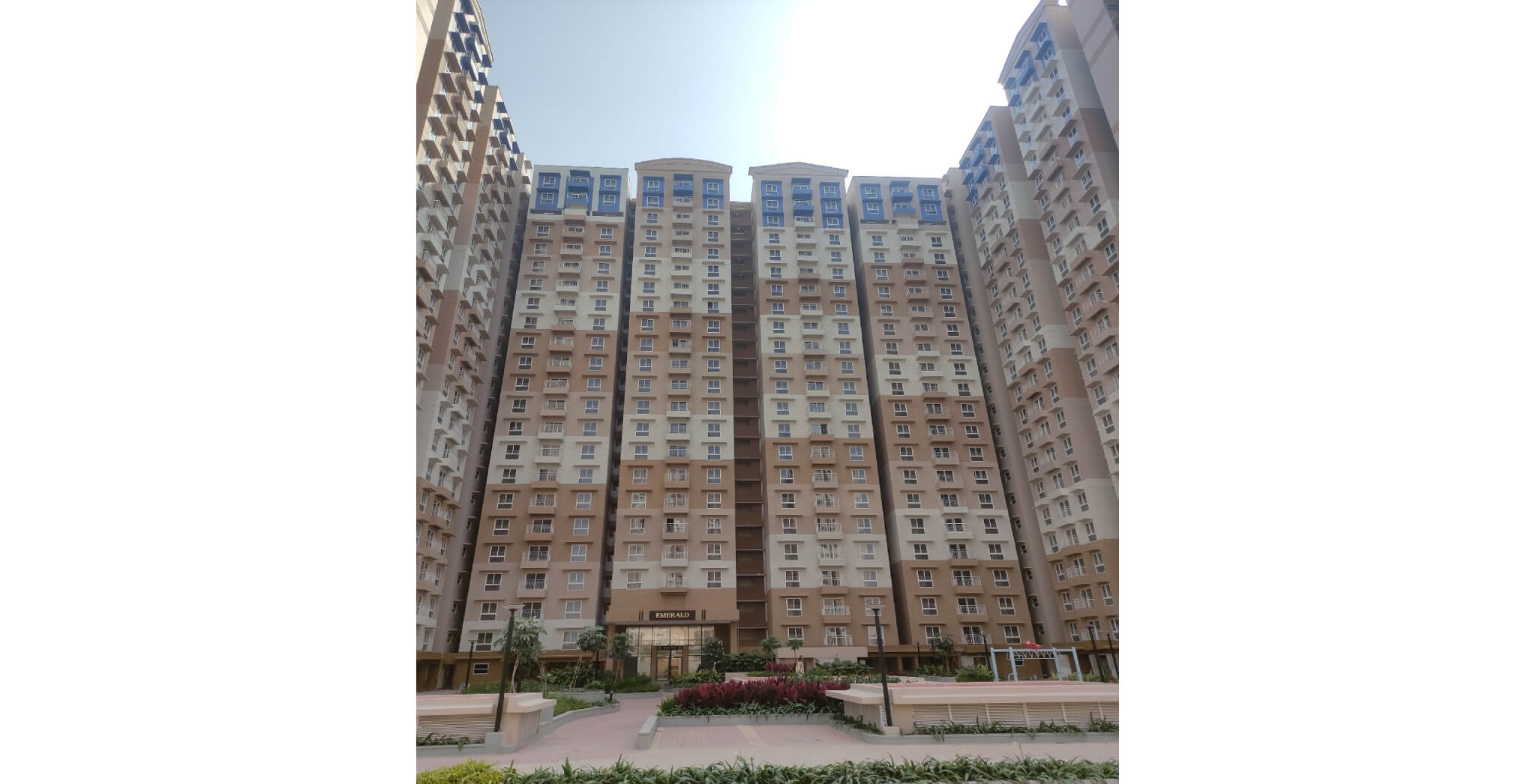

Nov 2025

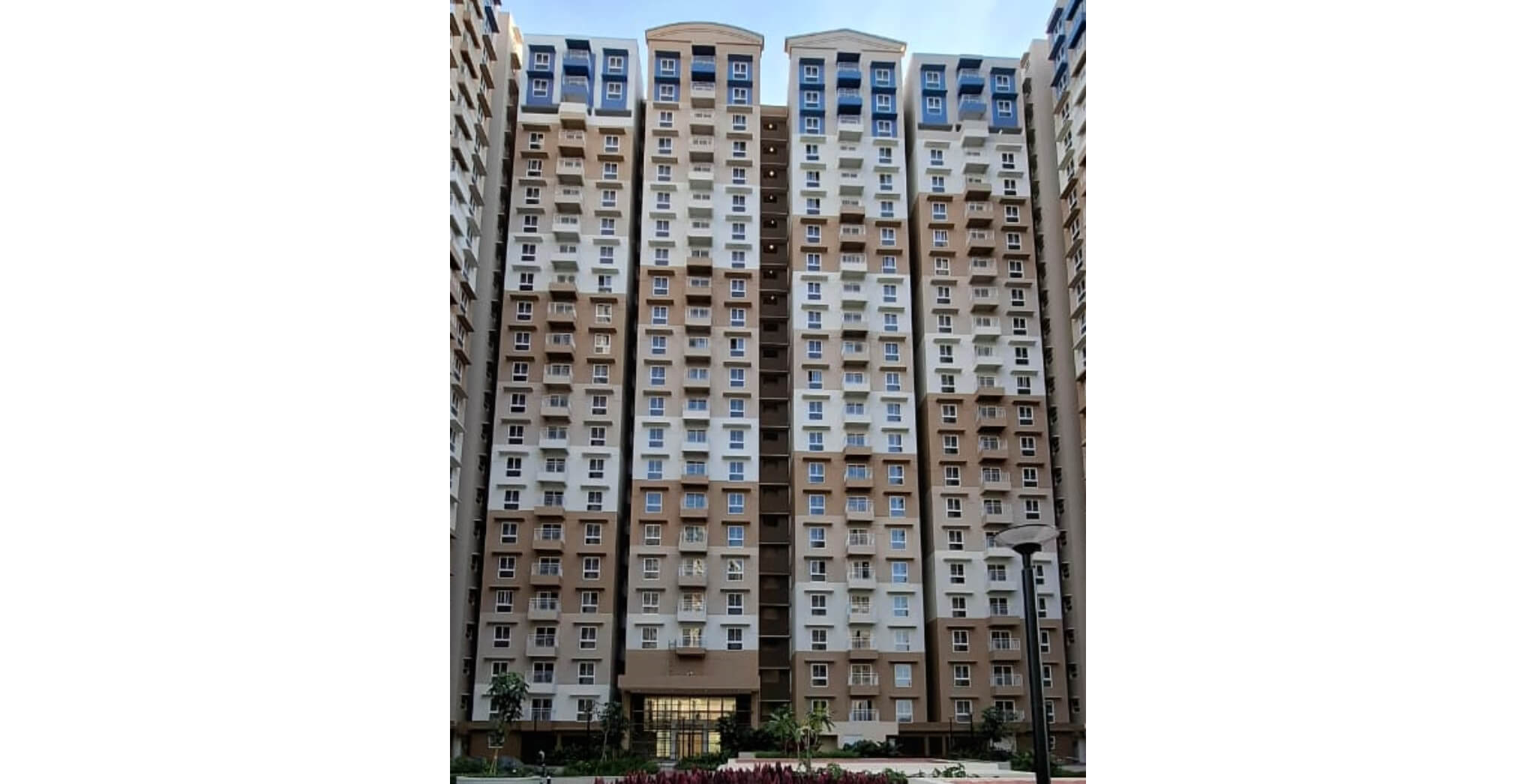

South Wing
Nov 2025

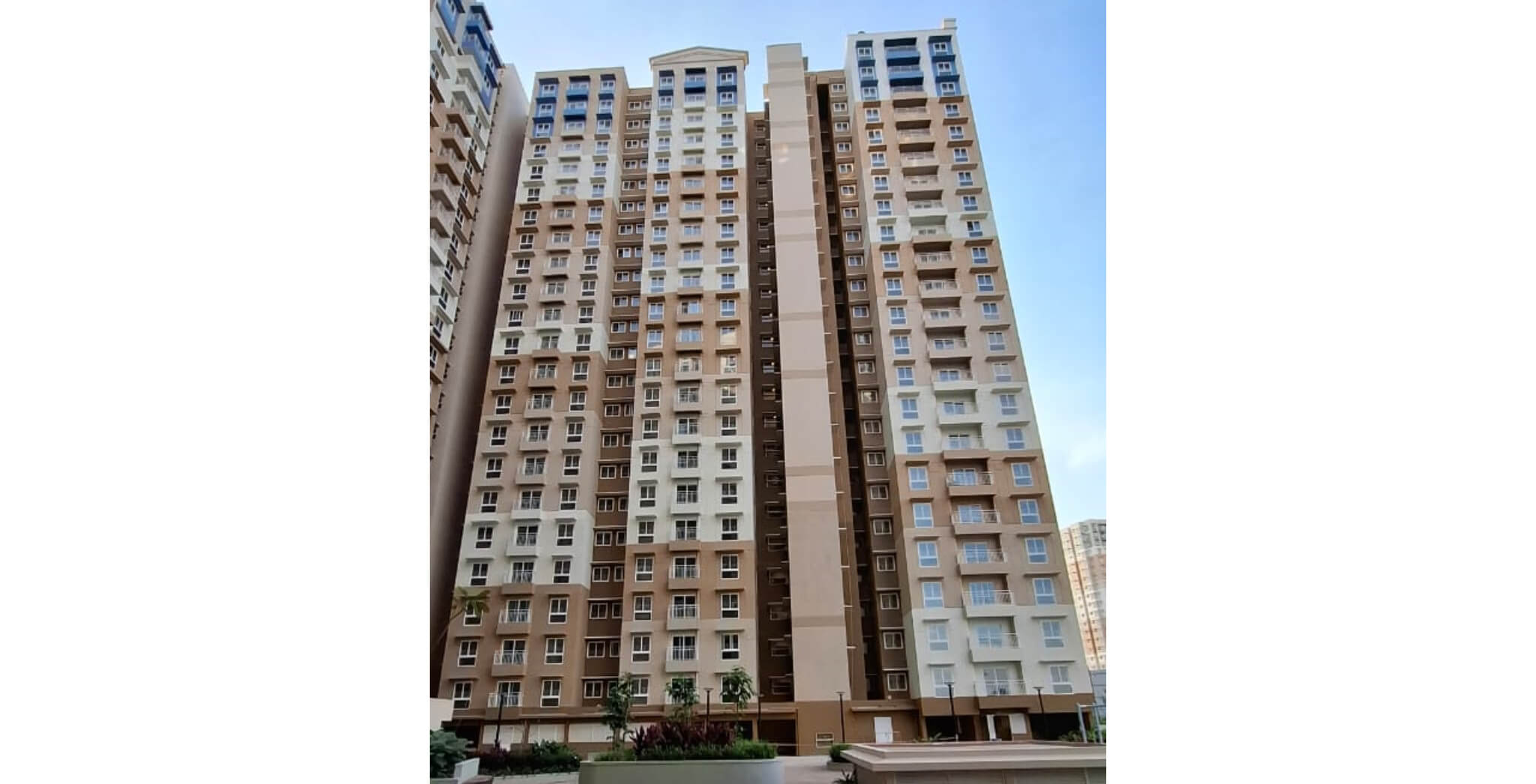

West Wing
Nov 2025

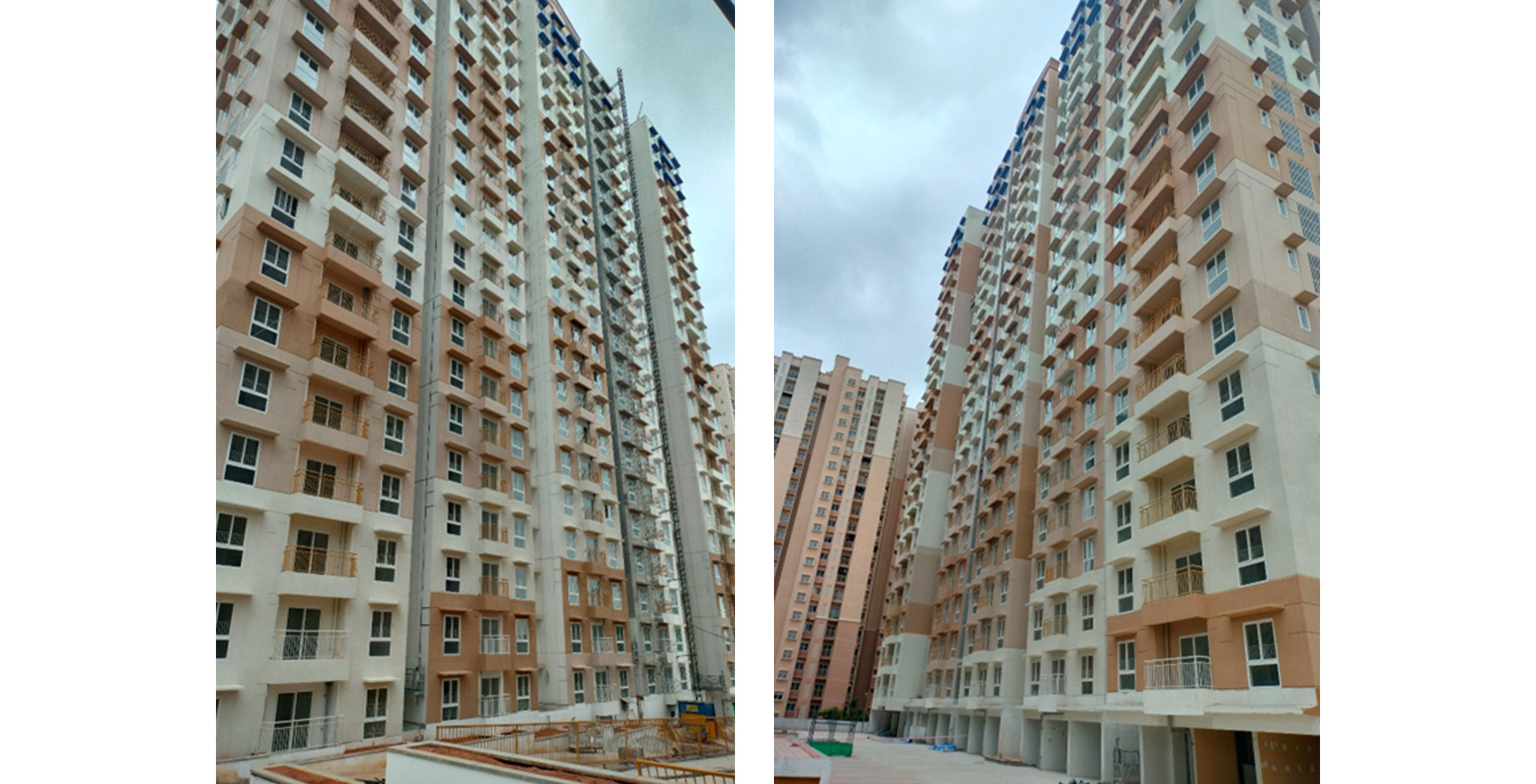

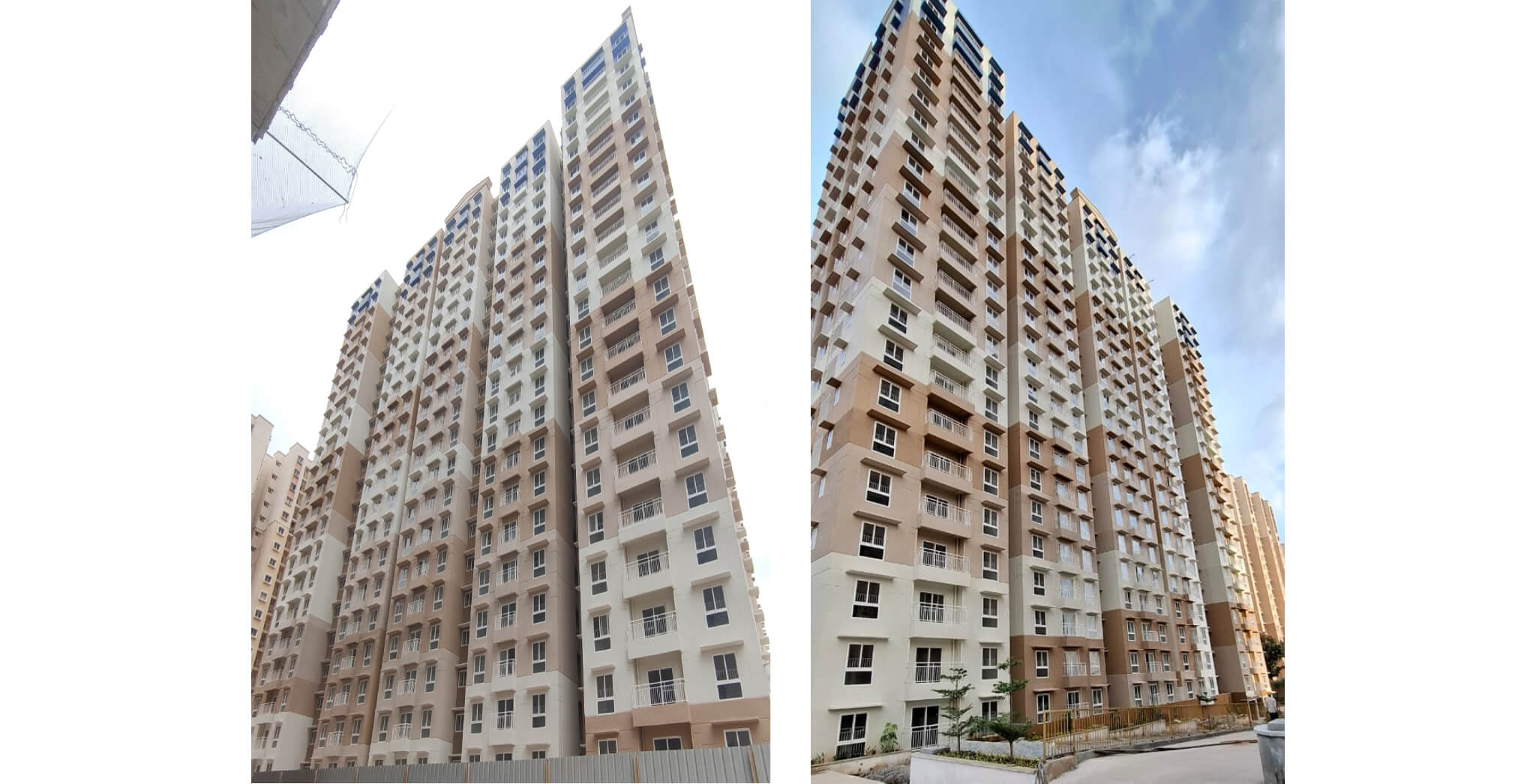

East ,South and West wing External Painting works completed
Nov 2025

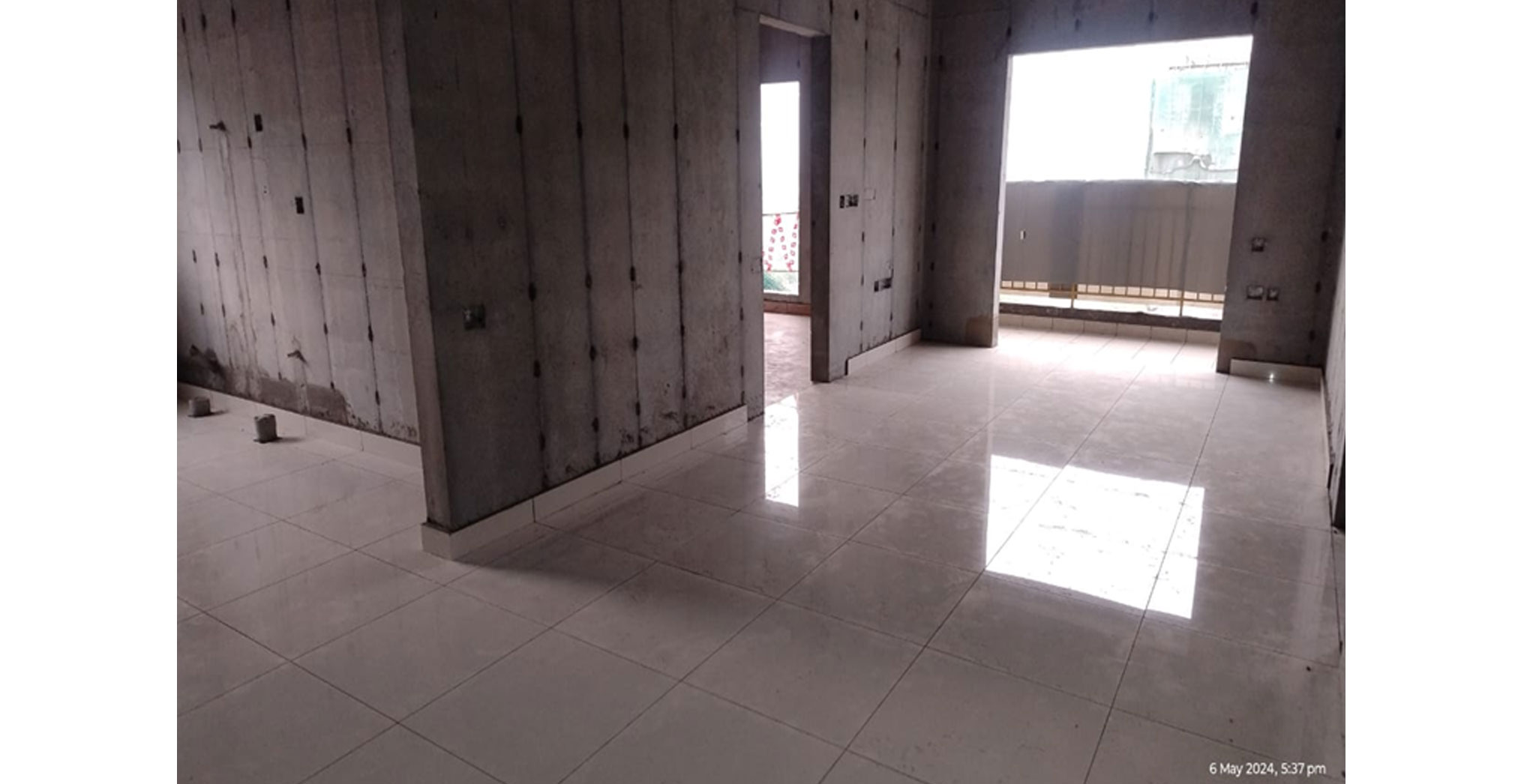

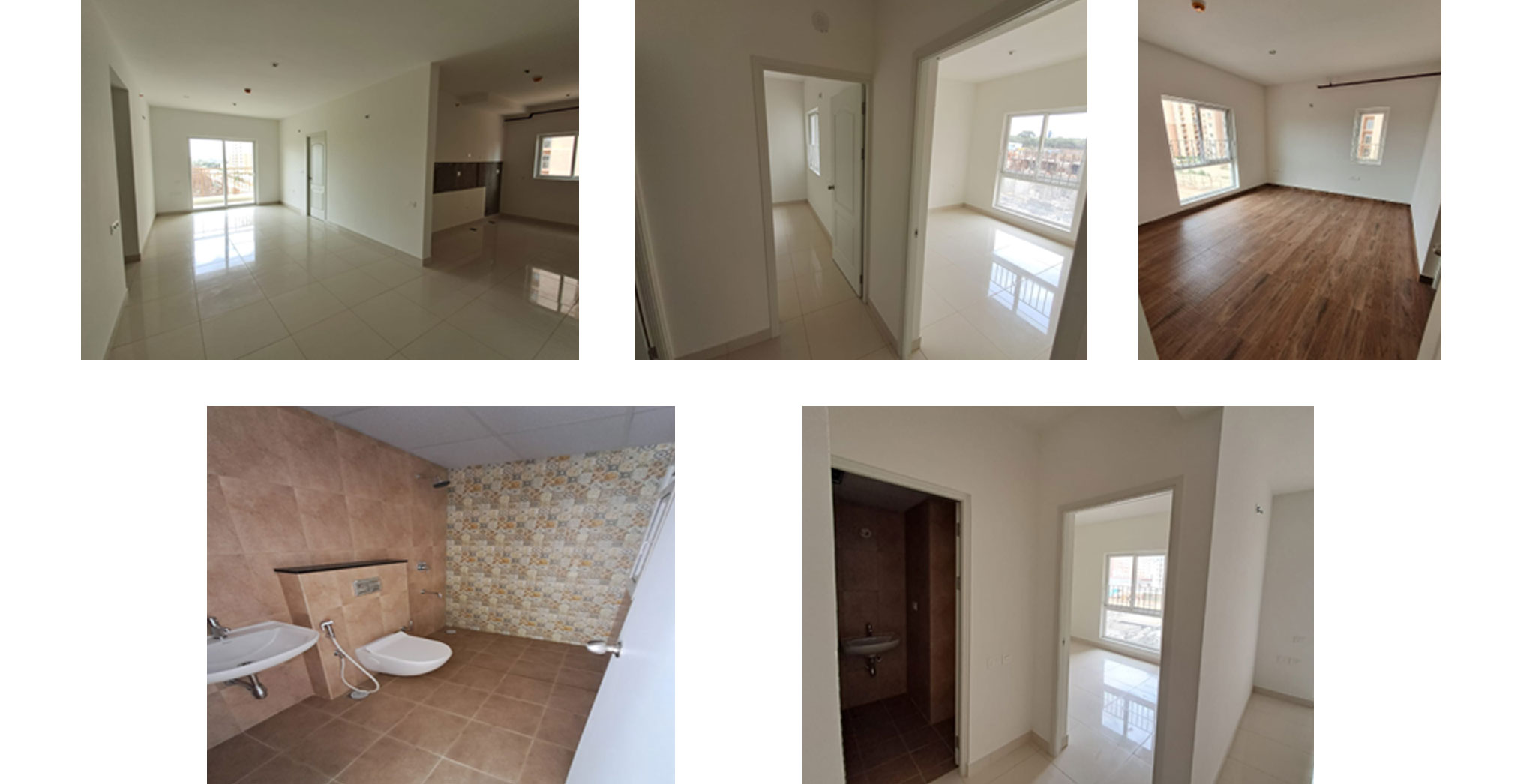

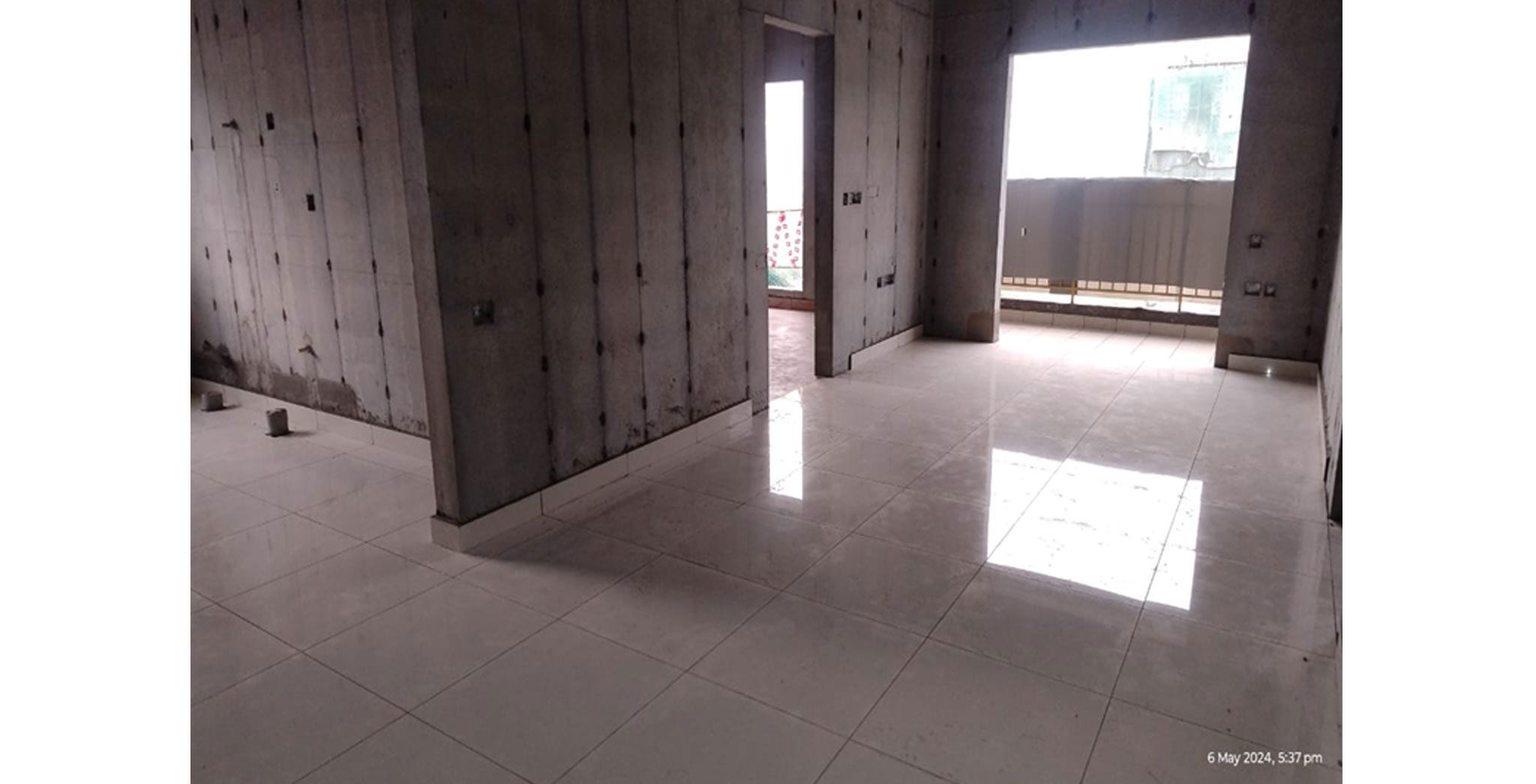

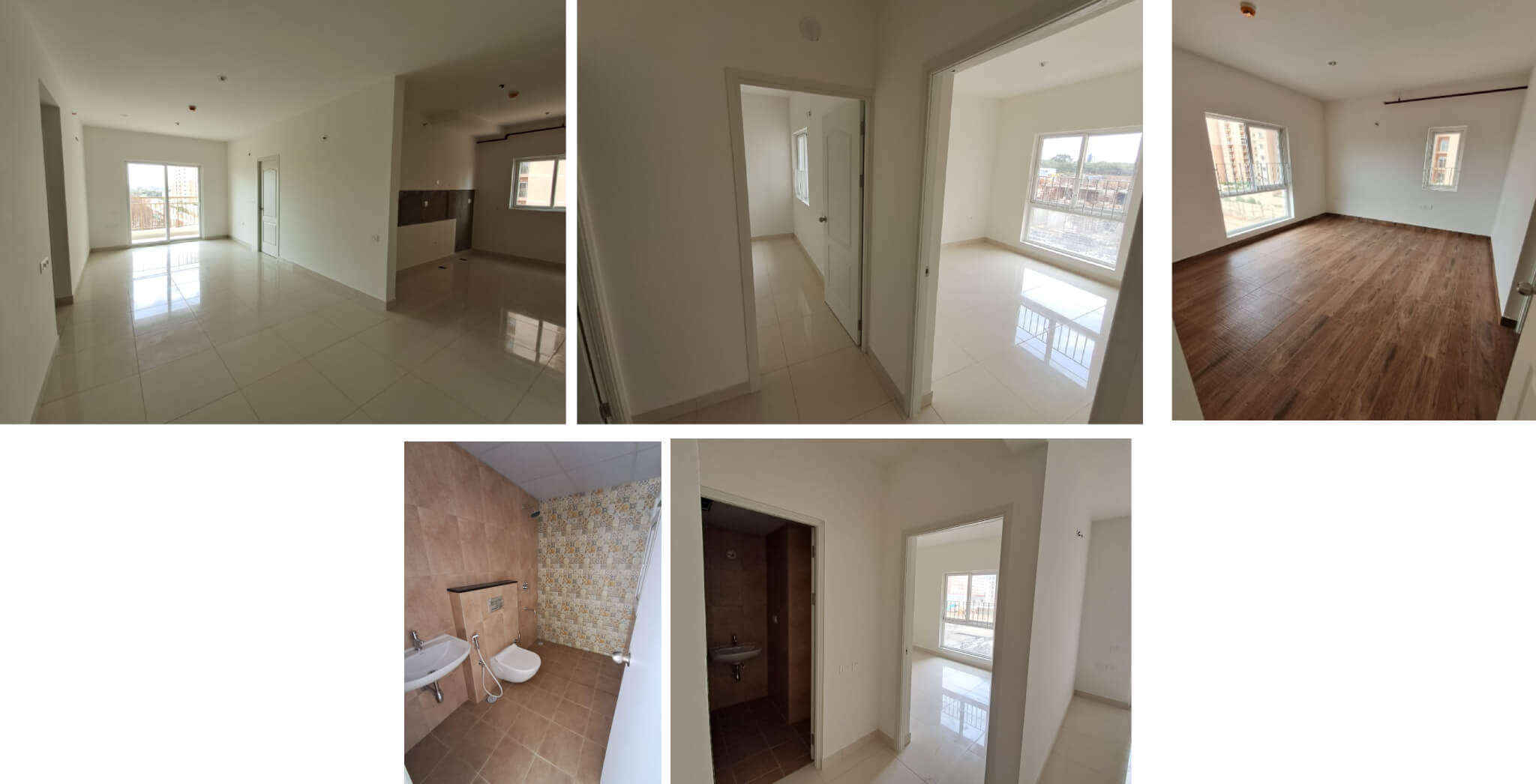

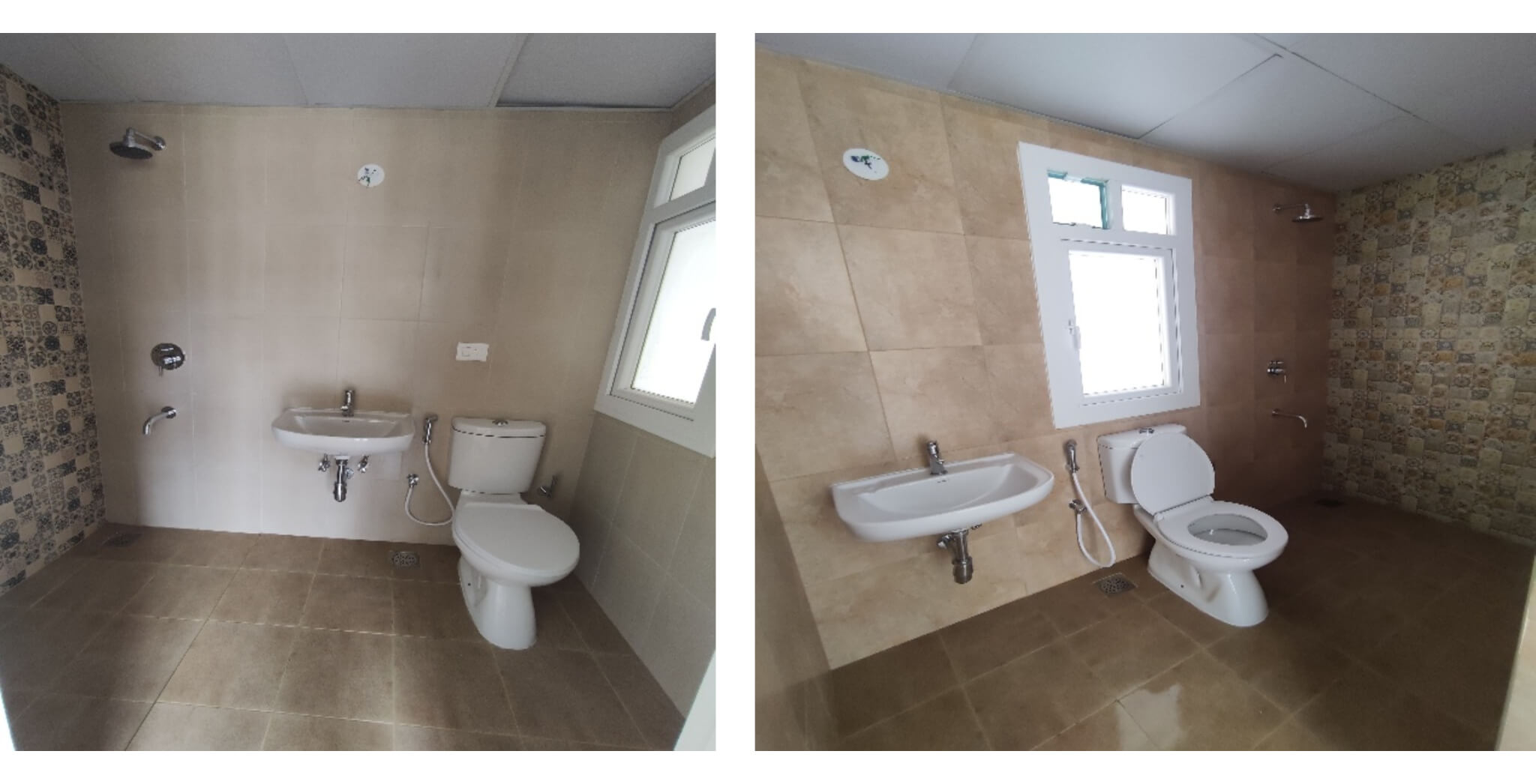

Finishing Work
Nov 2025
Finishing Work
Nov 2025

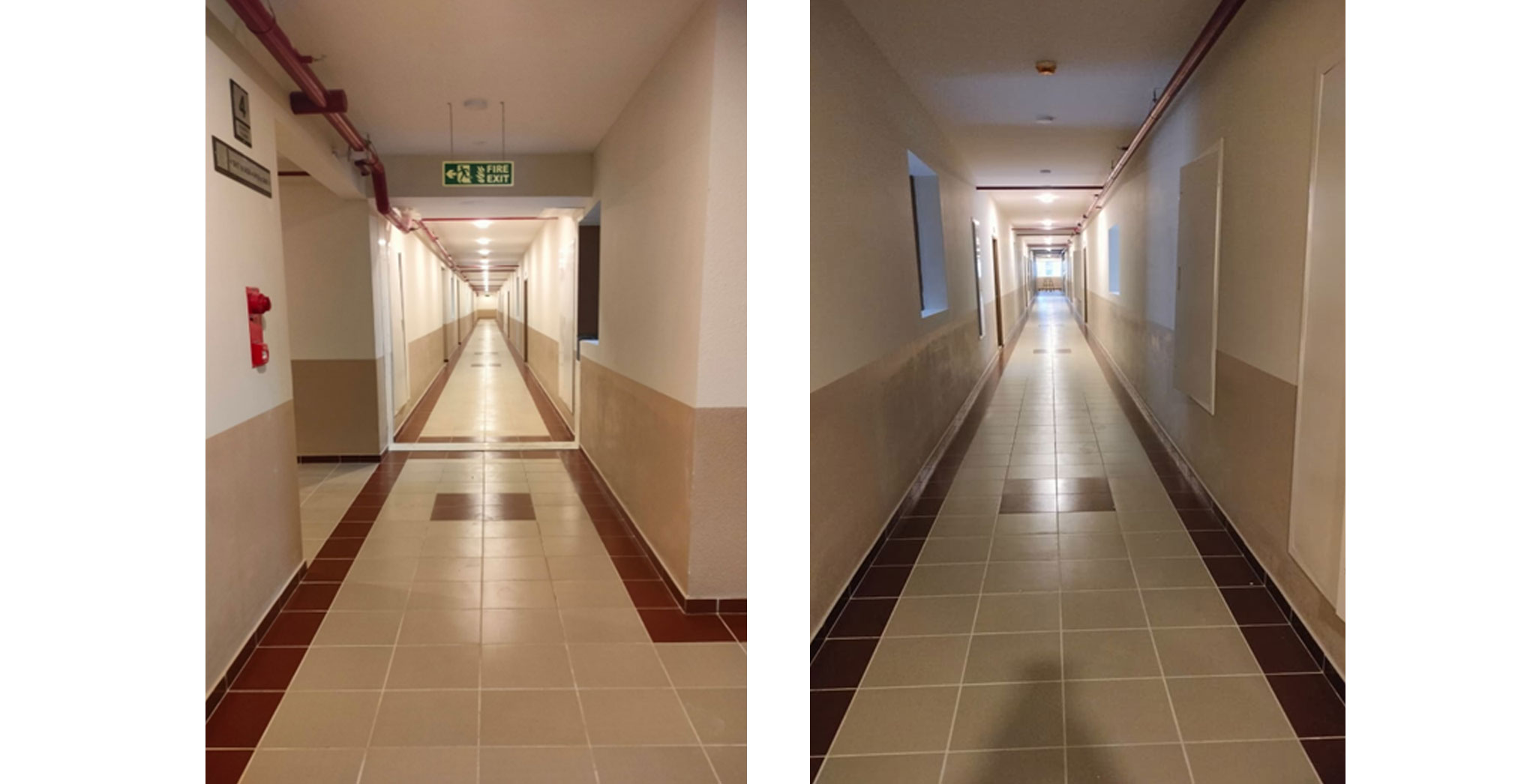

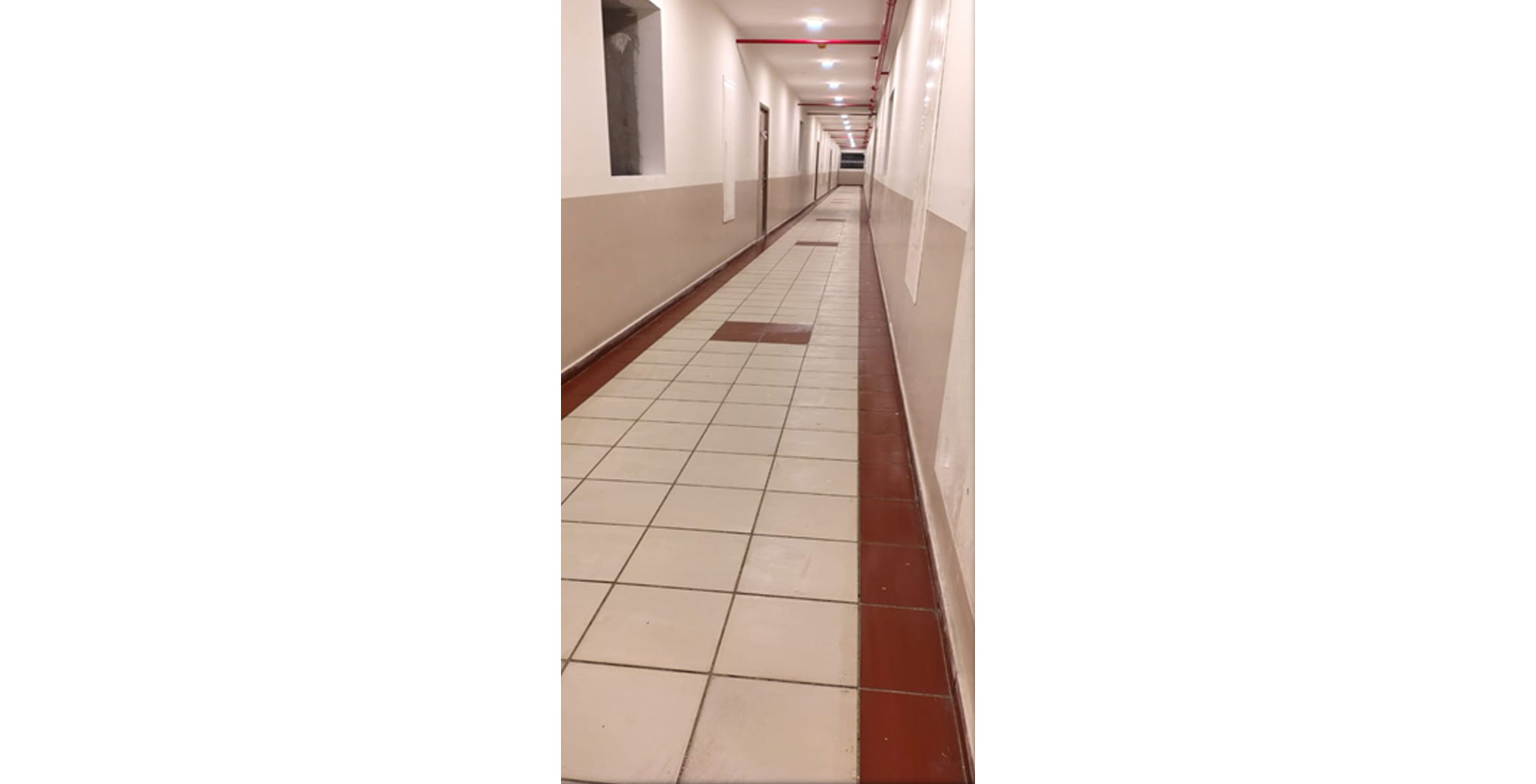

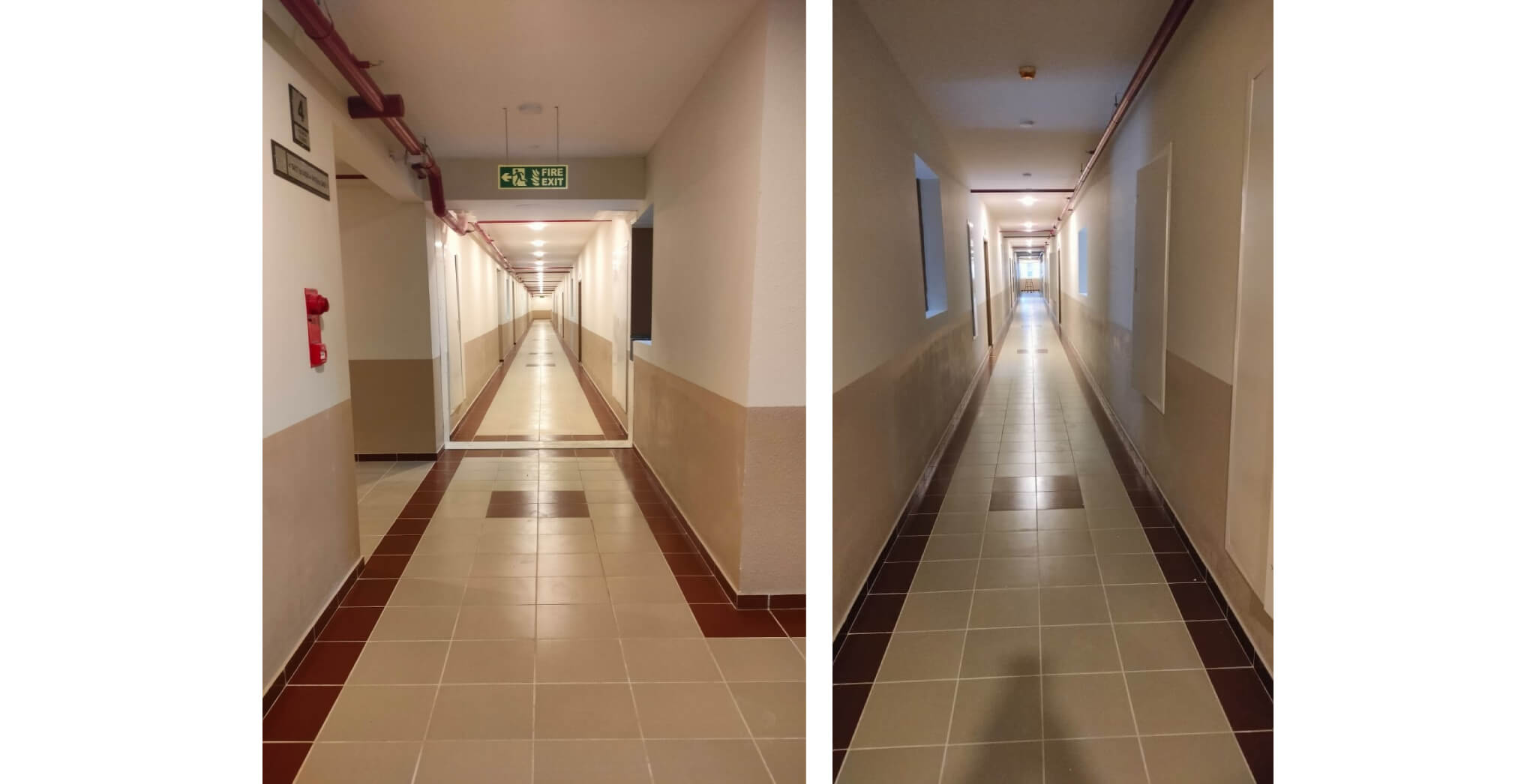

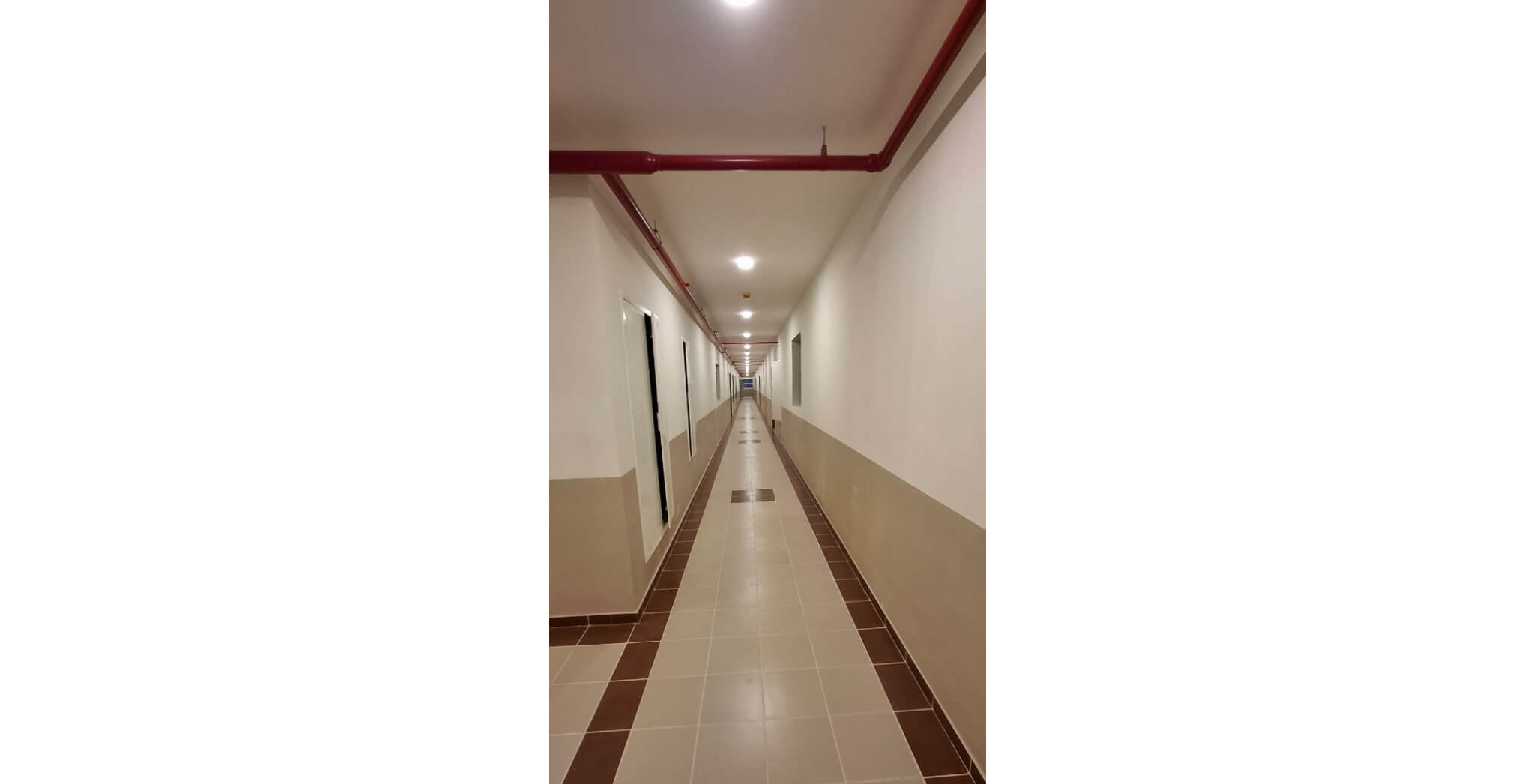

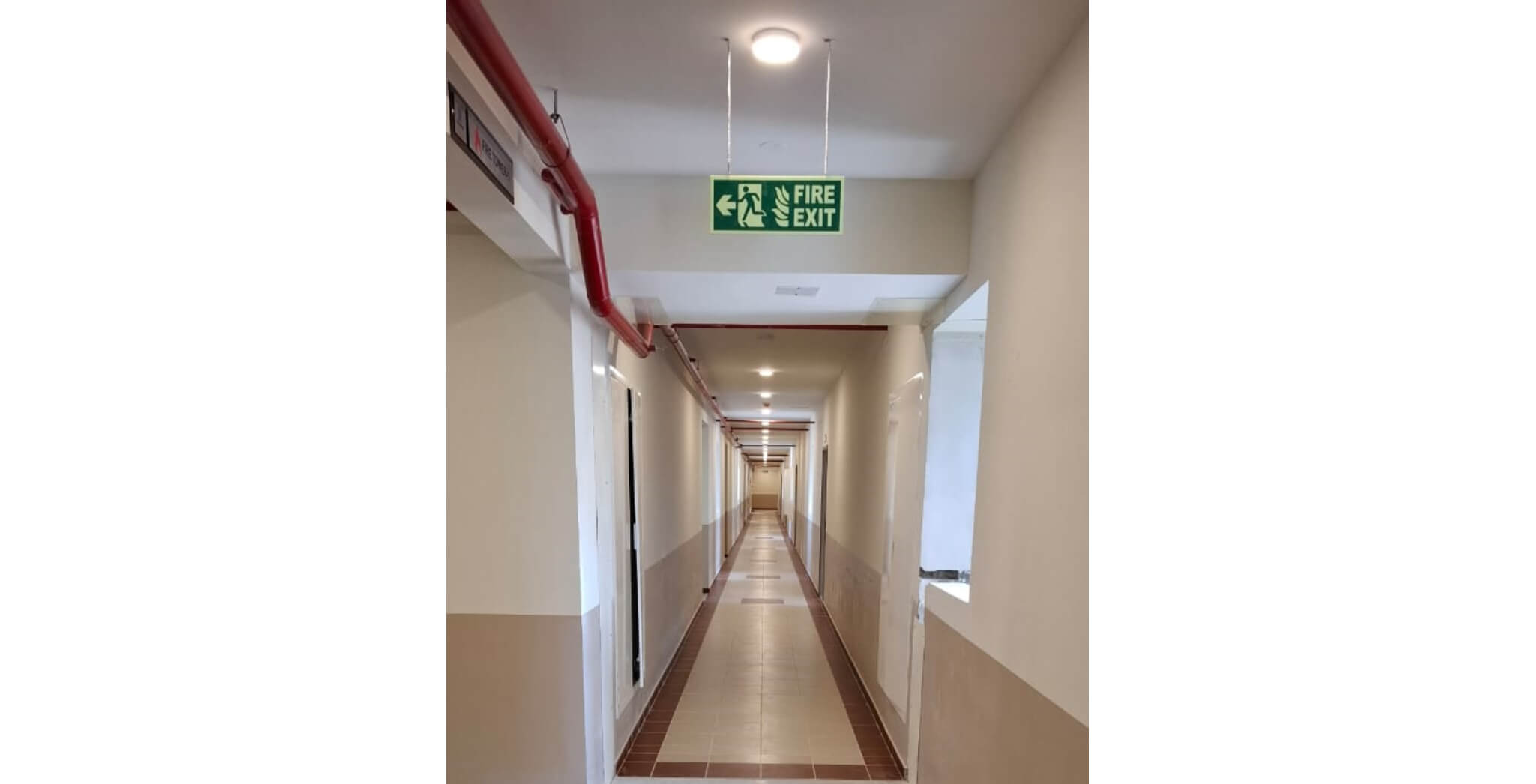

Corridor Area finishing works
Nov 2025

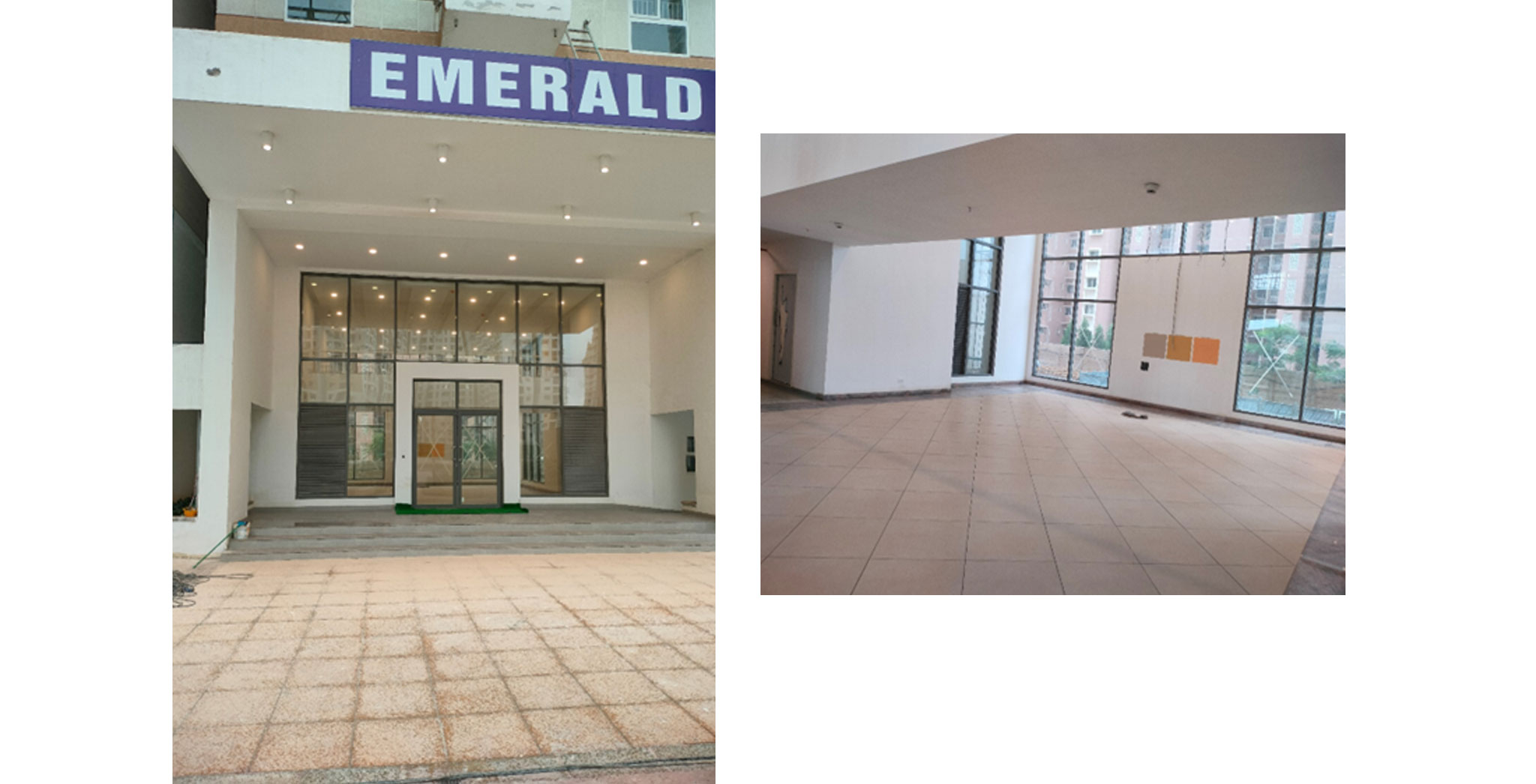

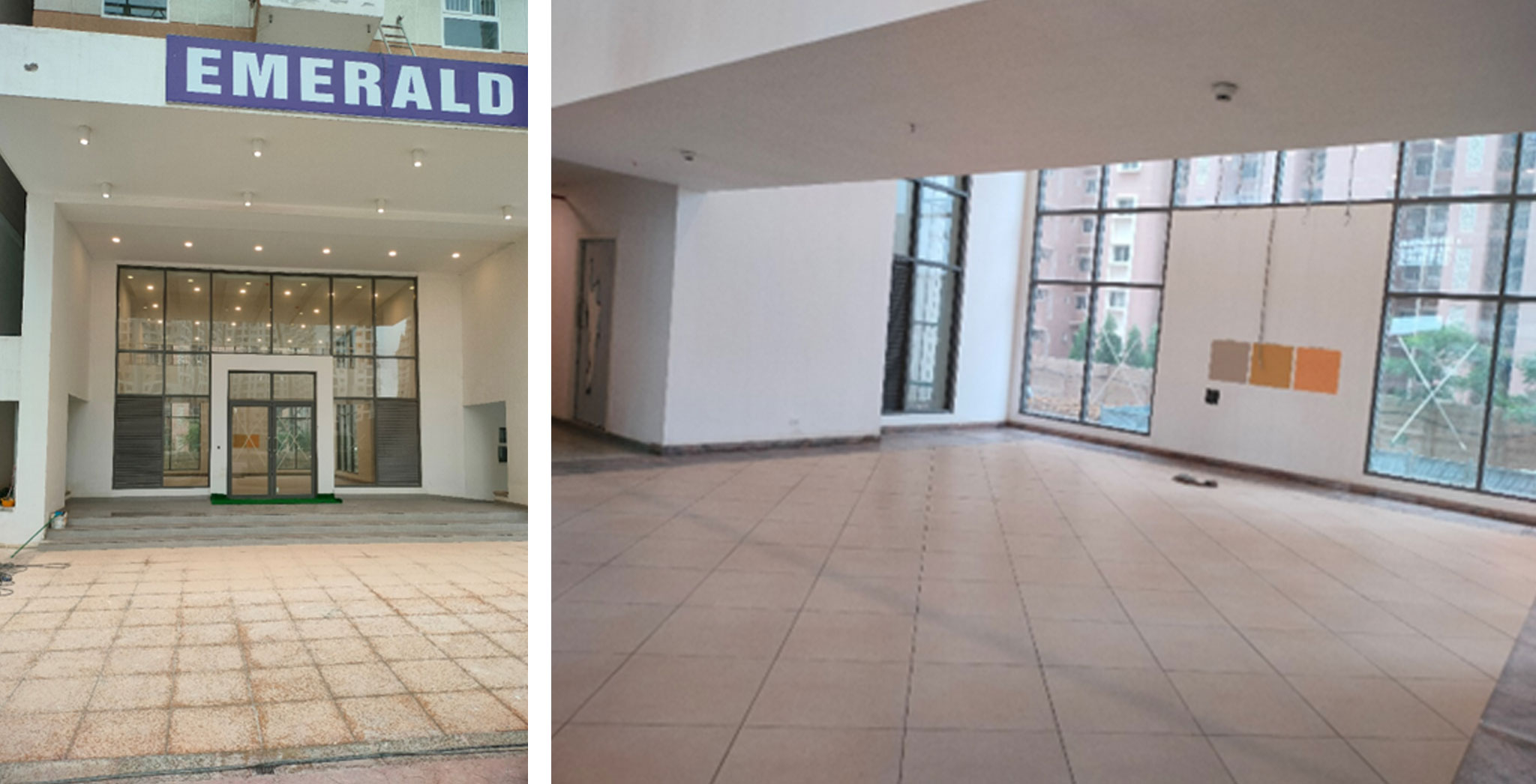

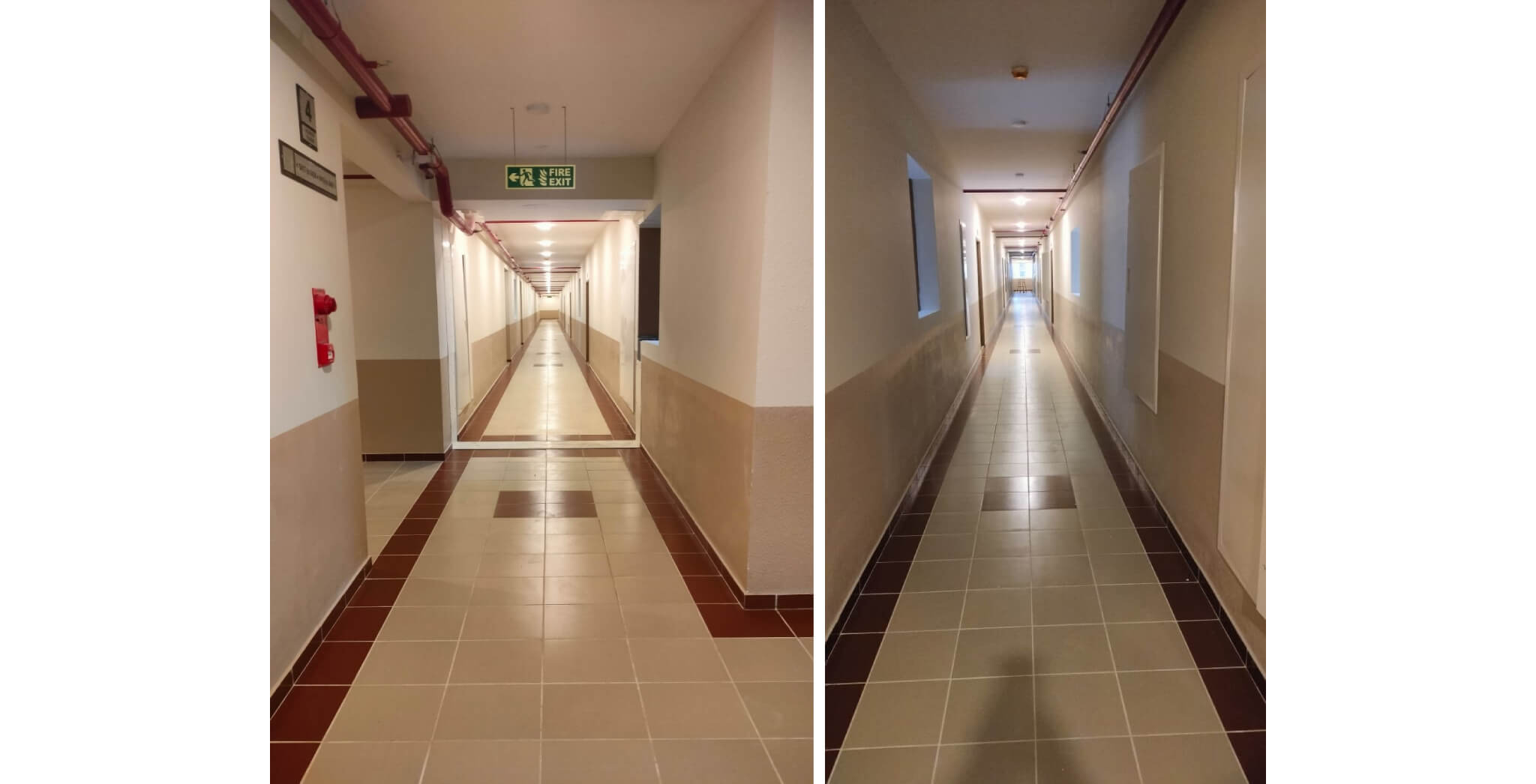

Emerald
Nov 2025

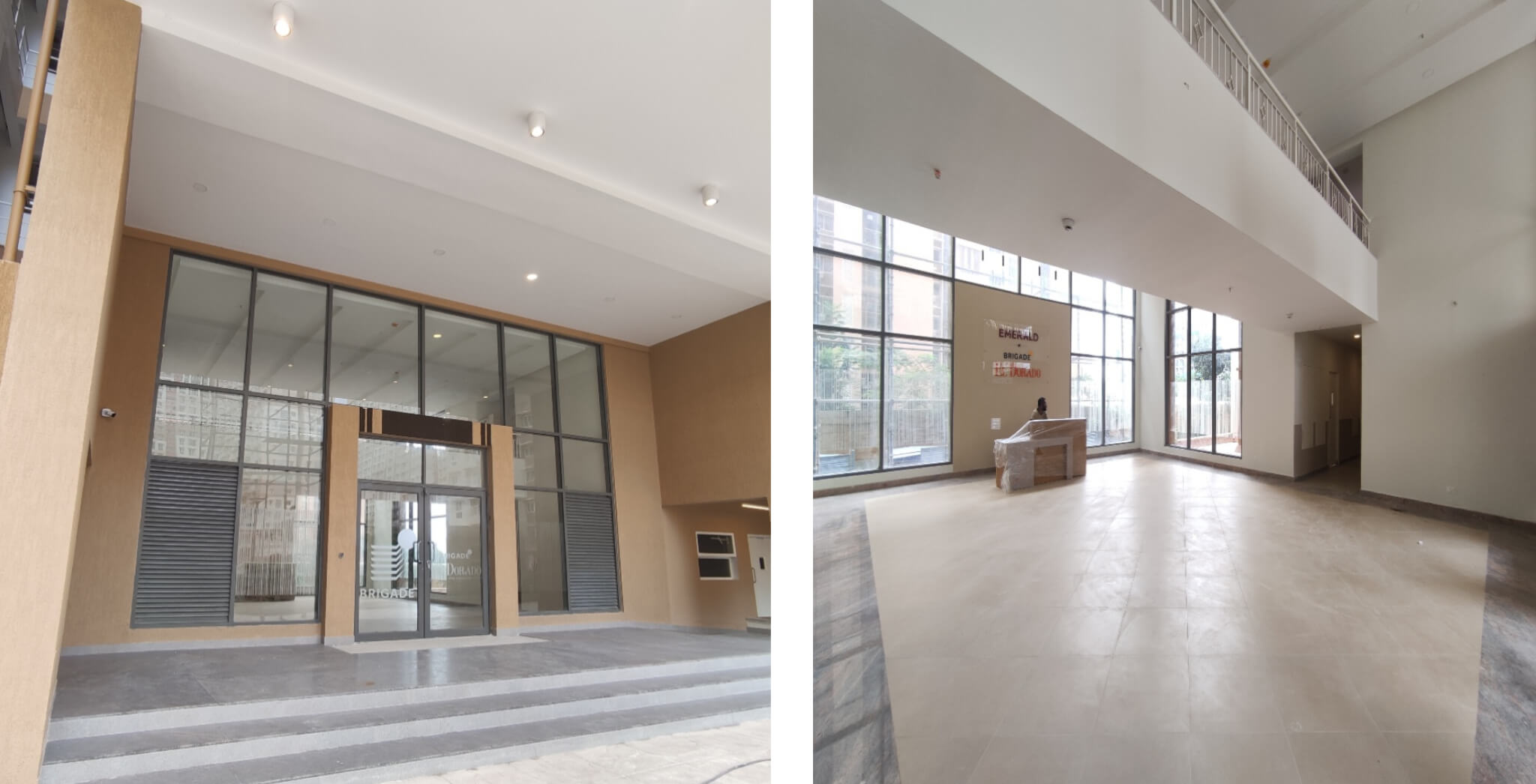

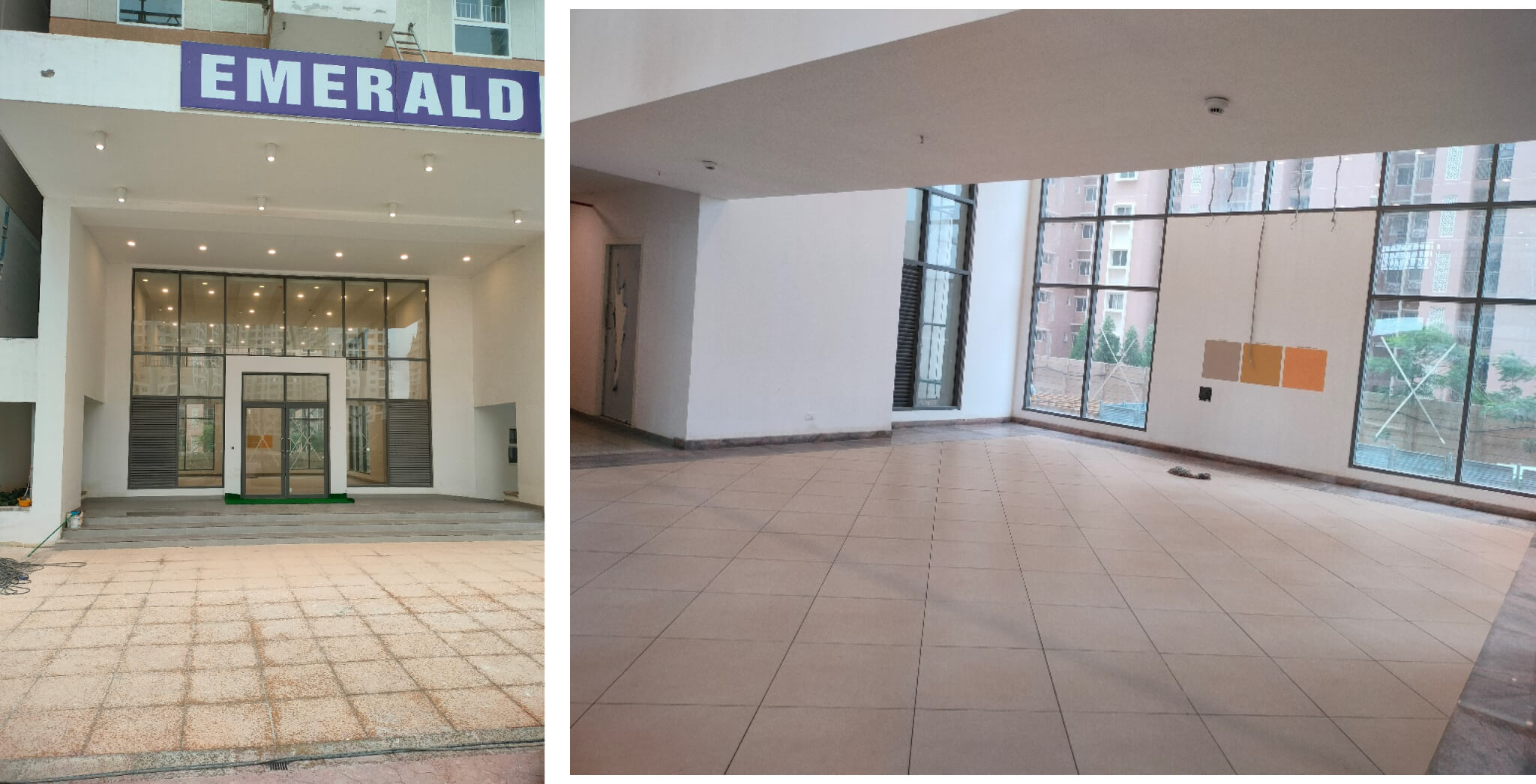

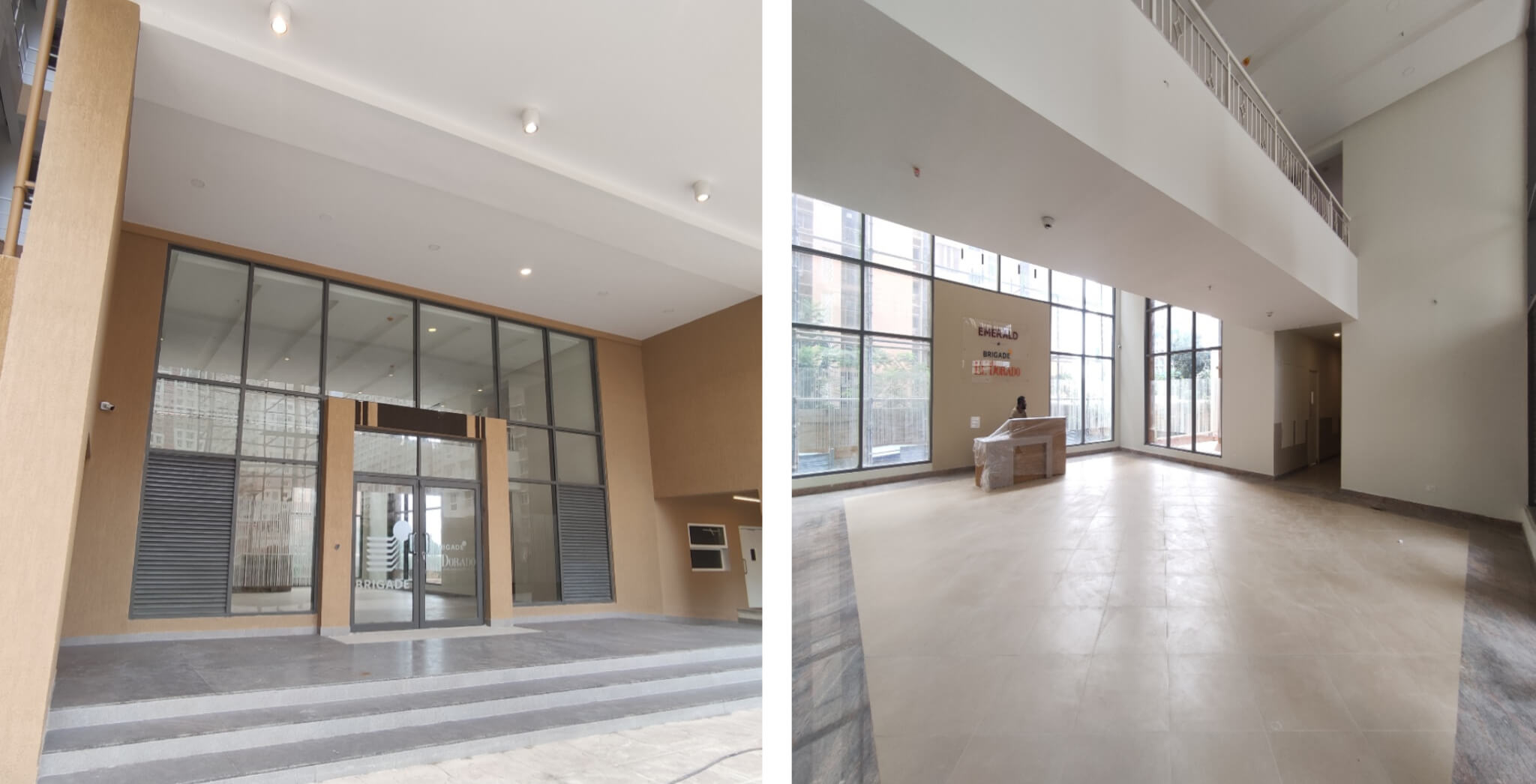

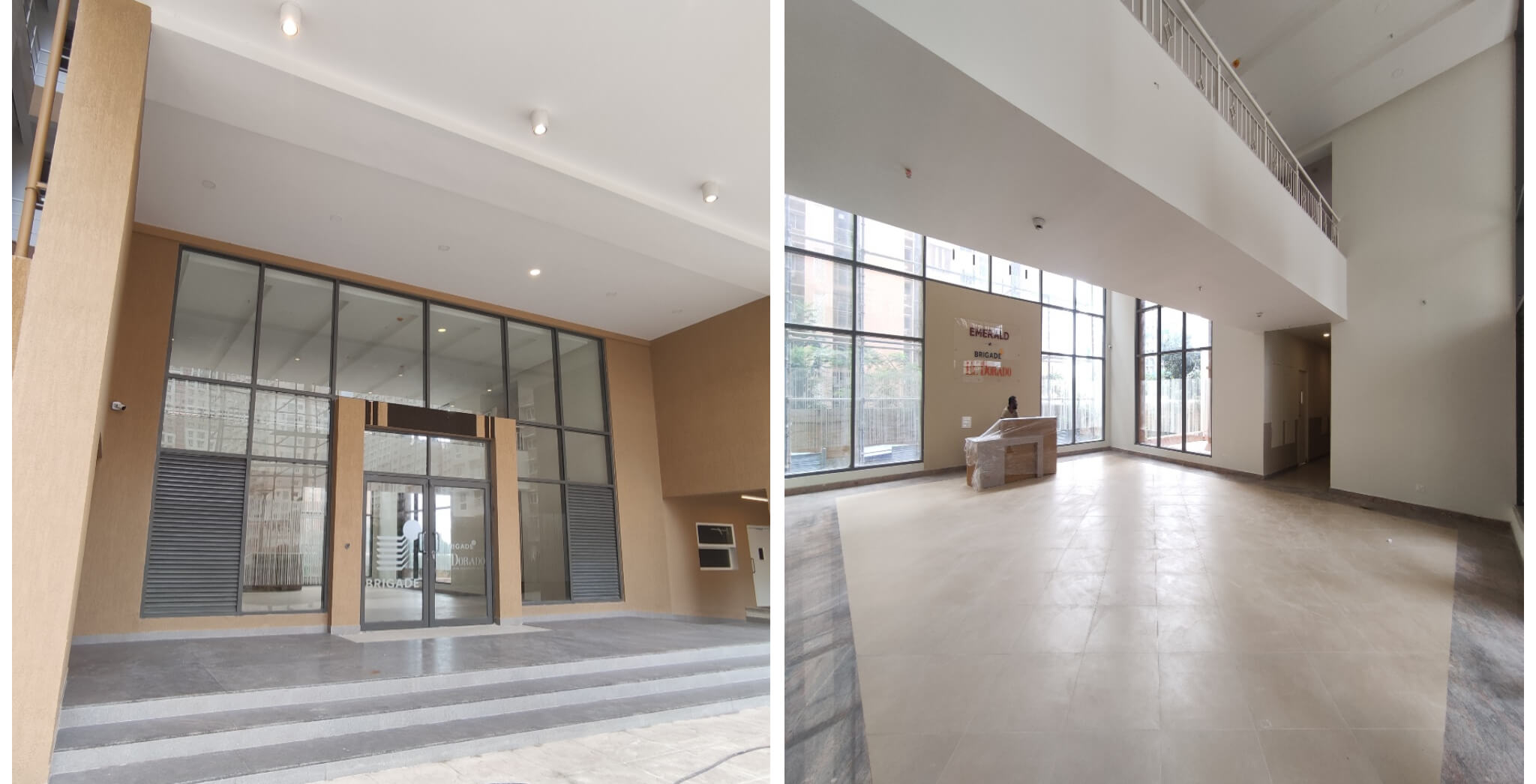

Ground floor triple height entrance and reception area
Nov 2025

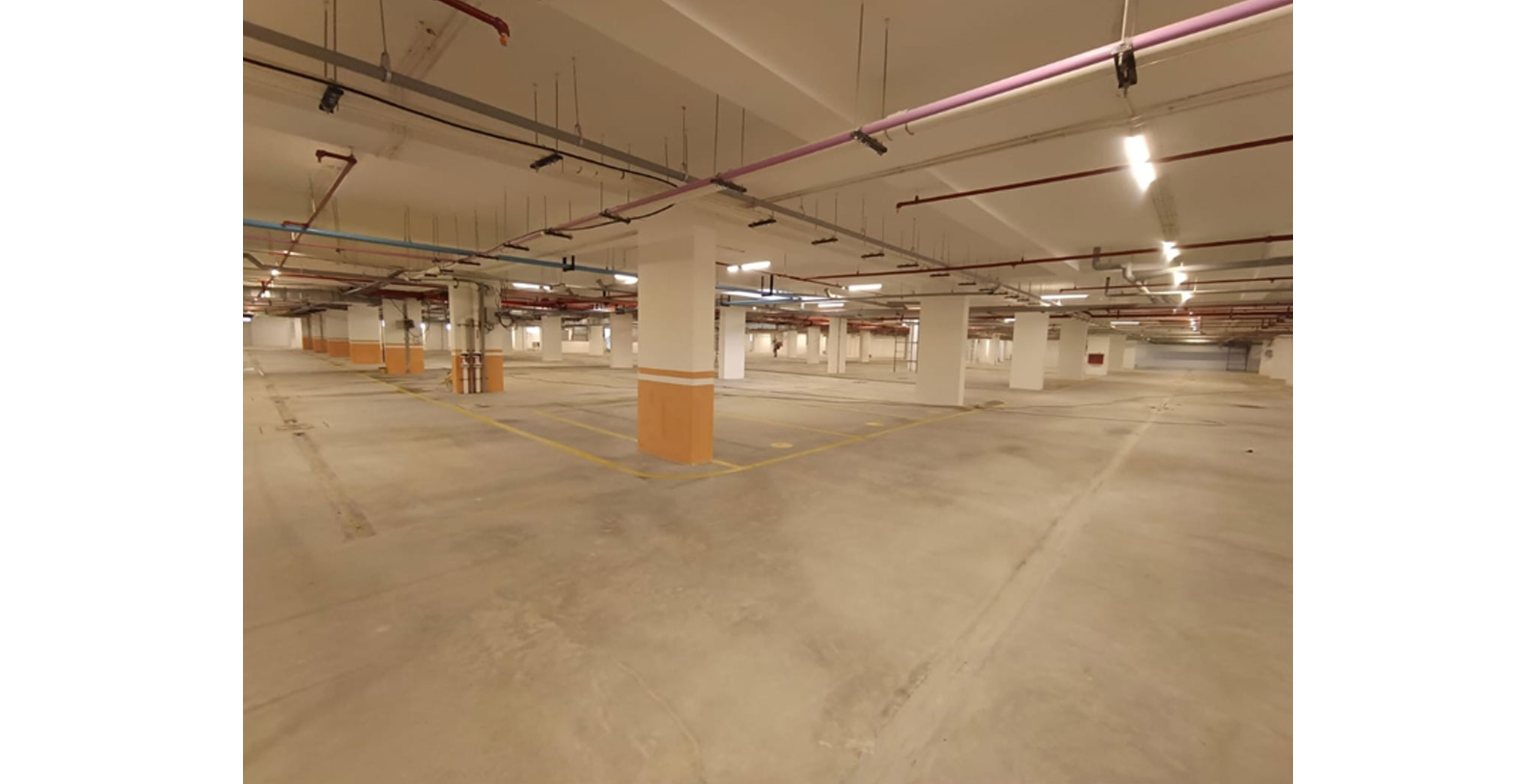

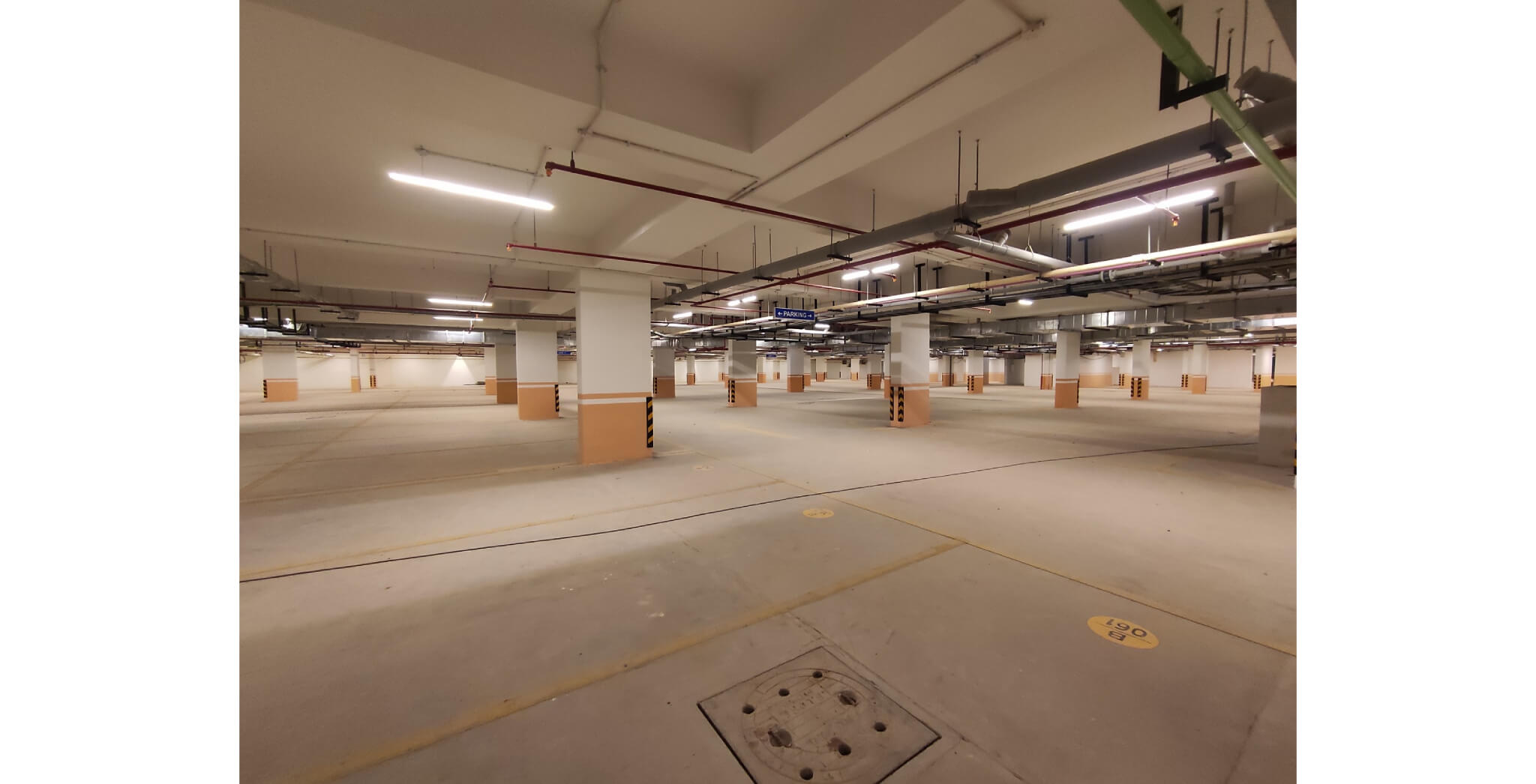

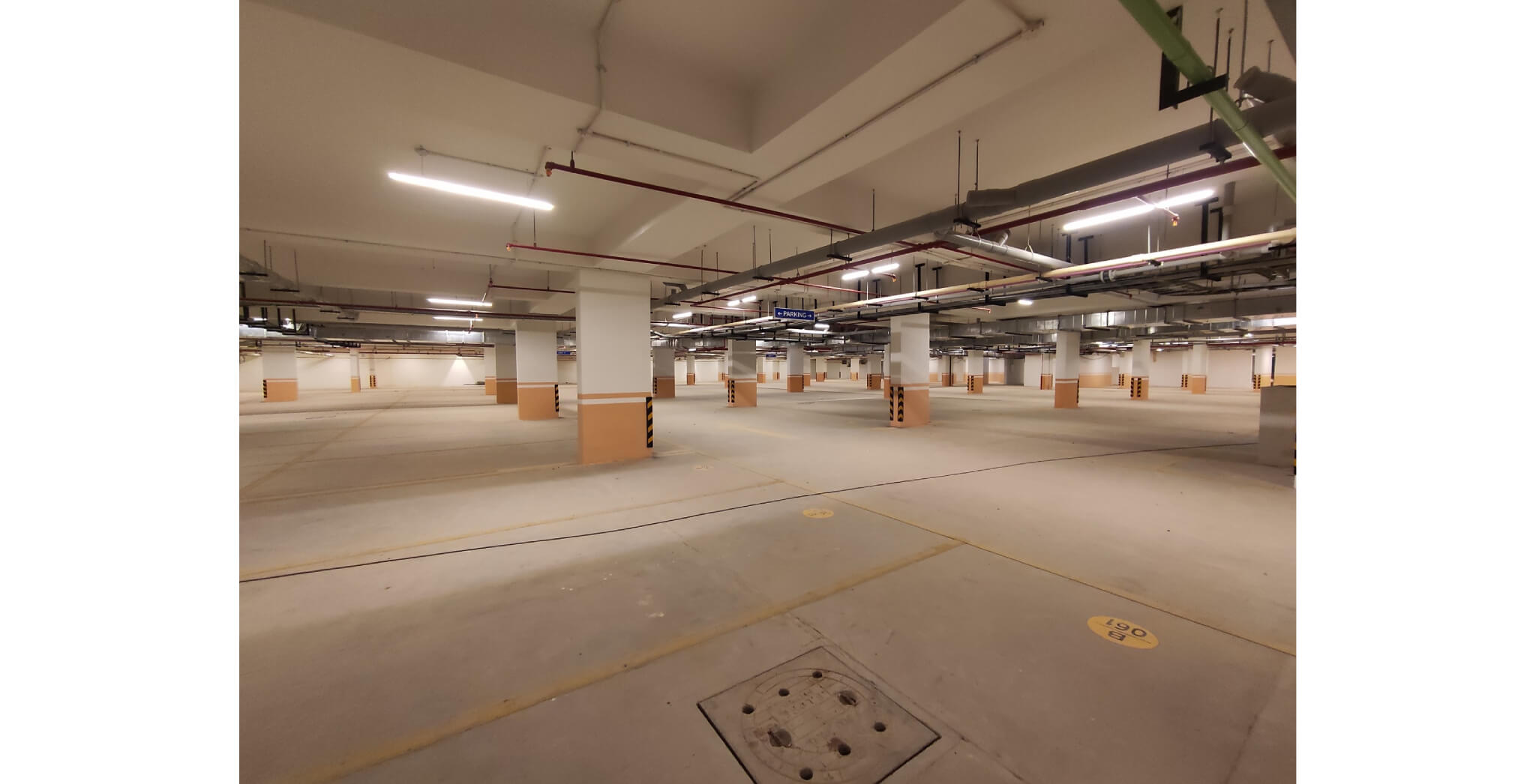

Basement finishes completed
Nov 2025

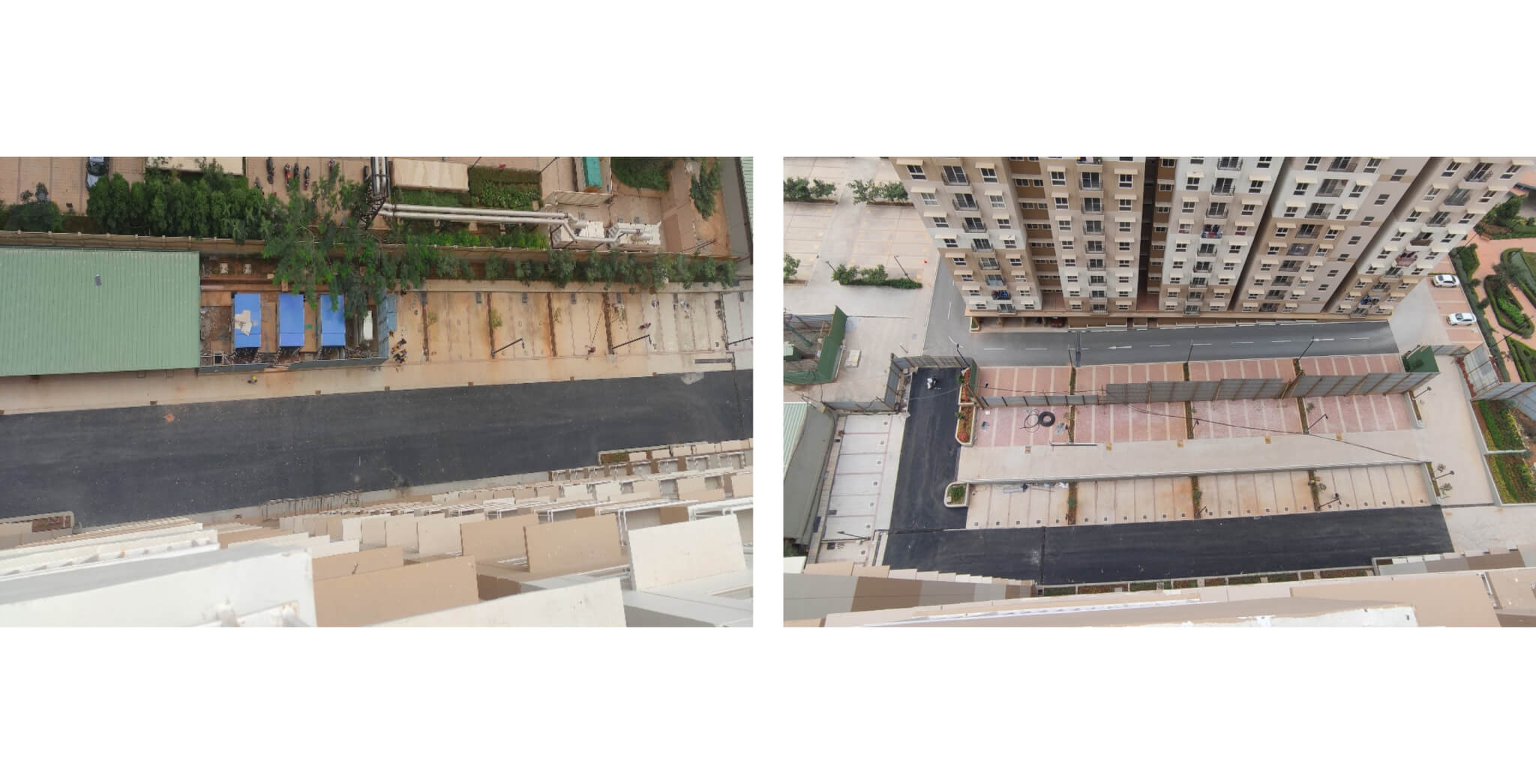

South & west face road and car parking area works completed
Nov 2025

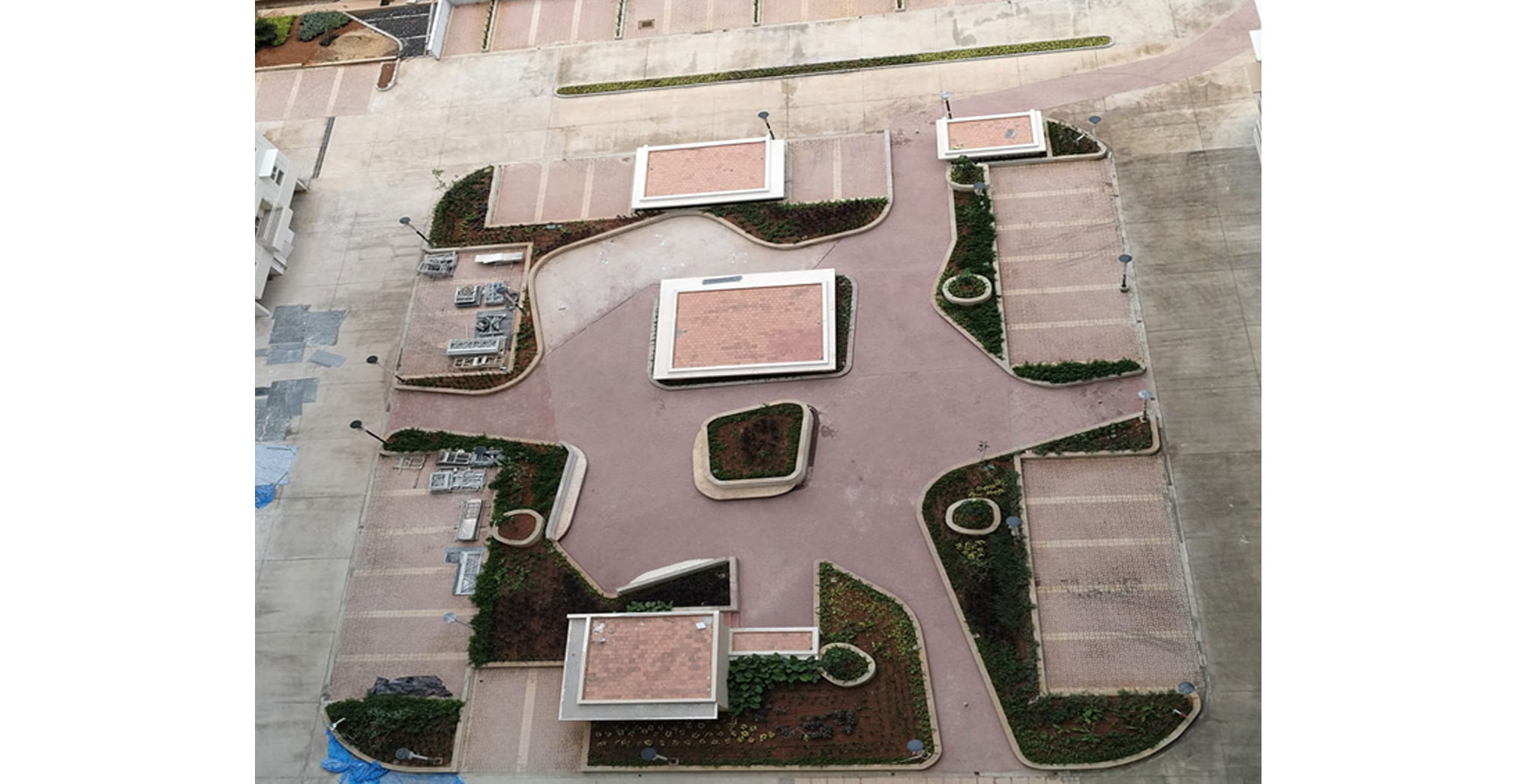

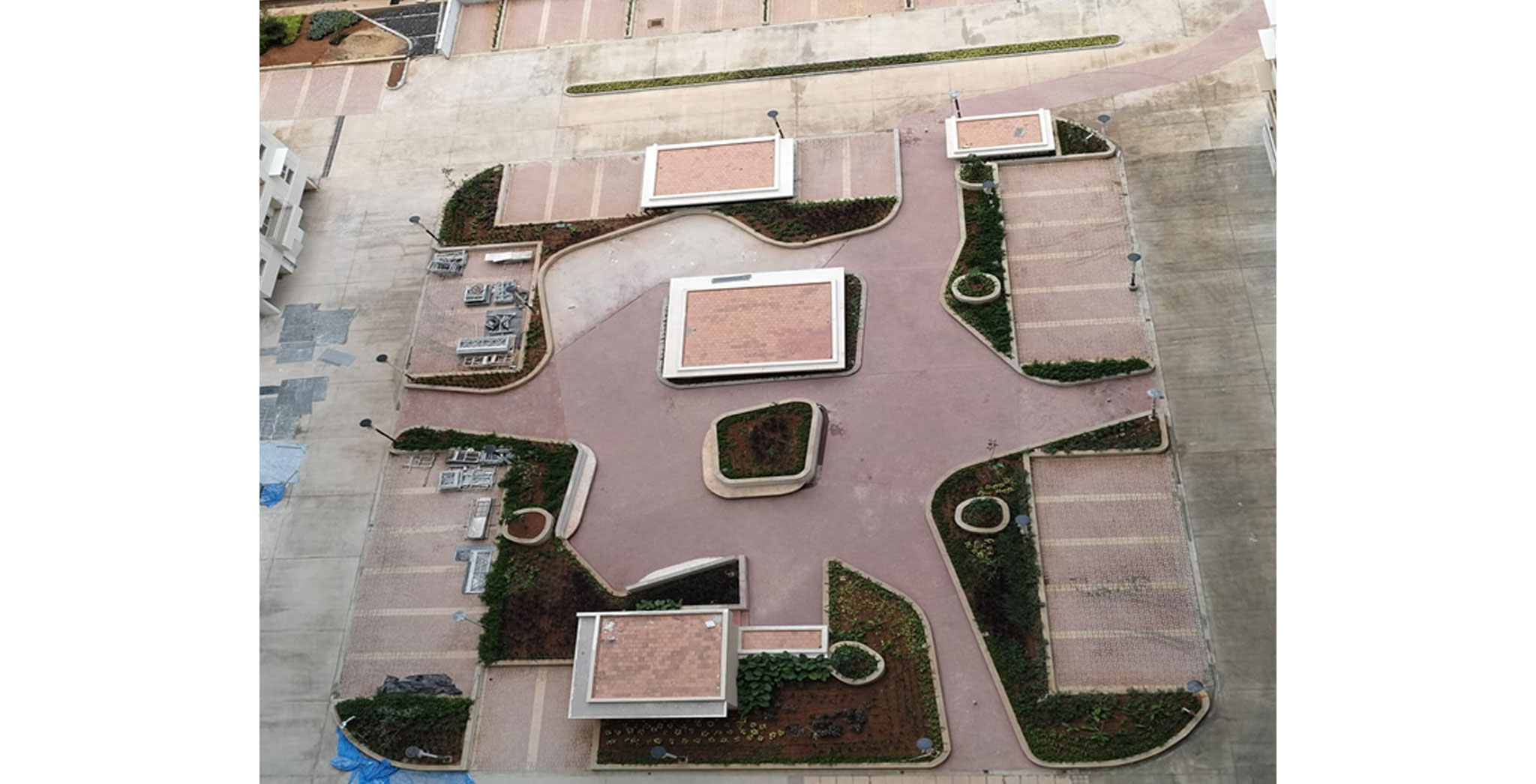

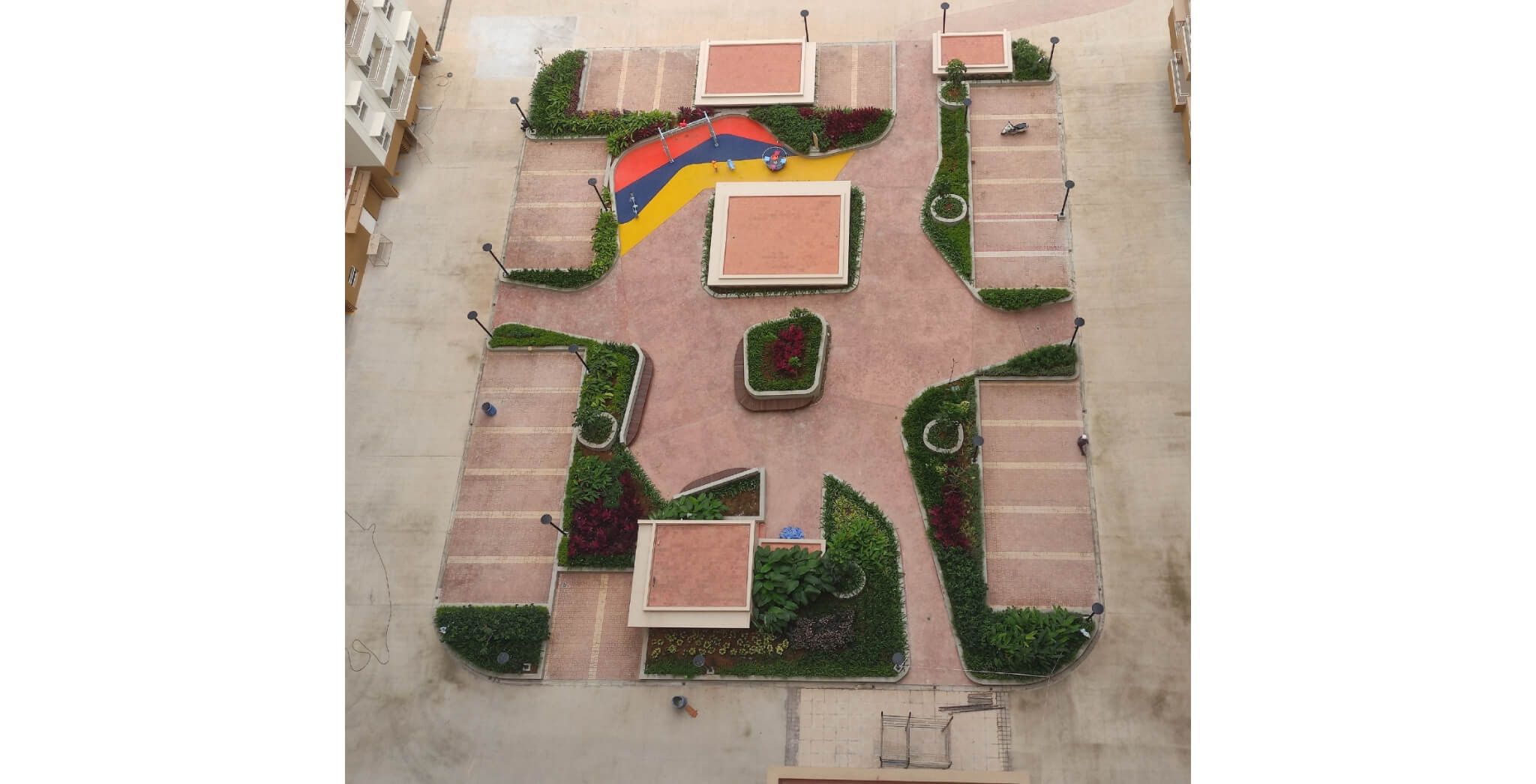

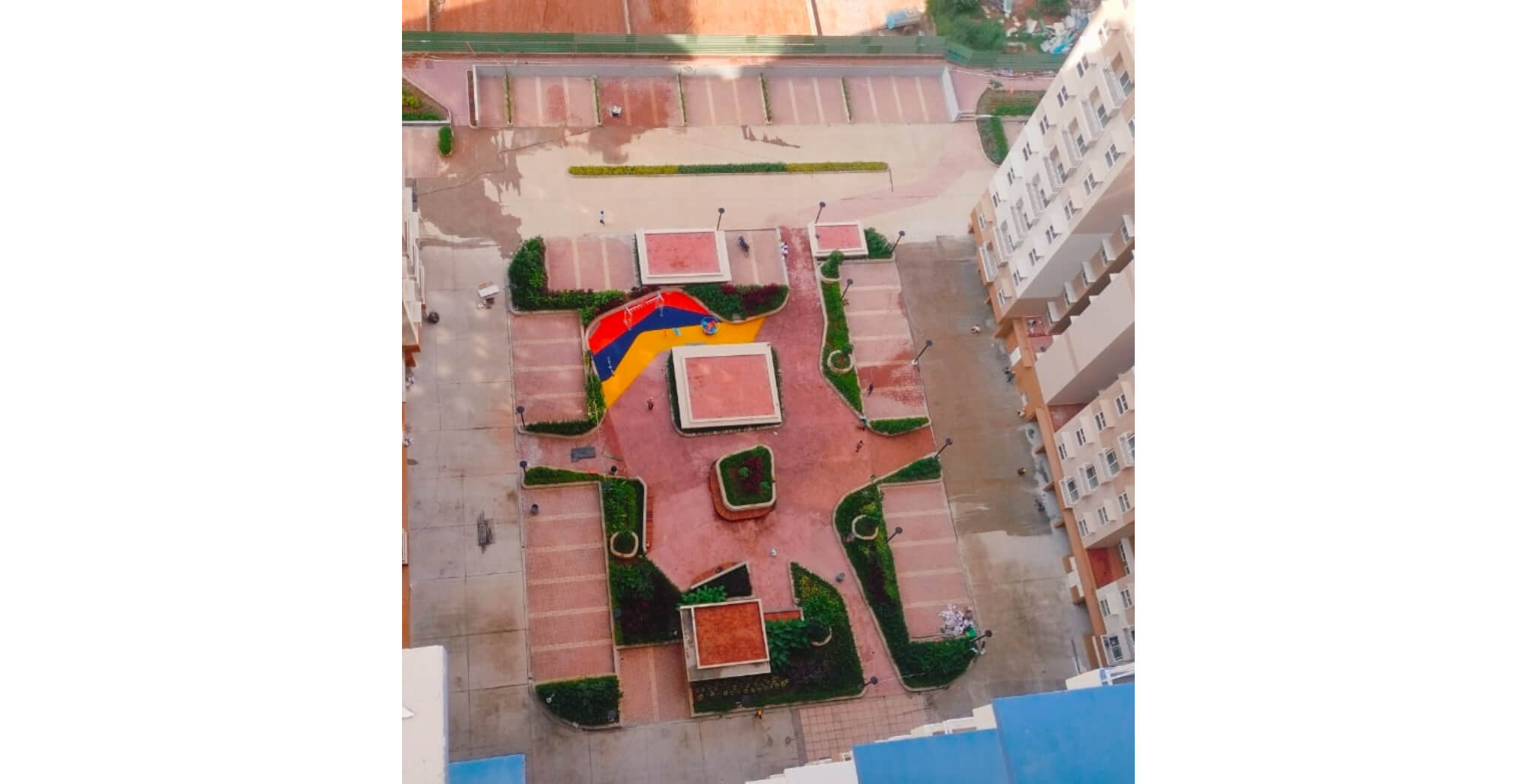

Podium Central Courtyard Area Hardscape and Softscape work completed
Nov 2025

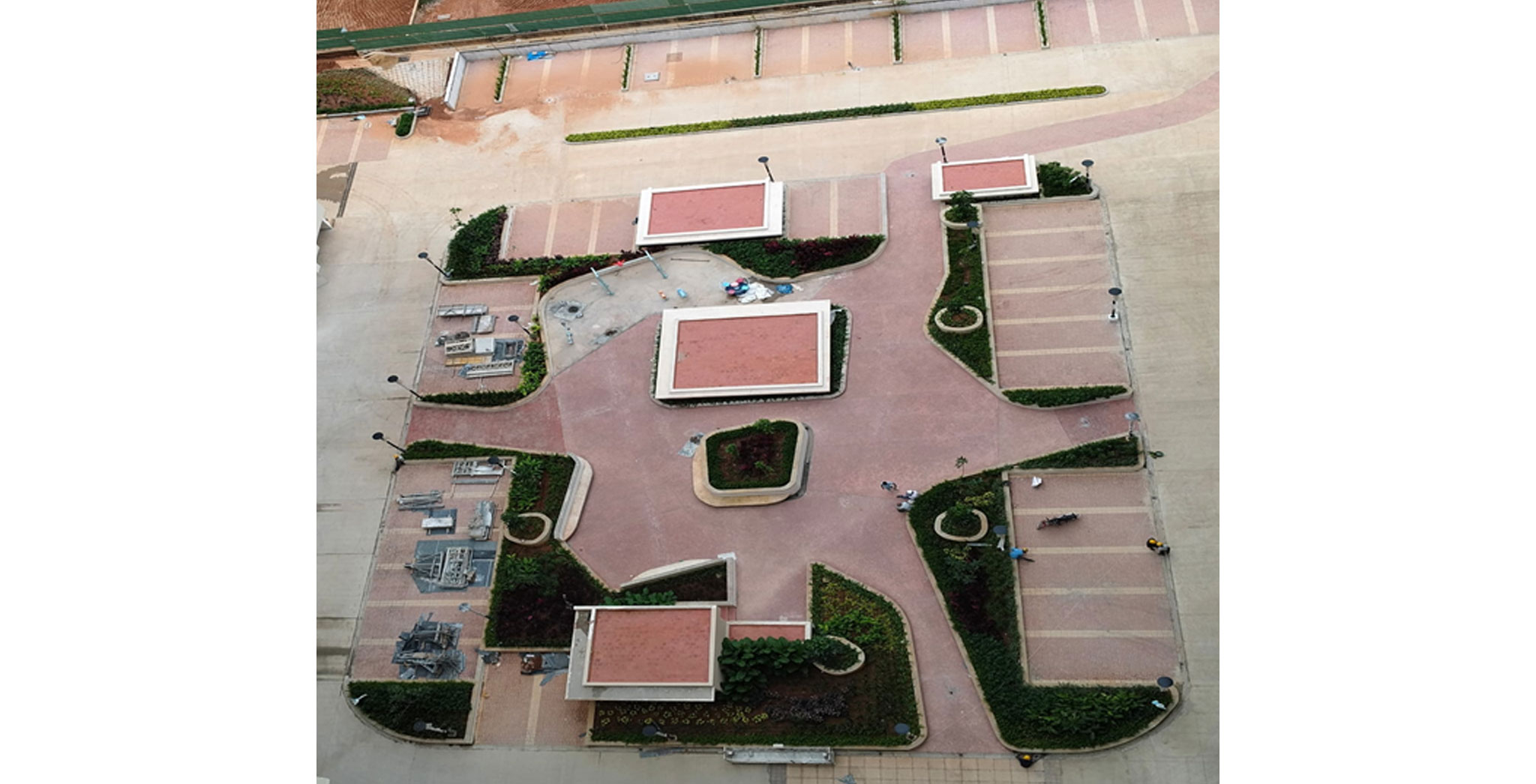

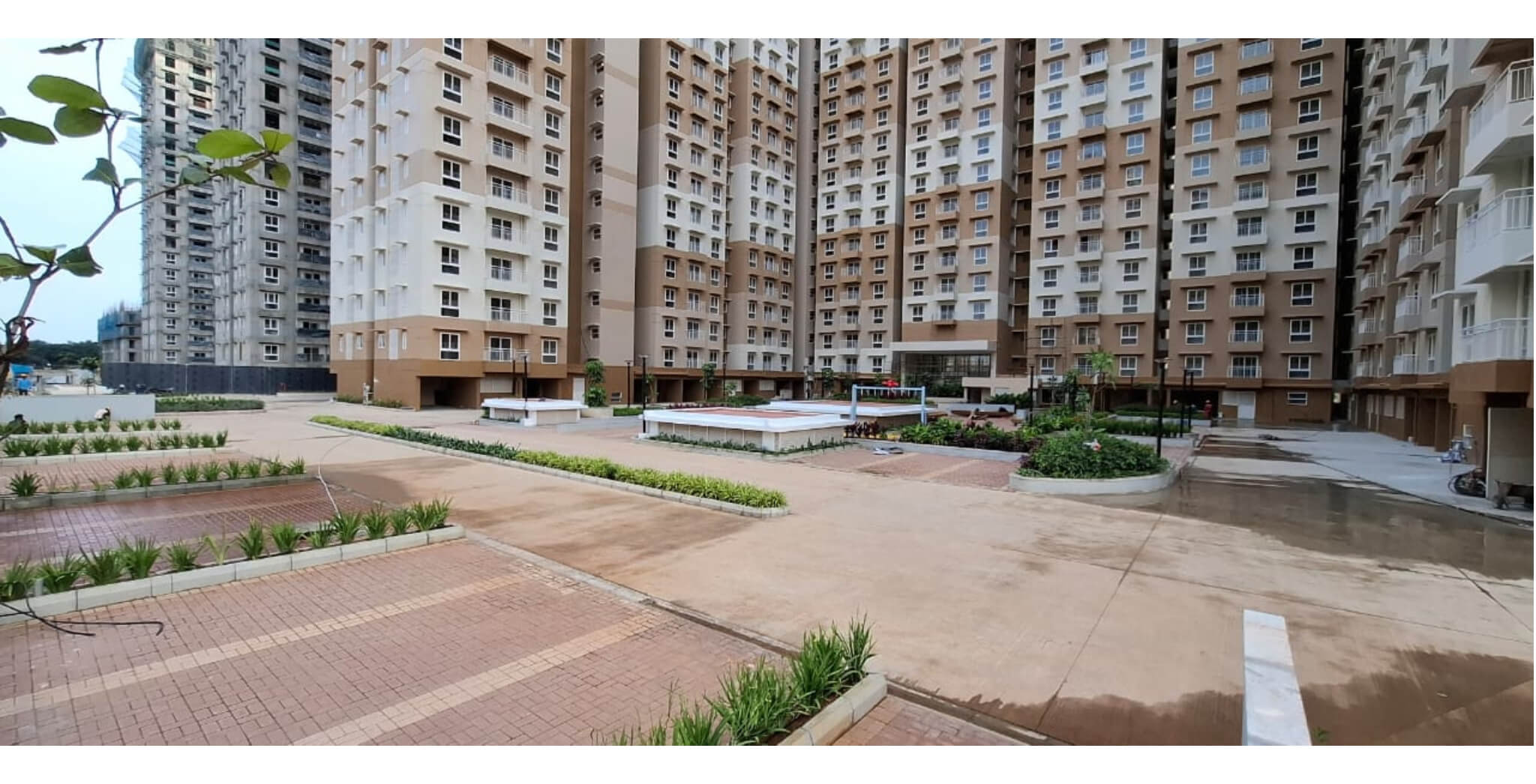

Podium Central Courtyard Area Hardscape and Softscape work completed
Nov 2025
Structure completed
Oct 2025
East Wing
Oct 2025
South Wing
Oct 2025
West Wing
Oct 2025

East ,South and West wing External Painting works in progress
Oct 2025

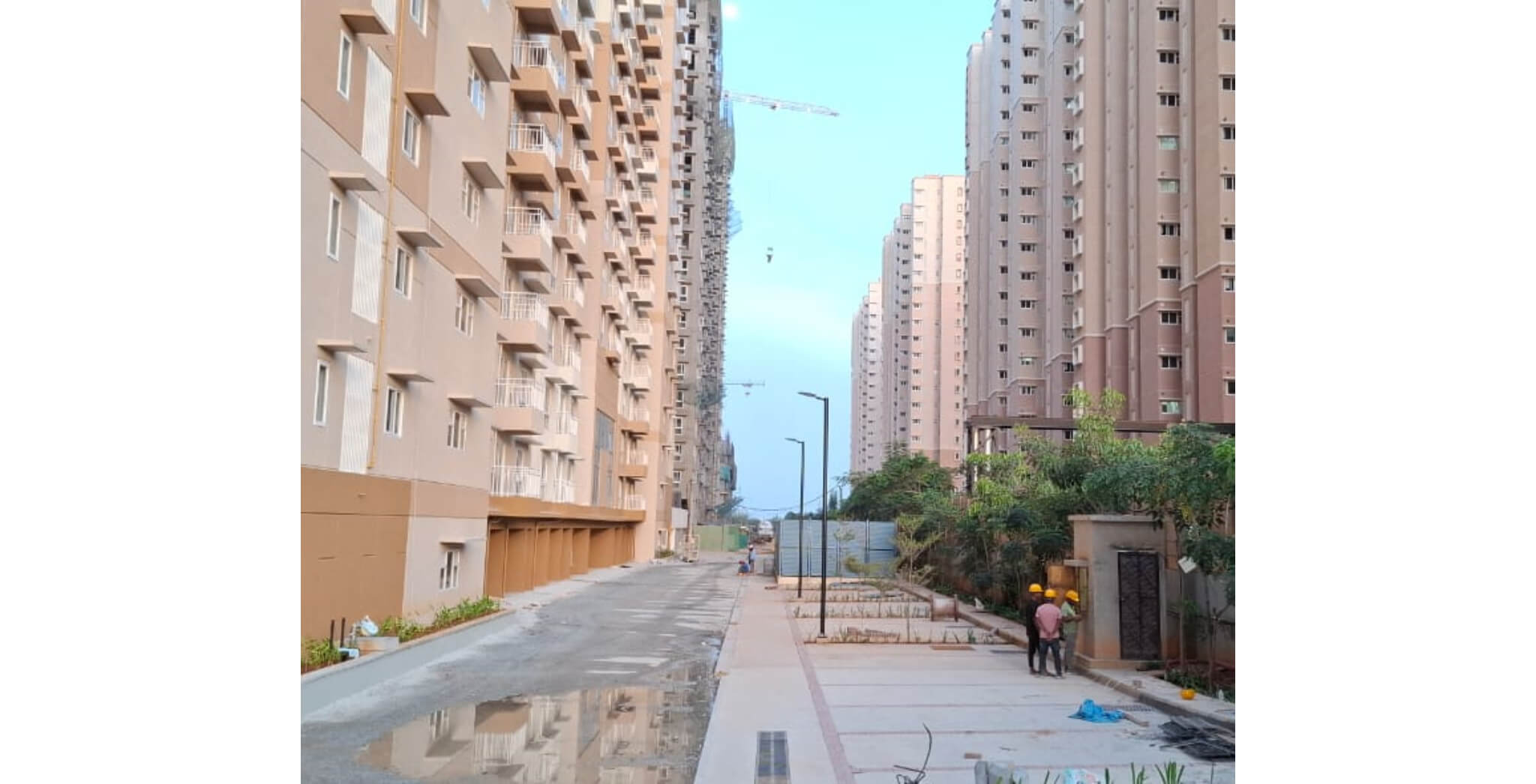

South face road and car parking area WIP
Oct 2025

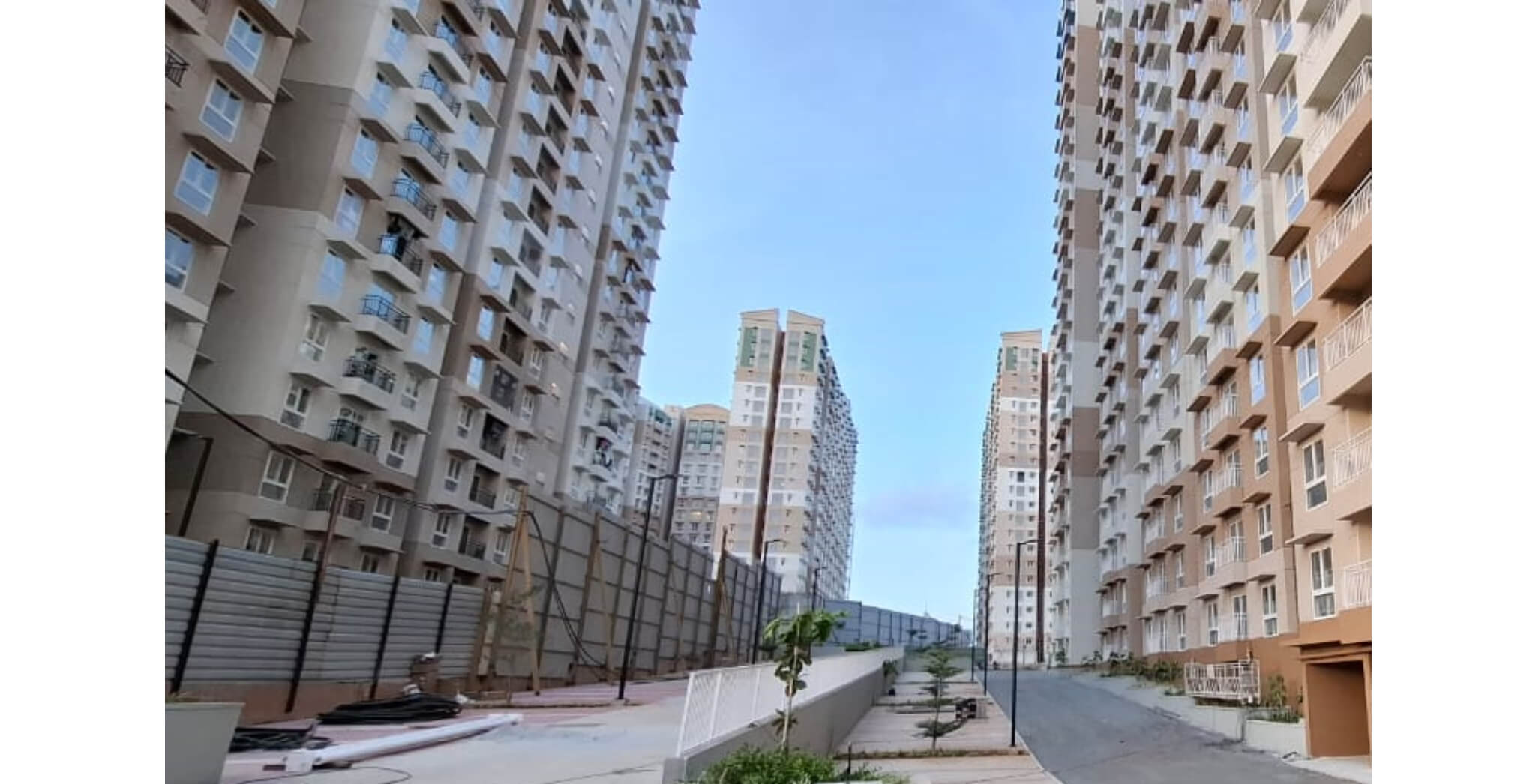

West side driveway and car parking area WIP
Oct 2025
Basement Painting and Services work is completed
Oct 2025

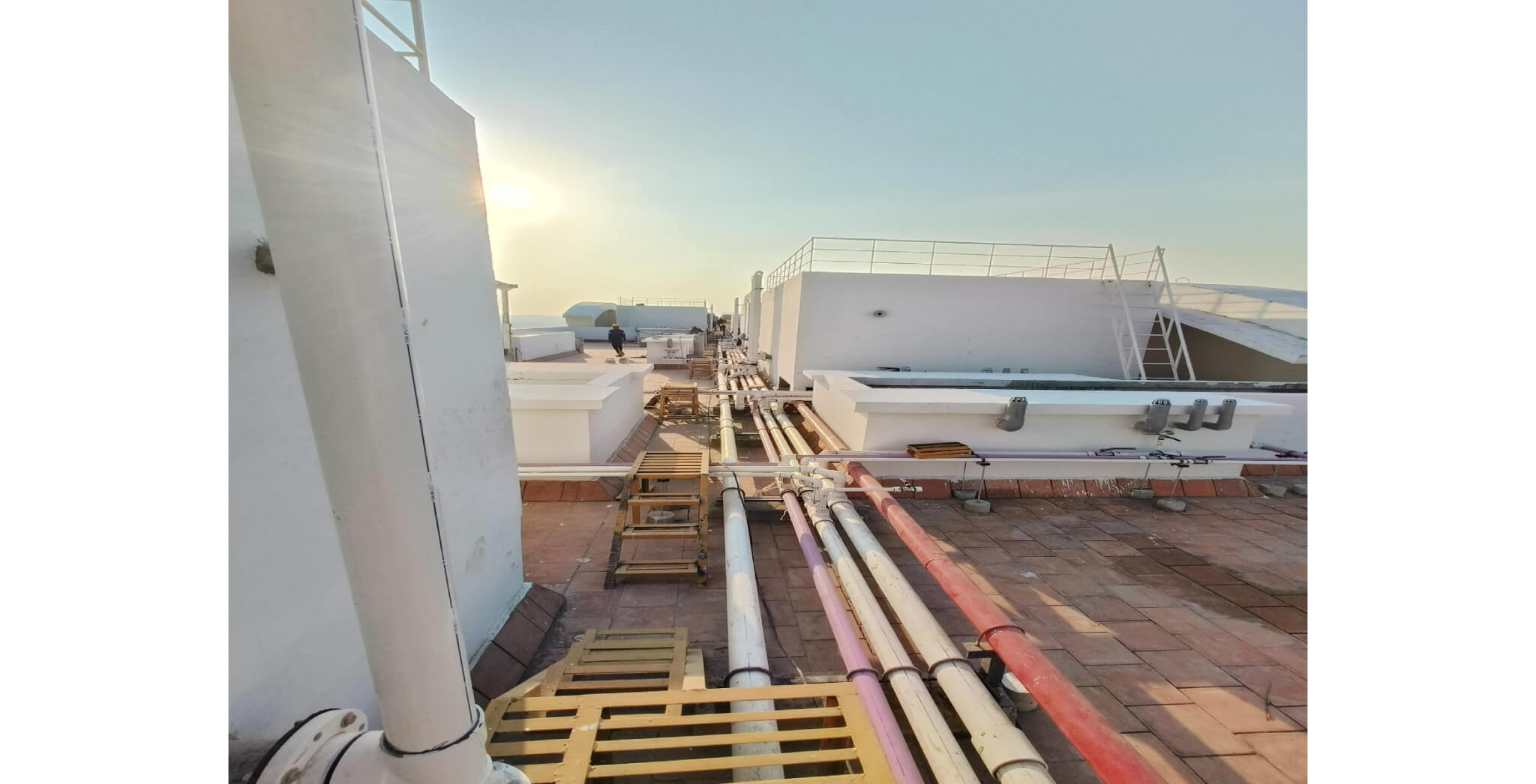

Terrace Clay Tile Fixing Work Is Completed
Oct 2025

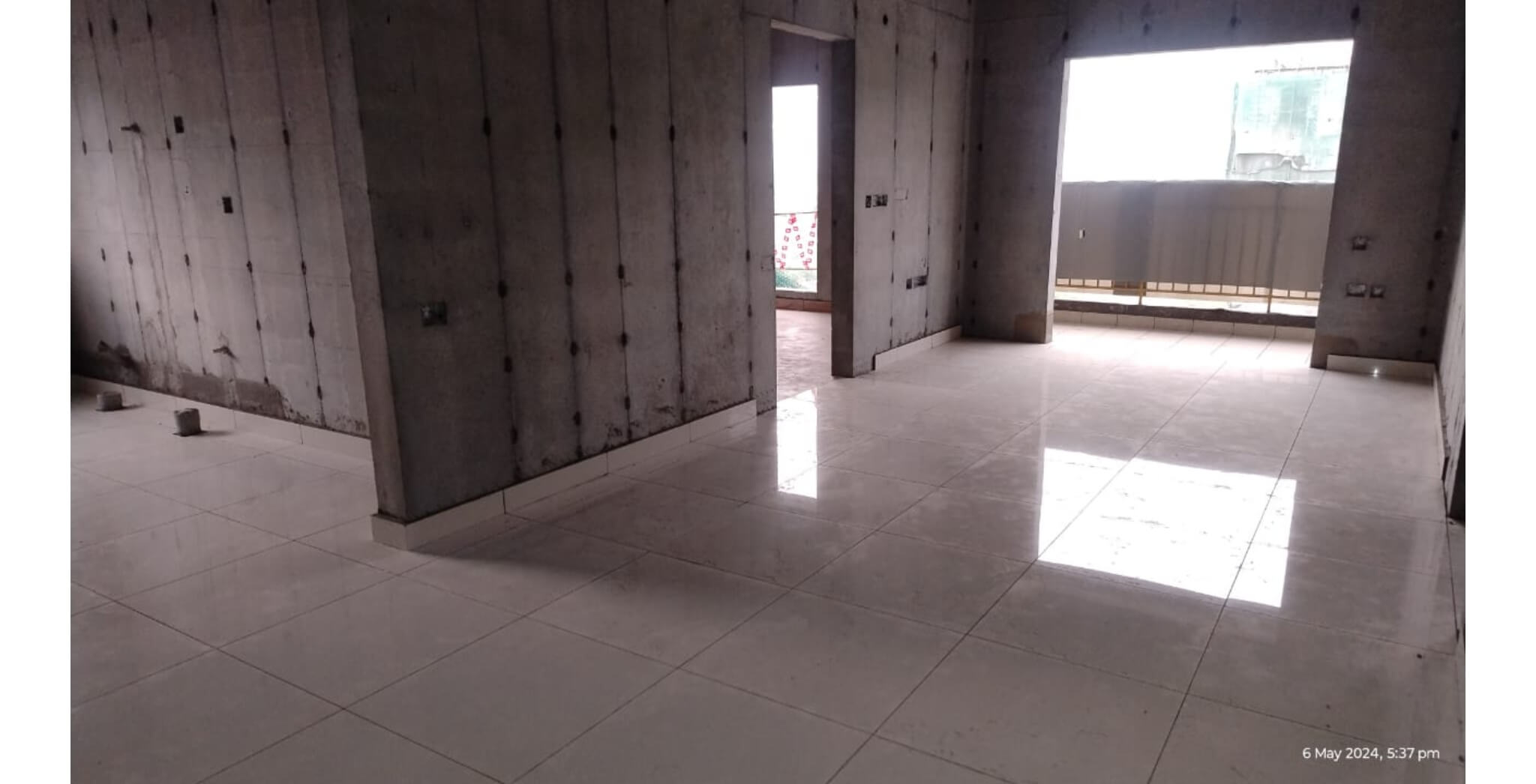

Tiling Work In Progress
Oct 2025

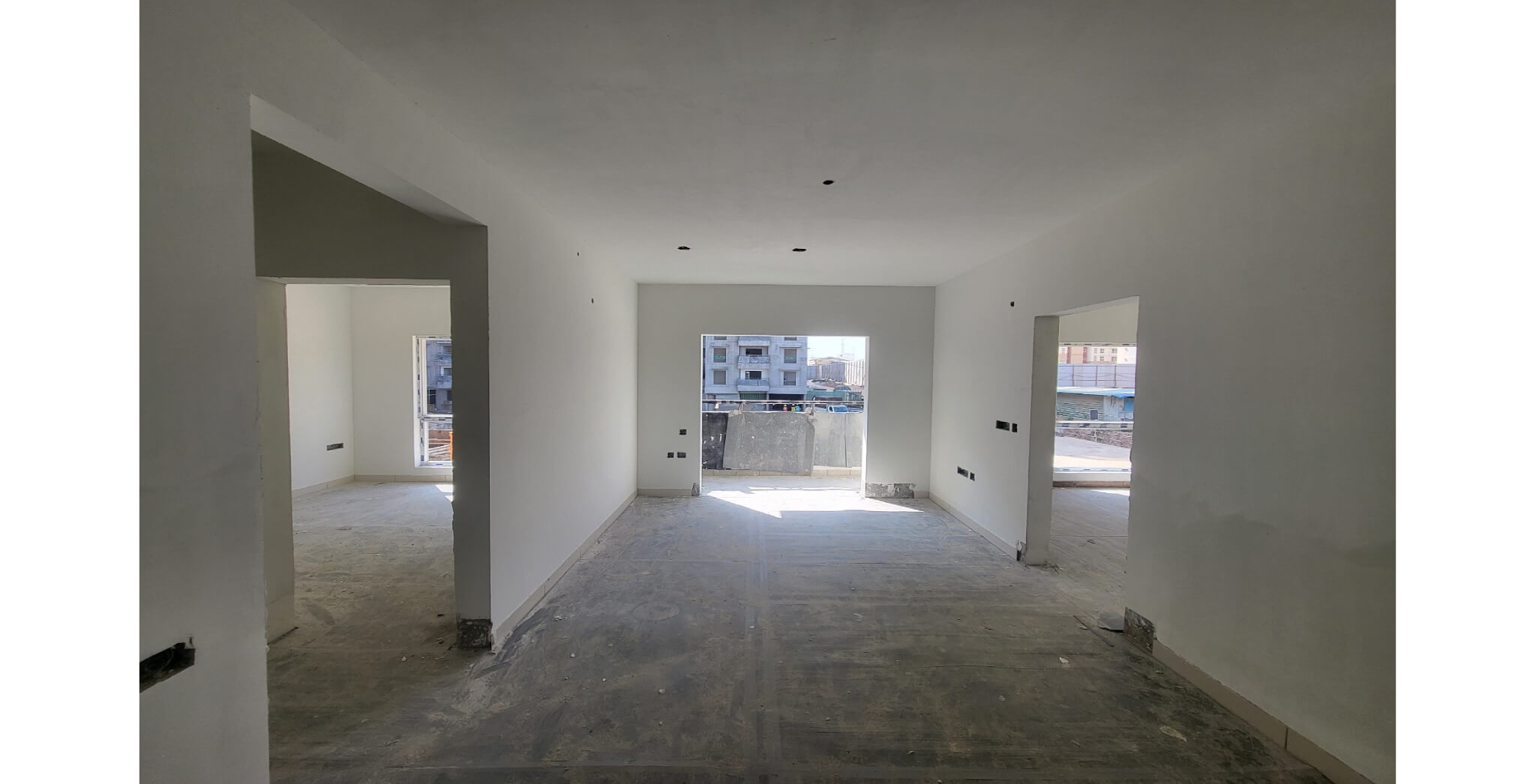

Painting work in progress
Oct 2025

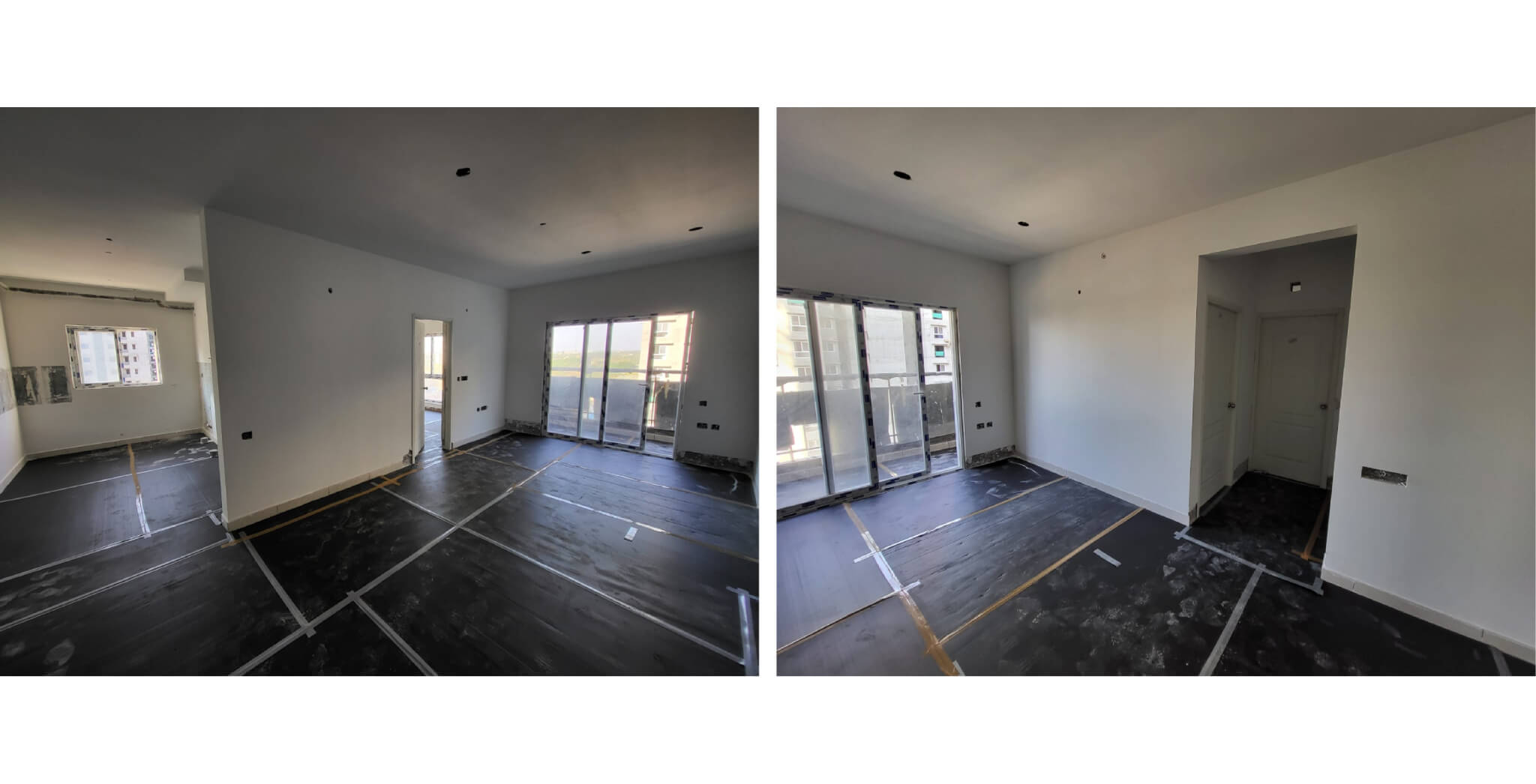

Windows and Doors fixing work
Oct 2025

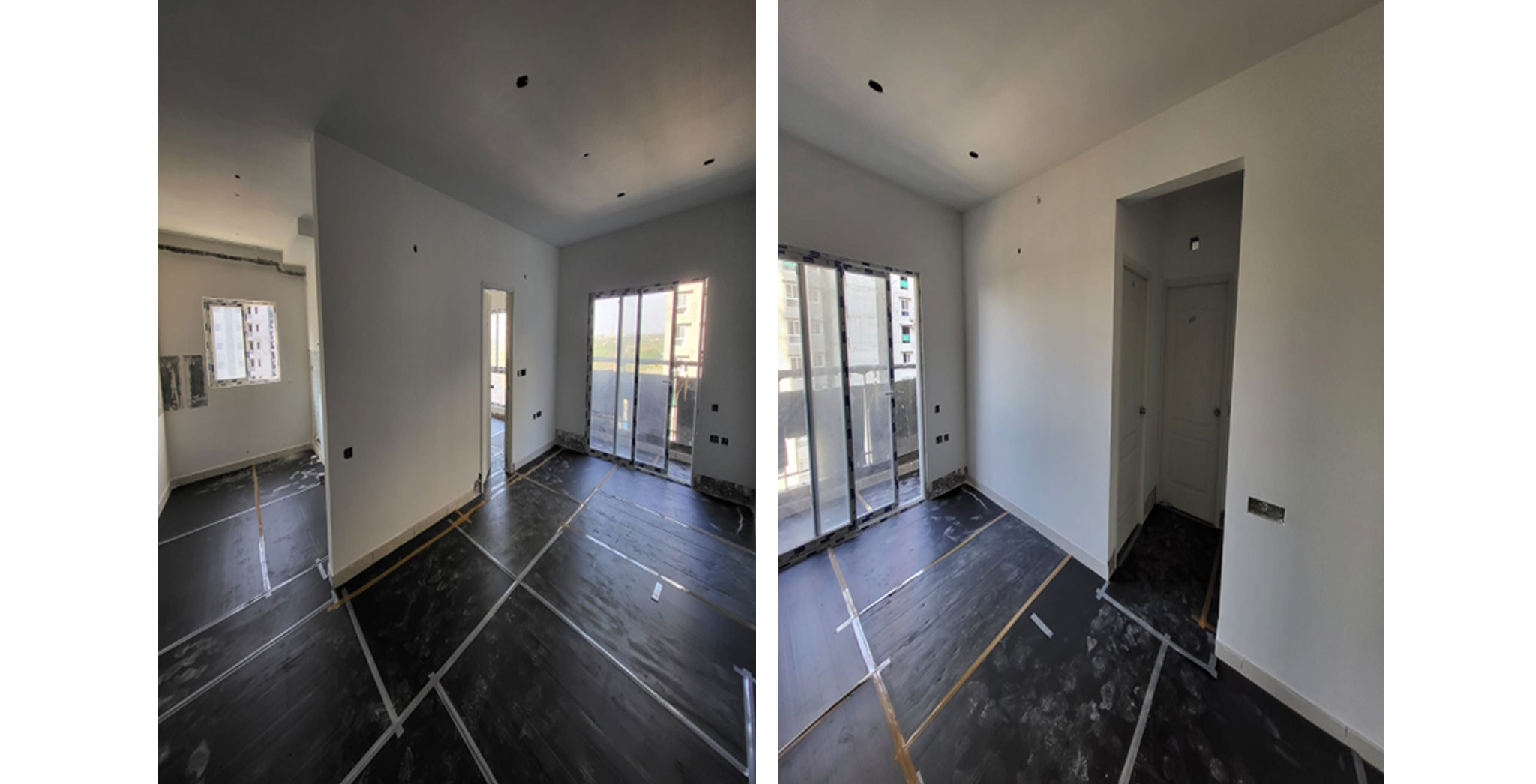

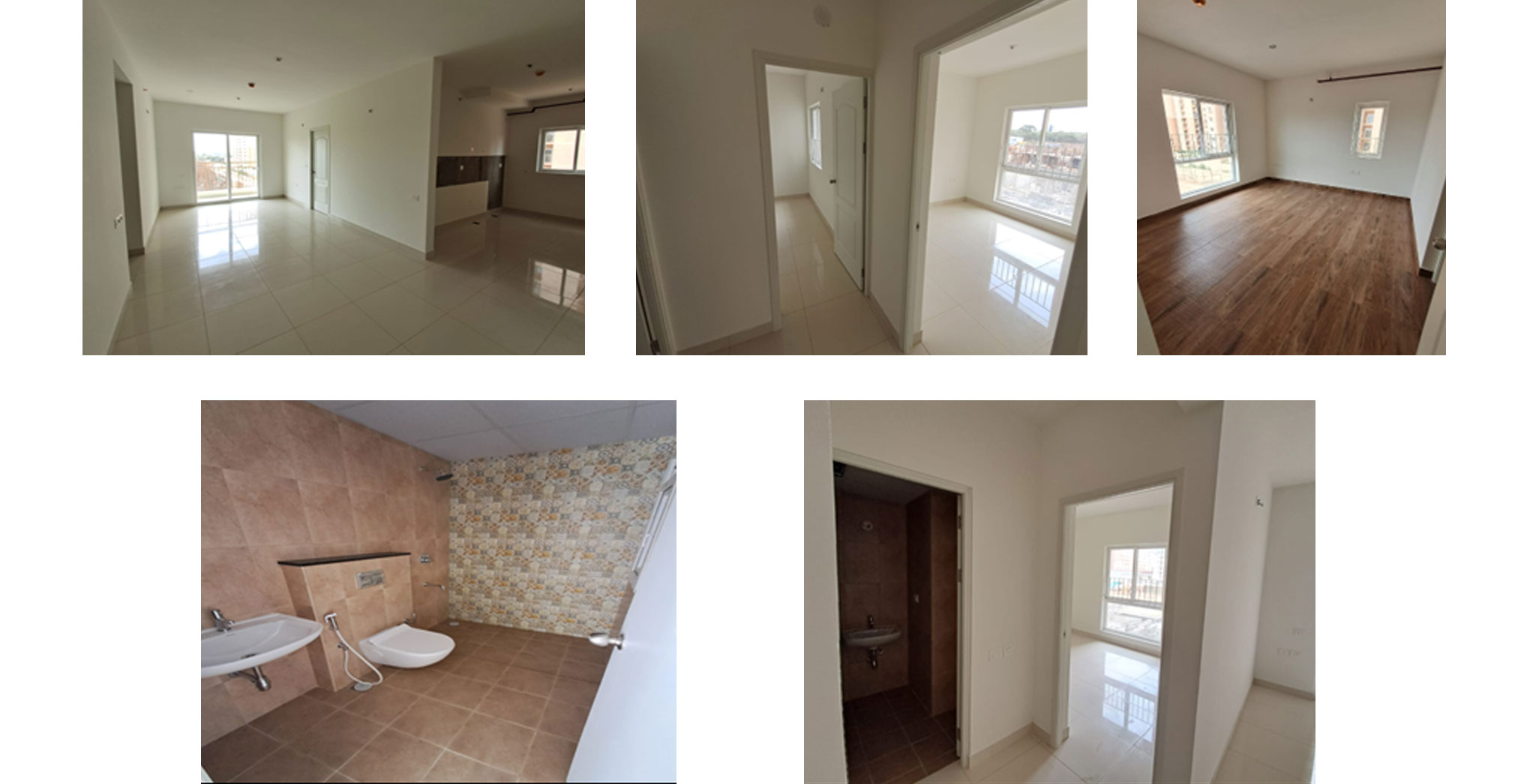

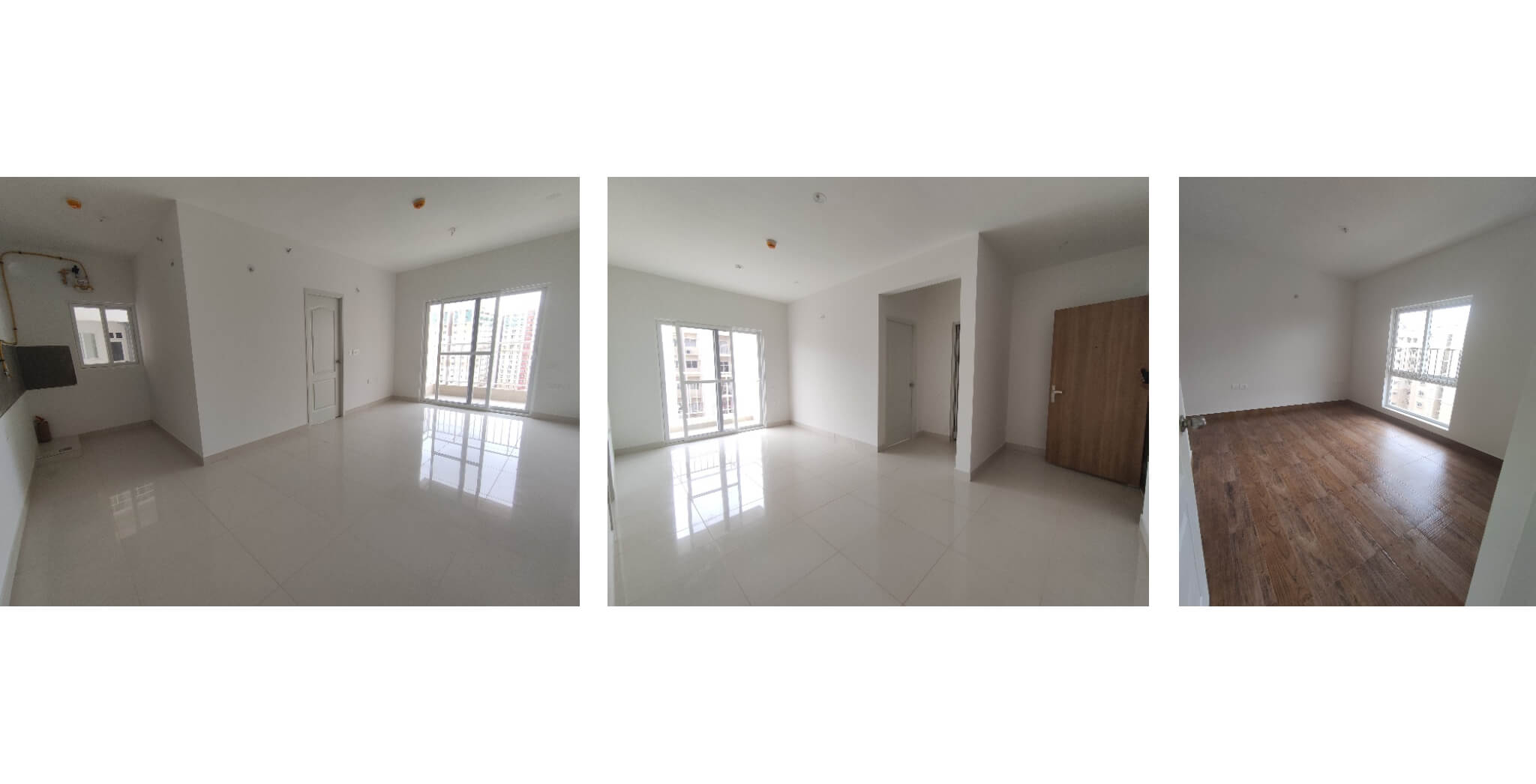

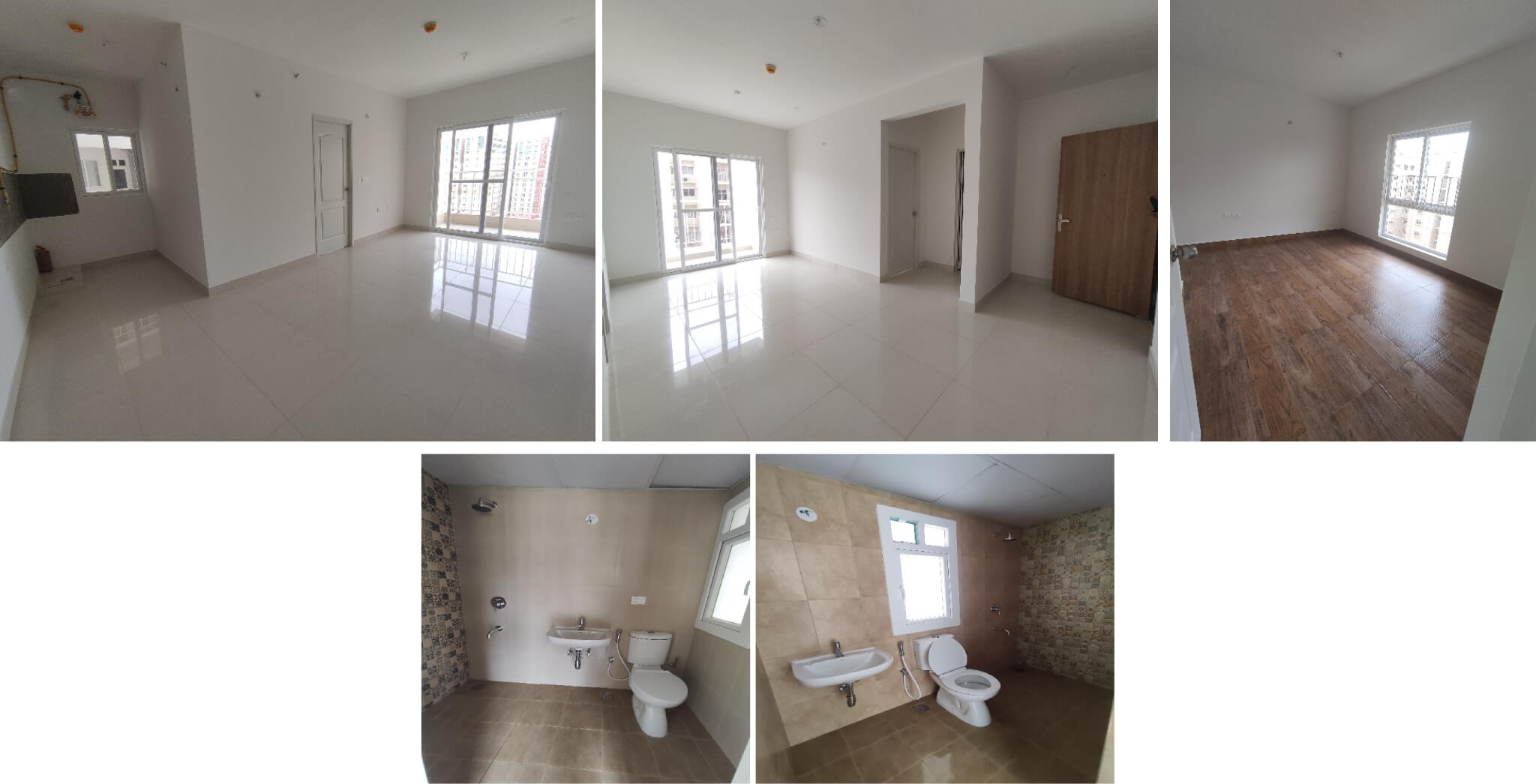

Finishing Work in Progress
Oct 2025

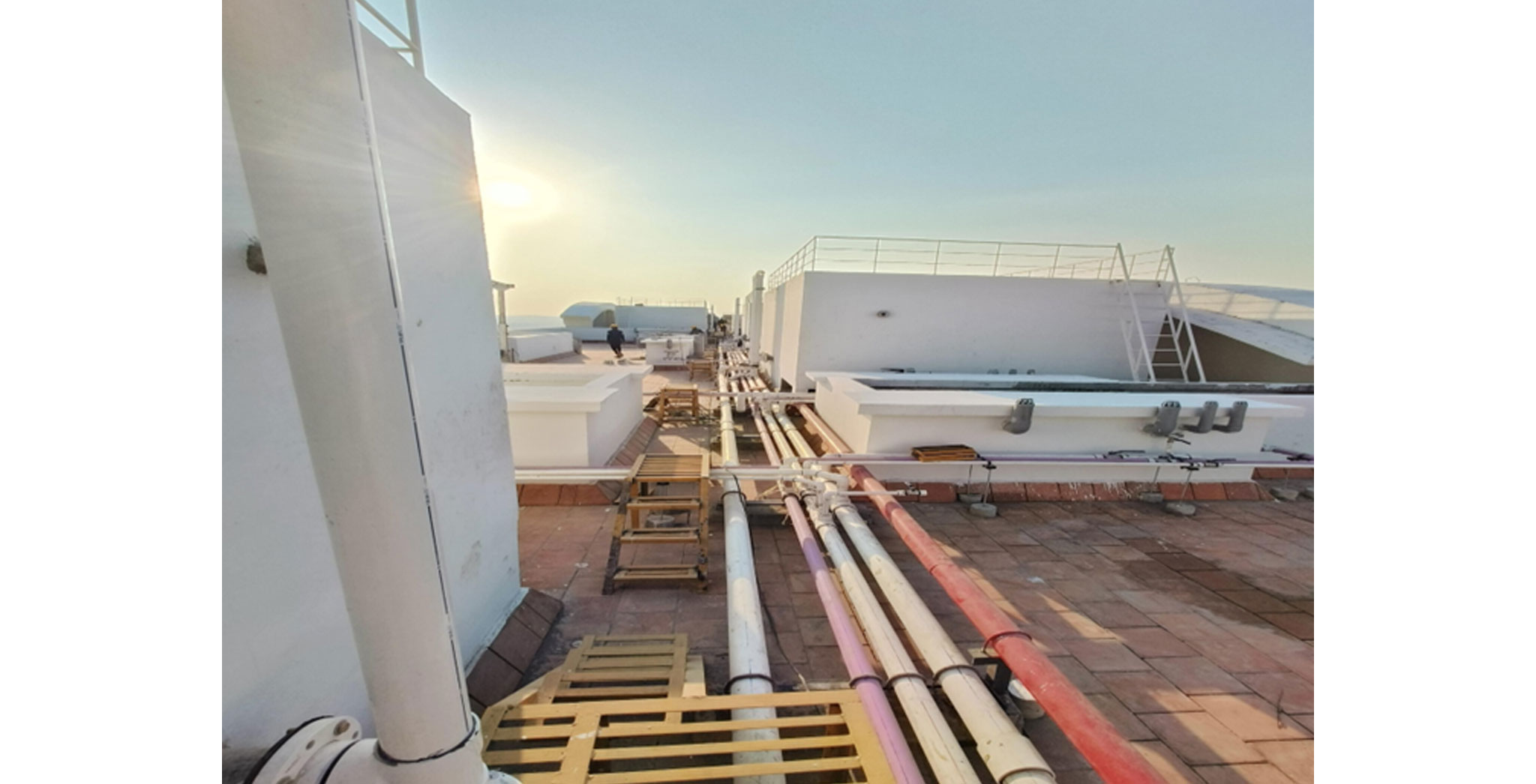

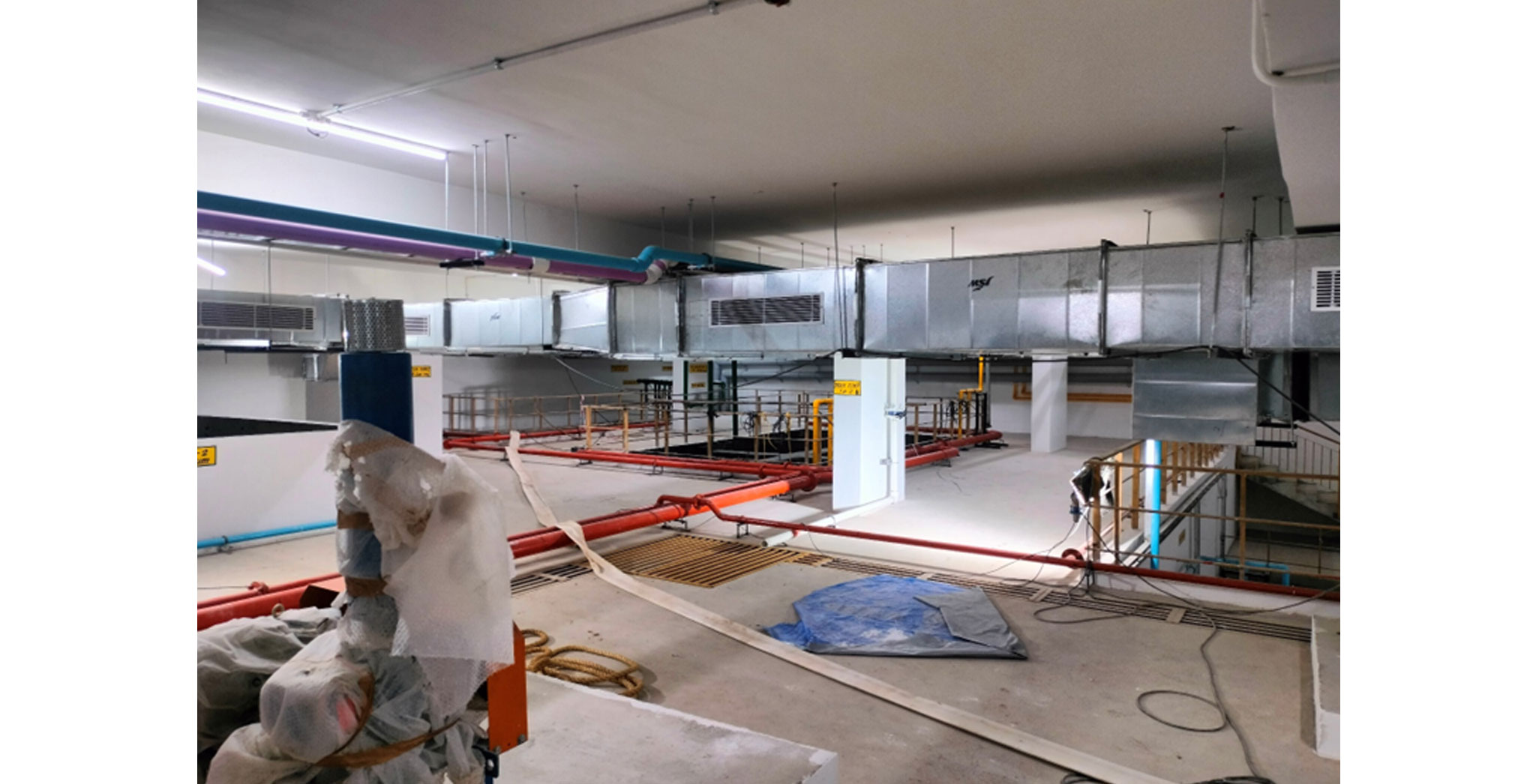

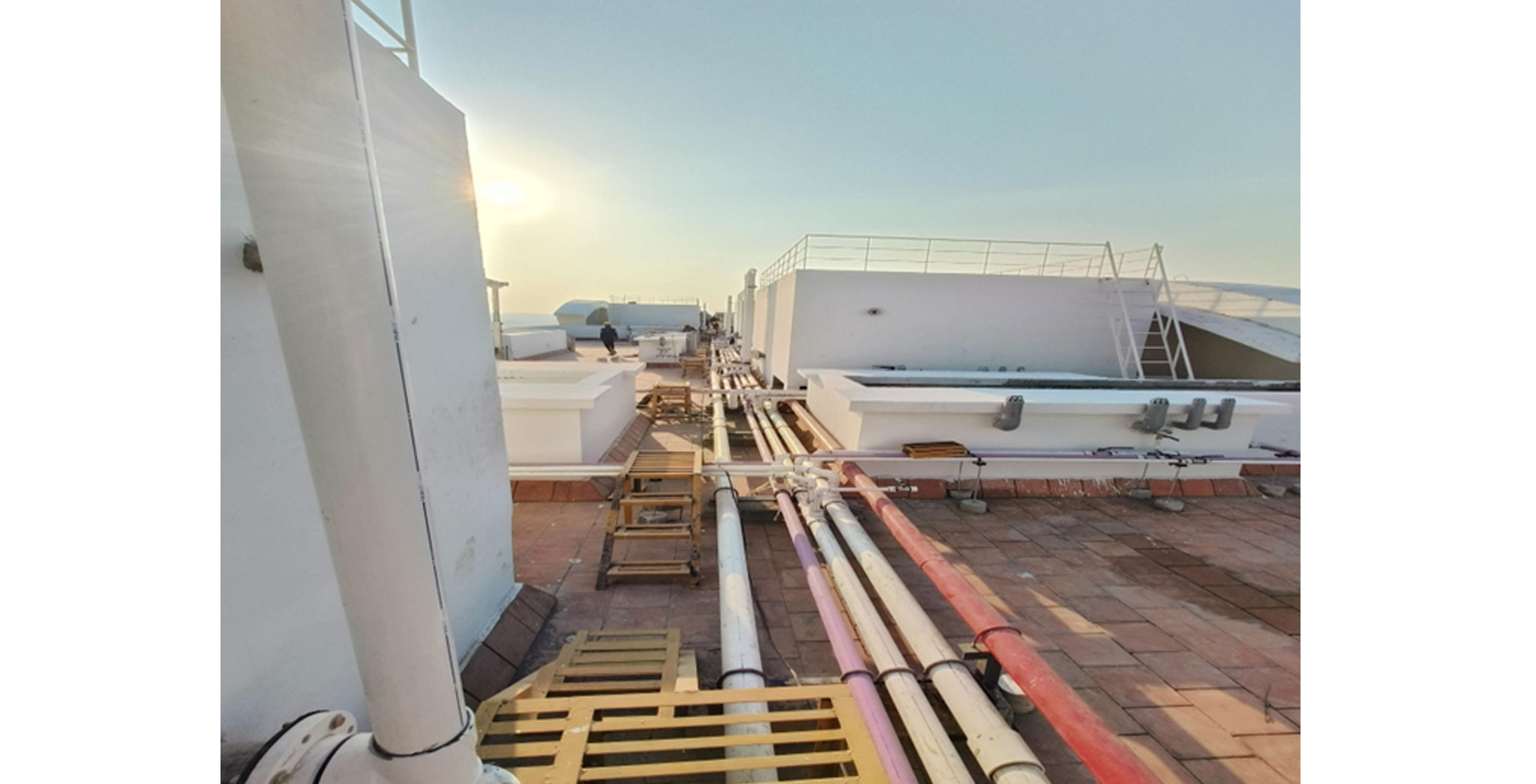

STP HVAC duct and Plumbing Work is completed
Oct 2025

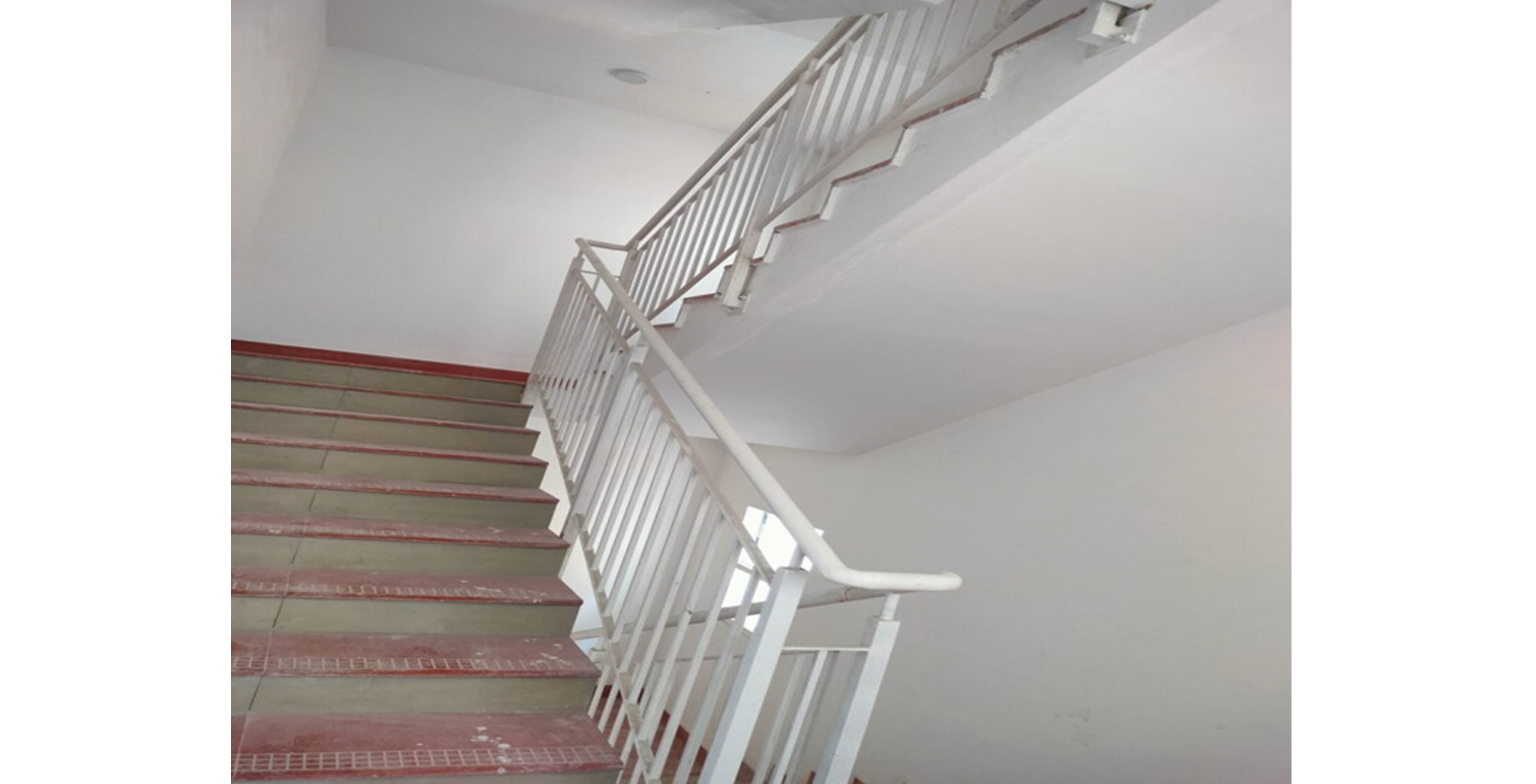

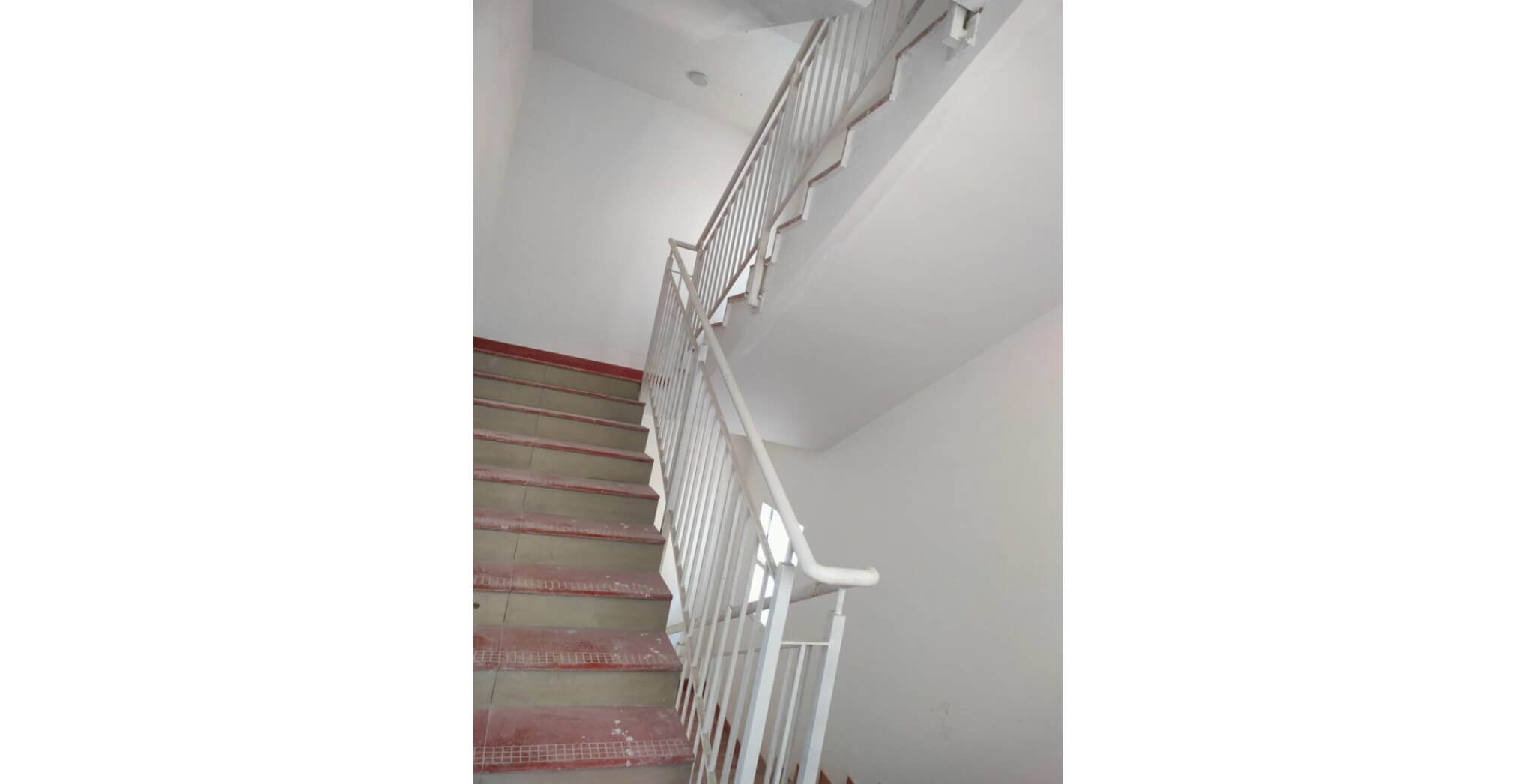

Staircase Painting WIP
Oct 2025

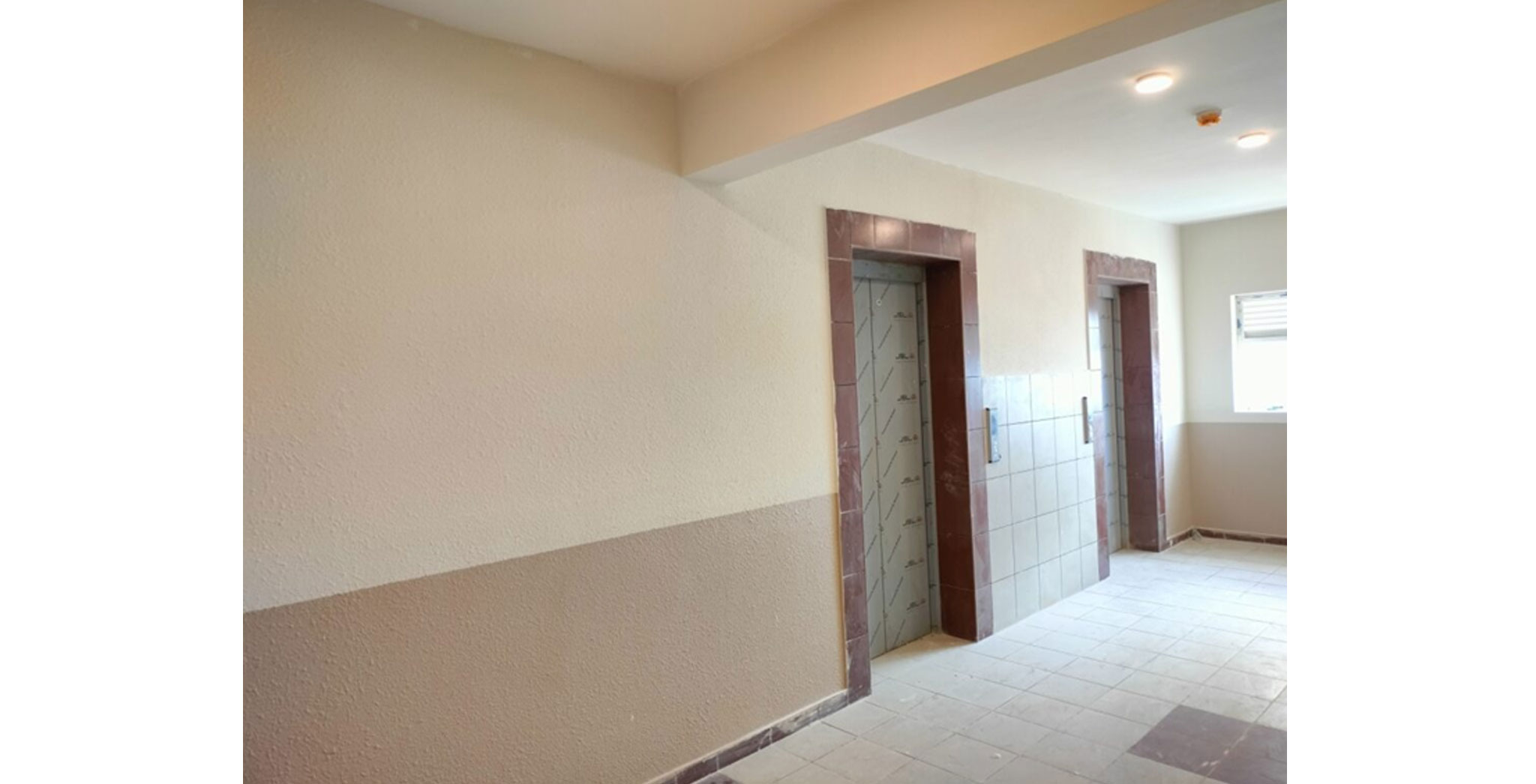

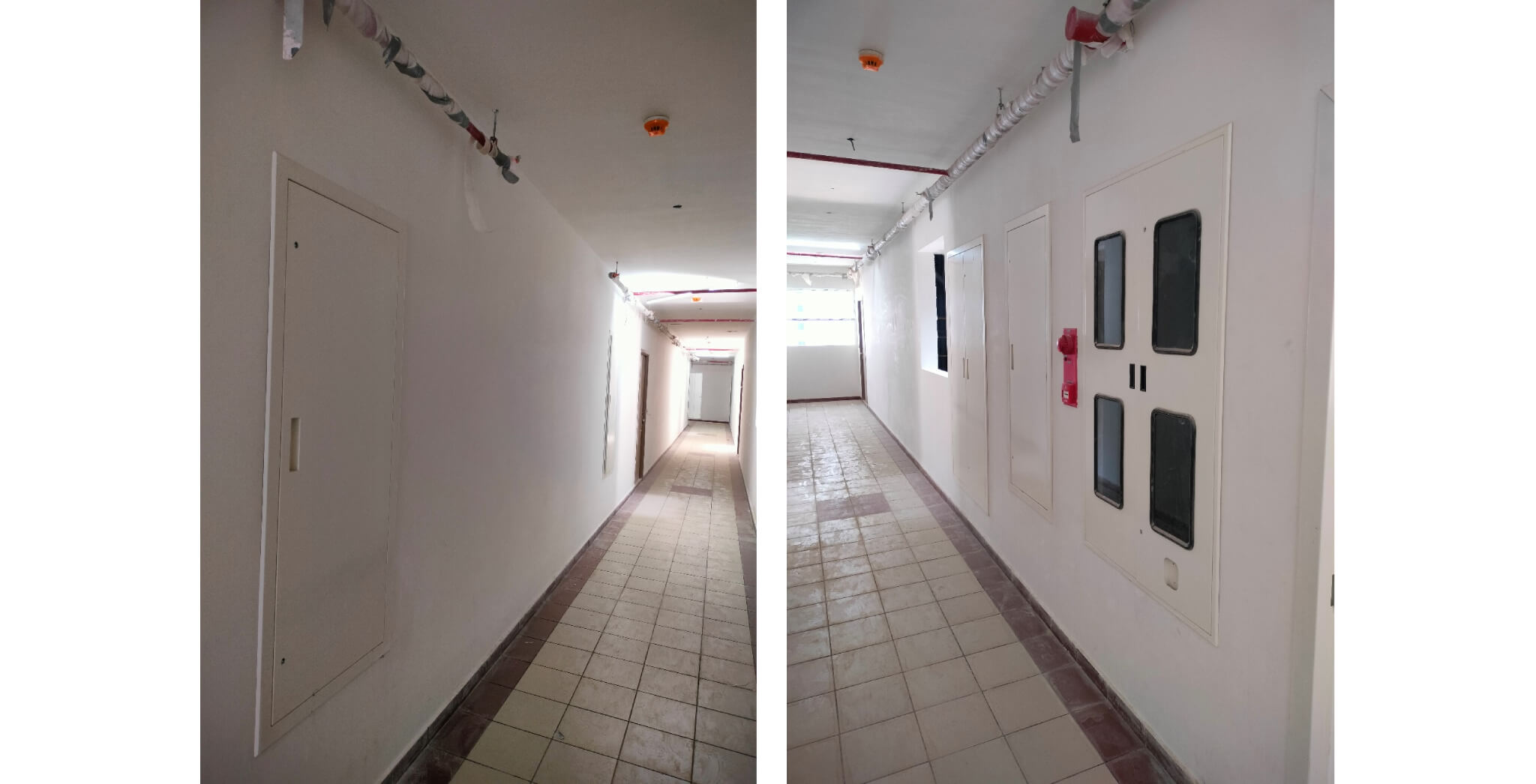

PHE shaft door
Oct 2025

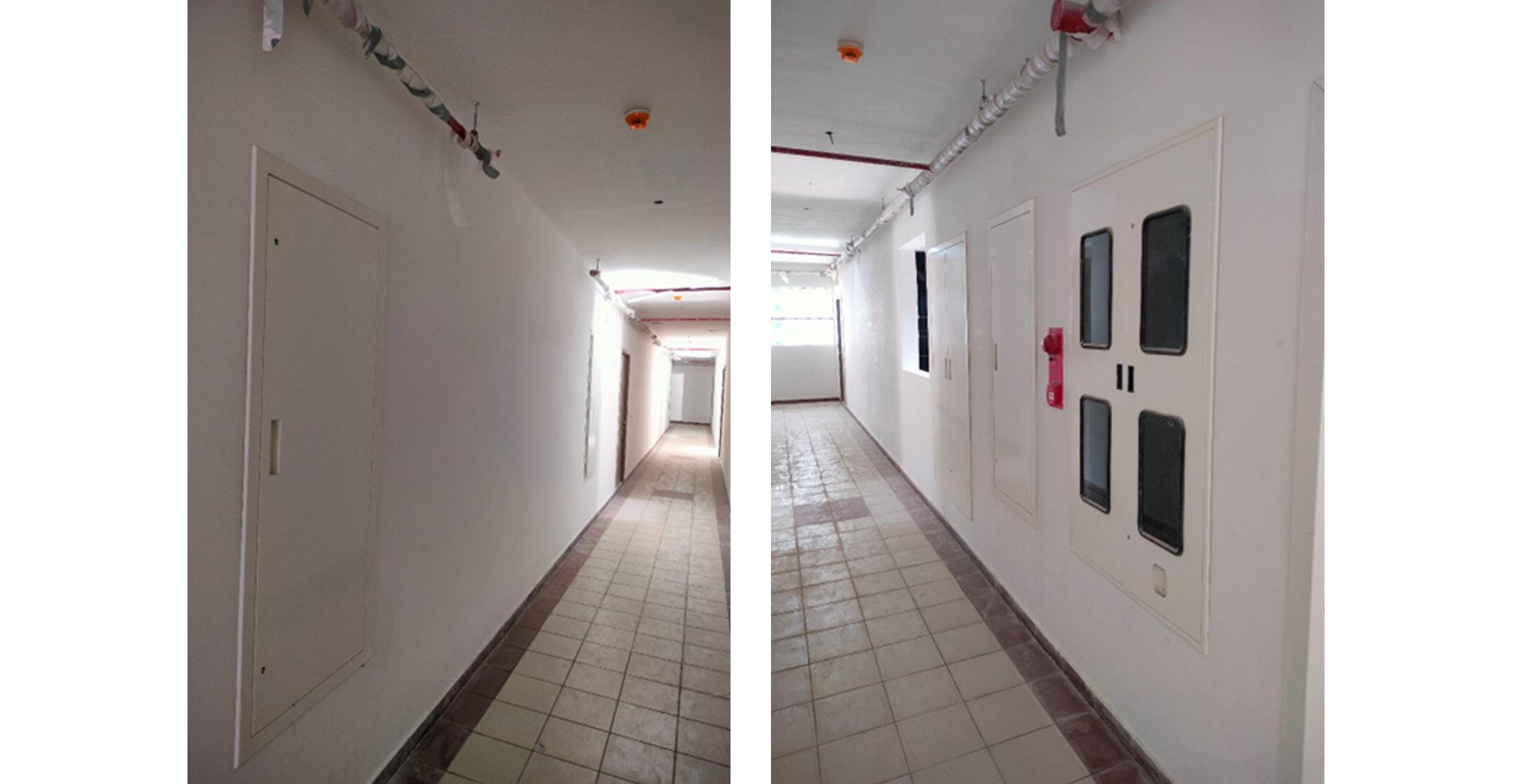

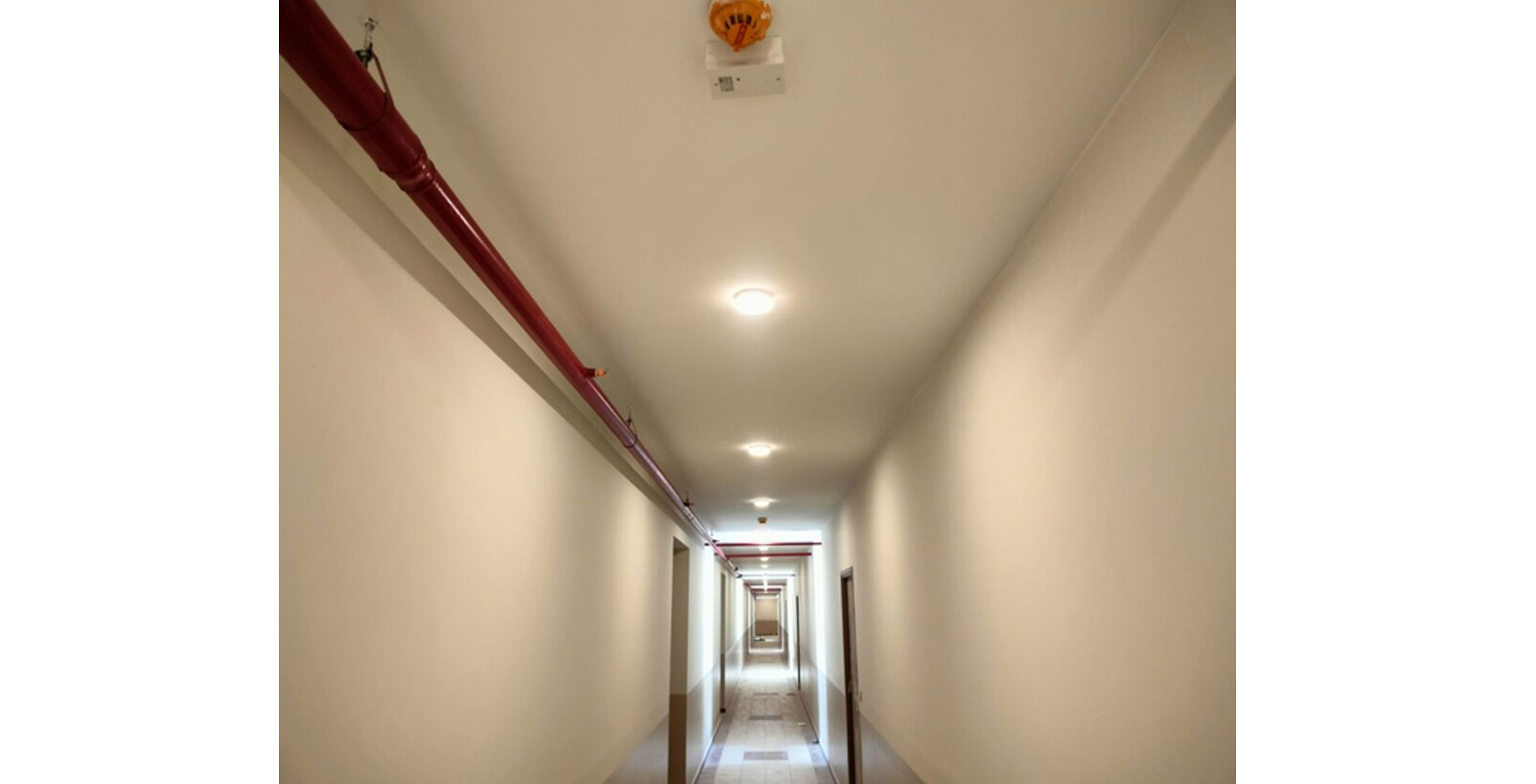

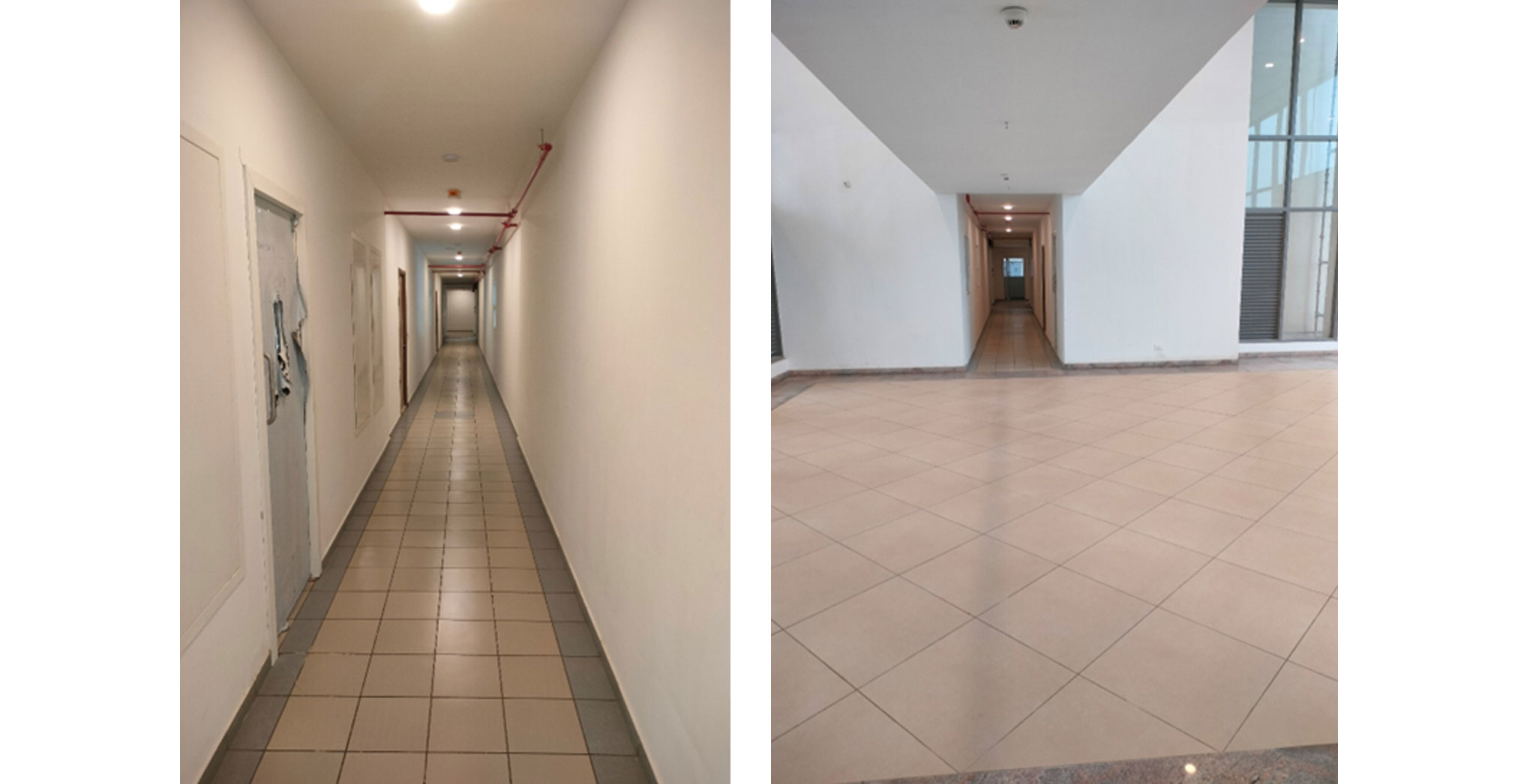

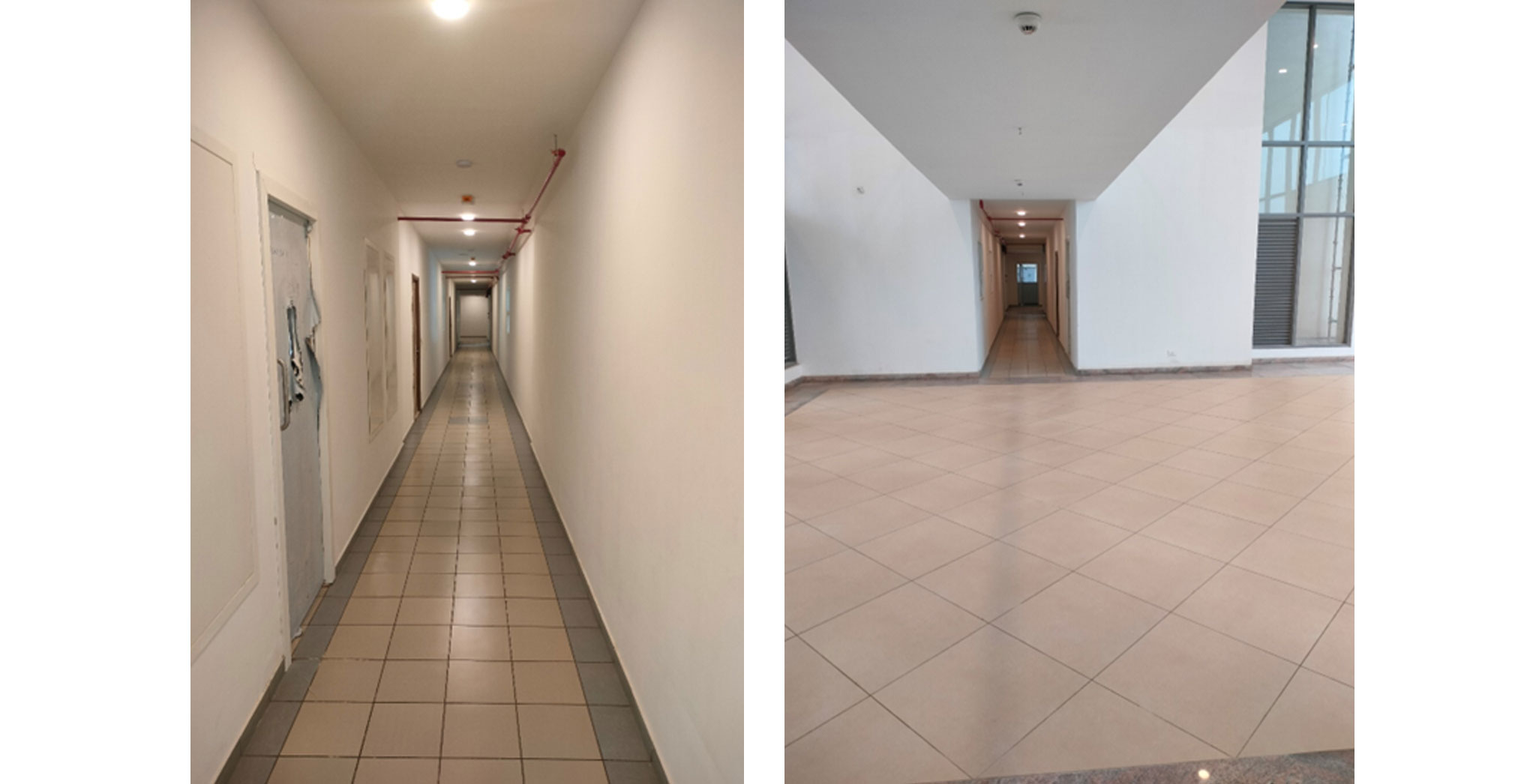

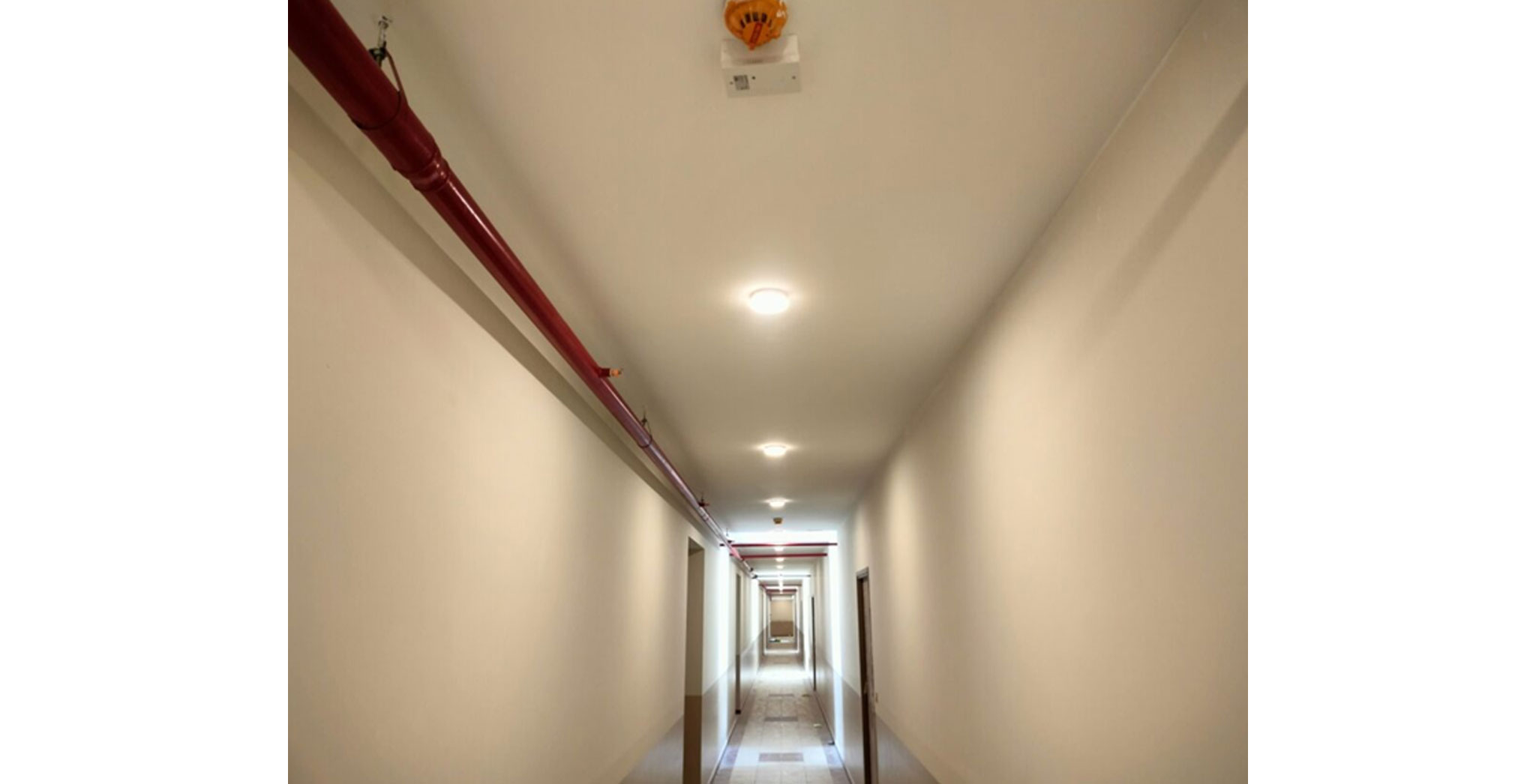

Corridor light fixing and Painting in progress
Oct 2025
Lift wall Texture completed
Oct 2025

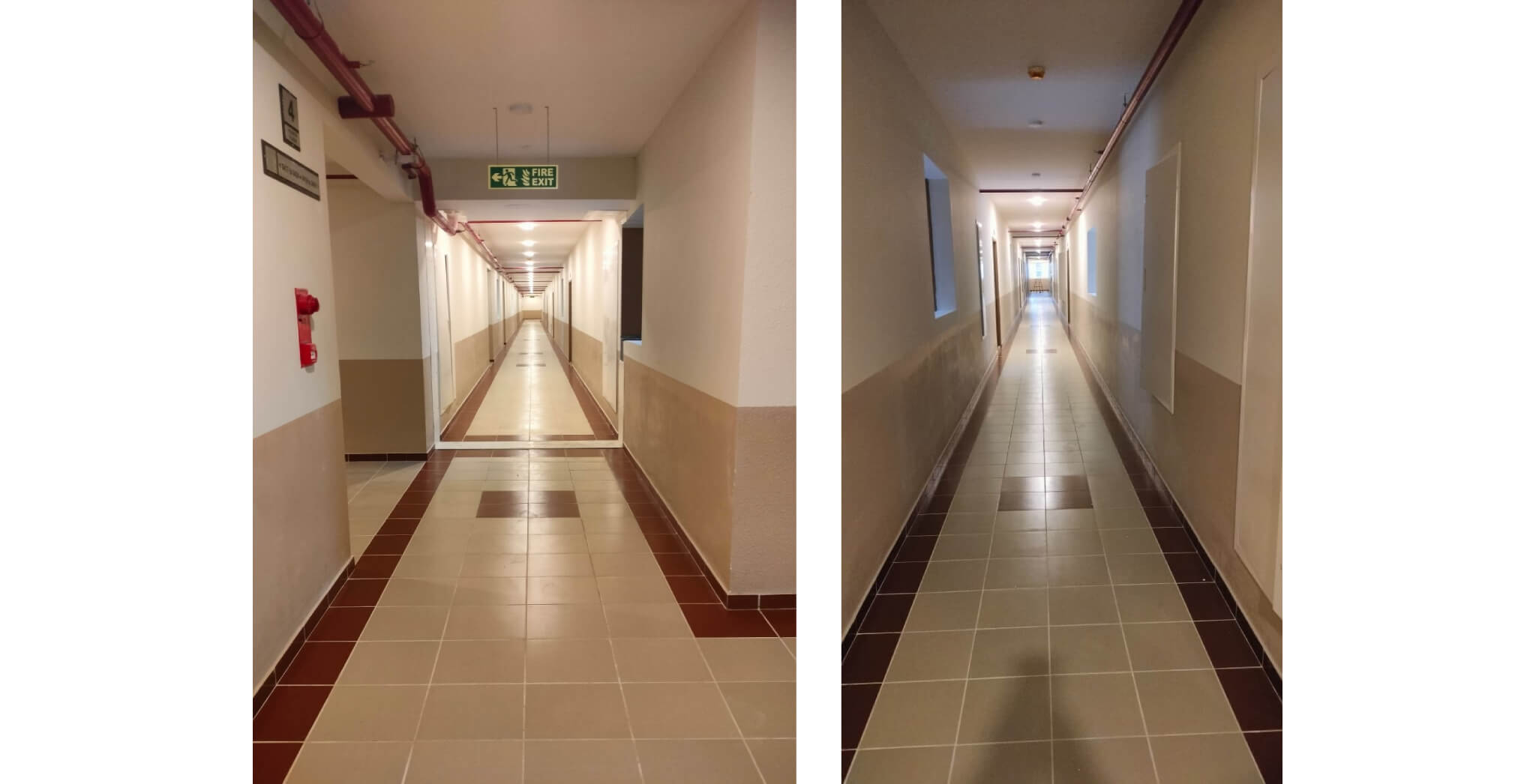

Corridor certification in progress
Oct 2025

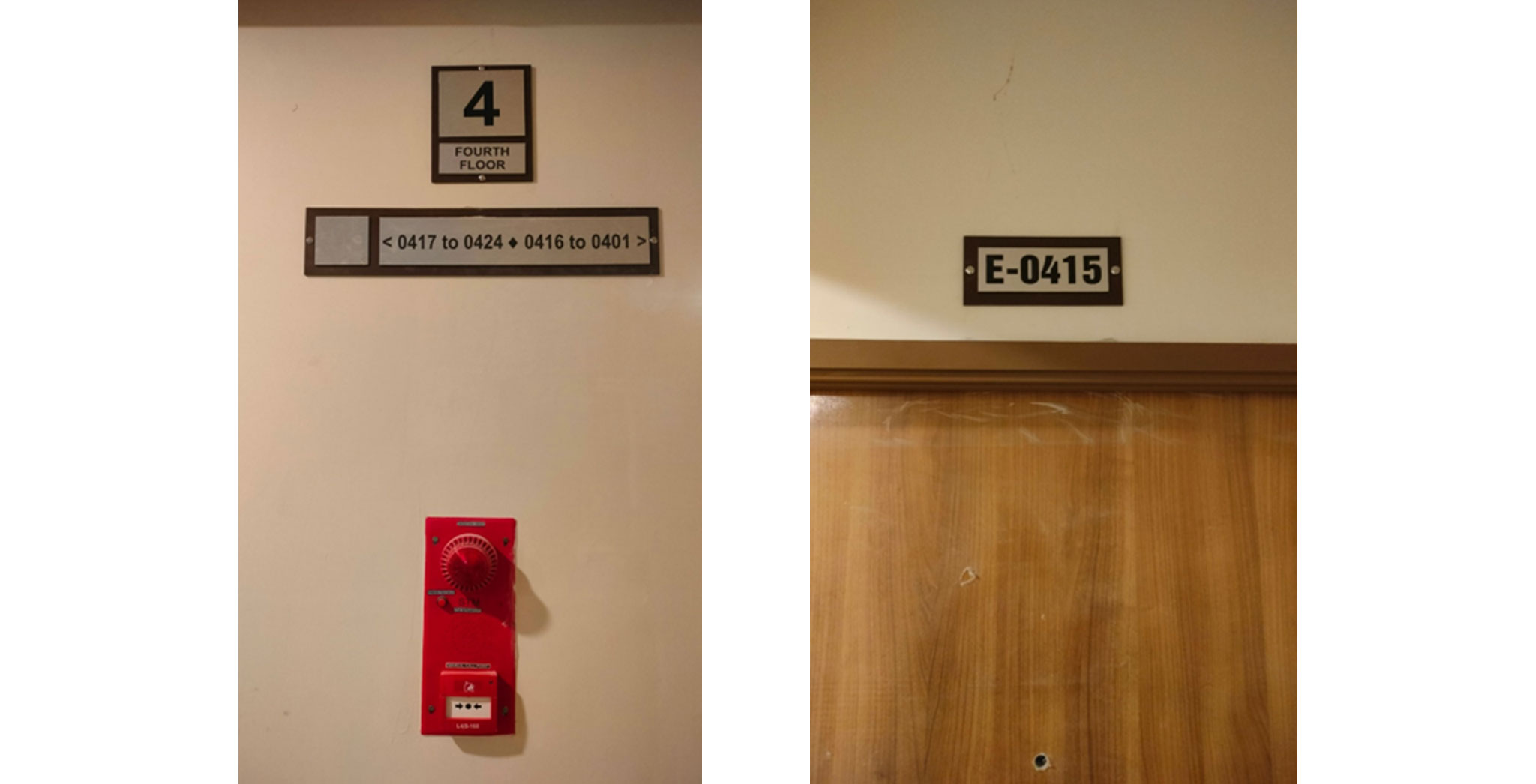

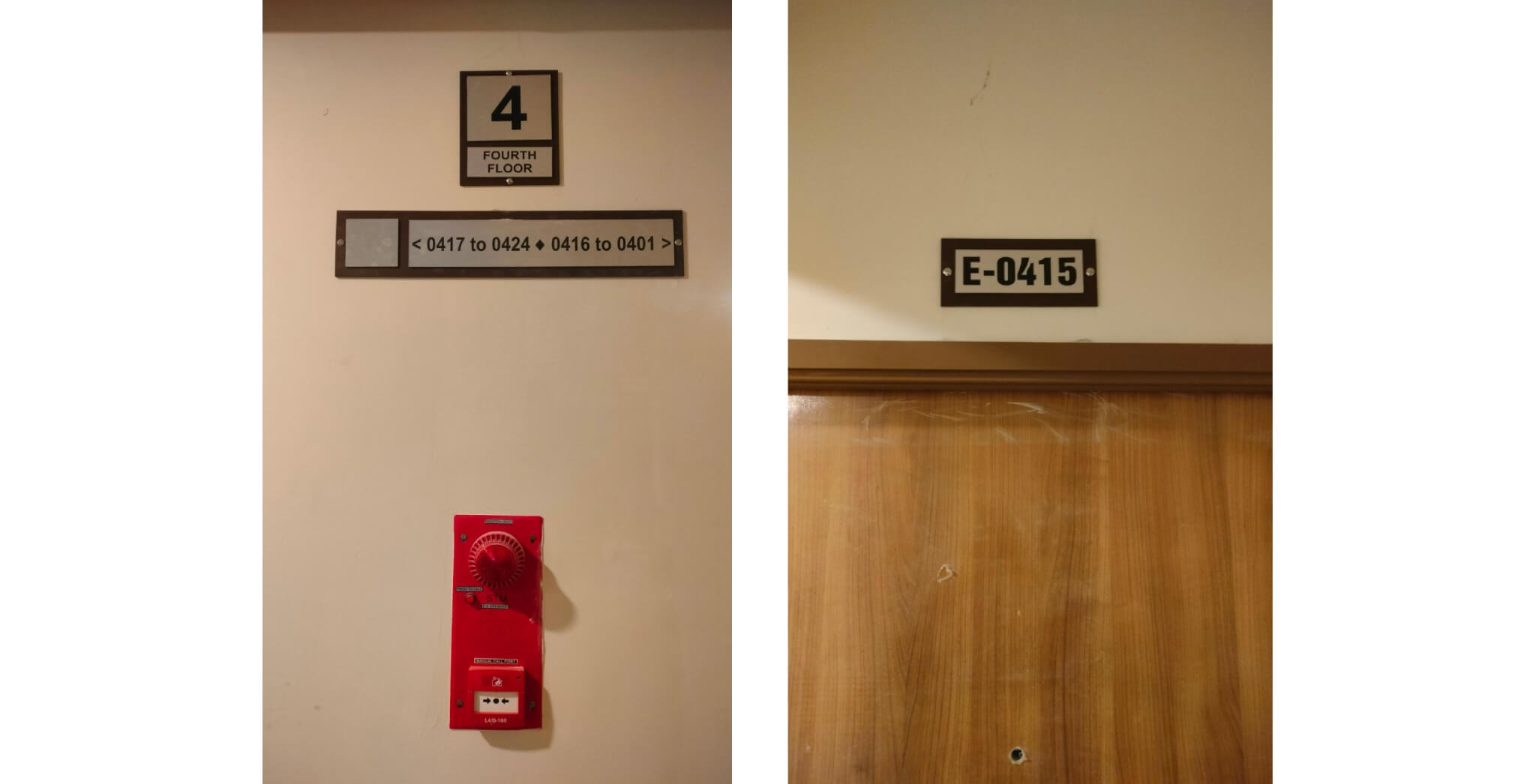

Corridor signage fixing is completed
Oct 2025

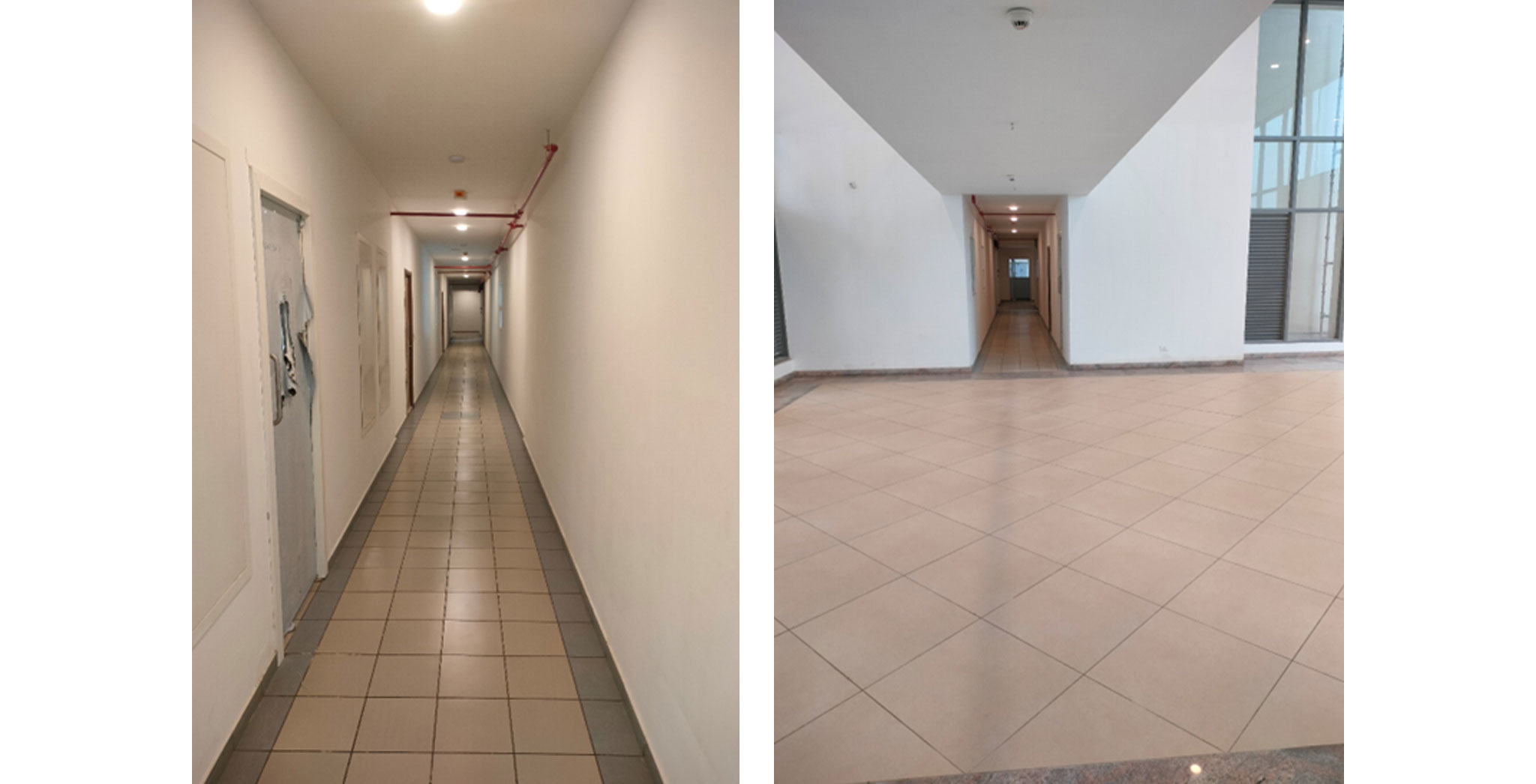

Ground floor triple height lobby finishing work in progress
Oct 2025
Ground floor corridor Painting work in progress
Oct 2025

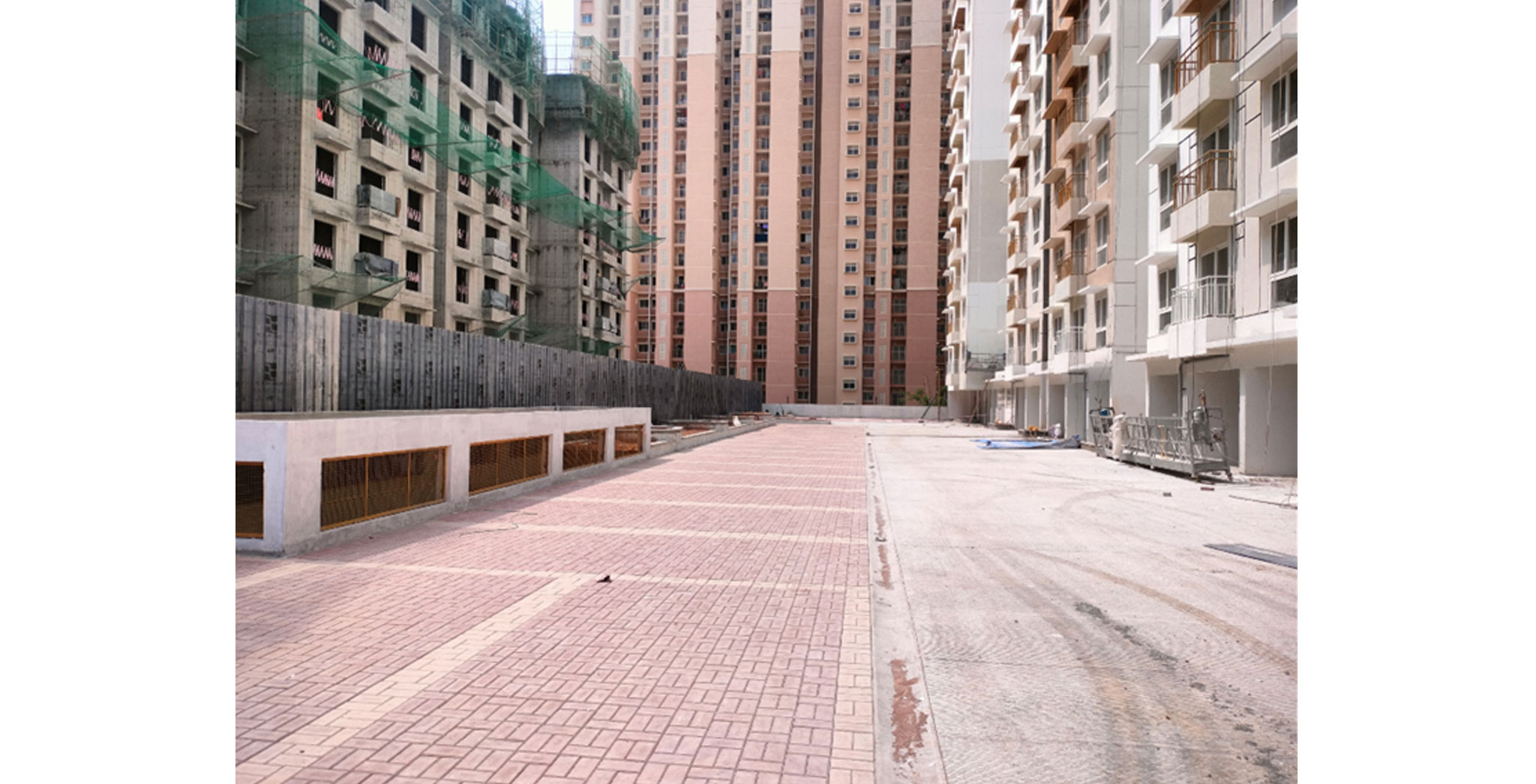

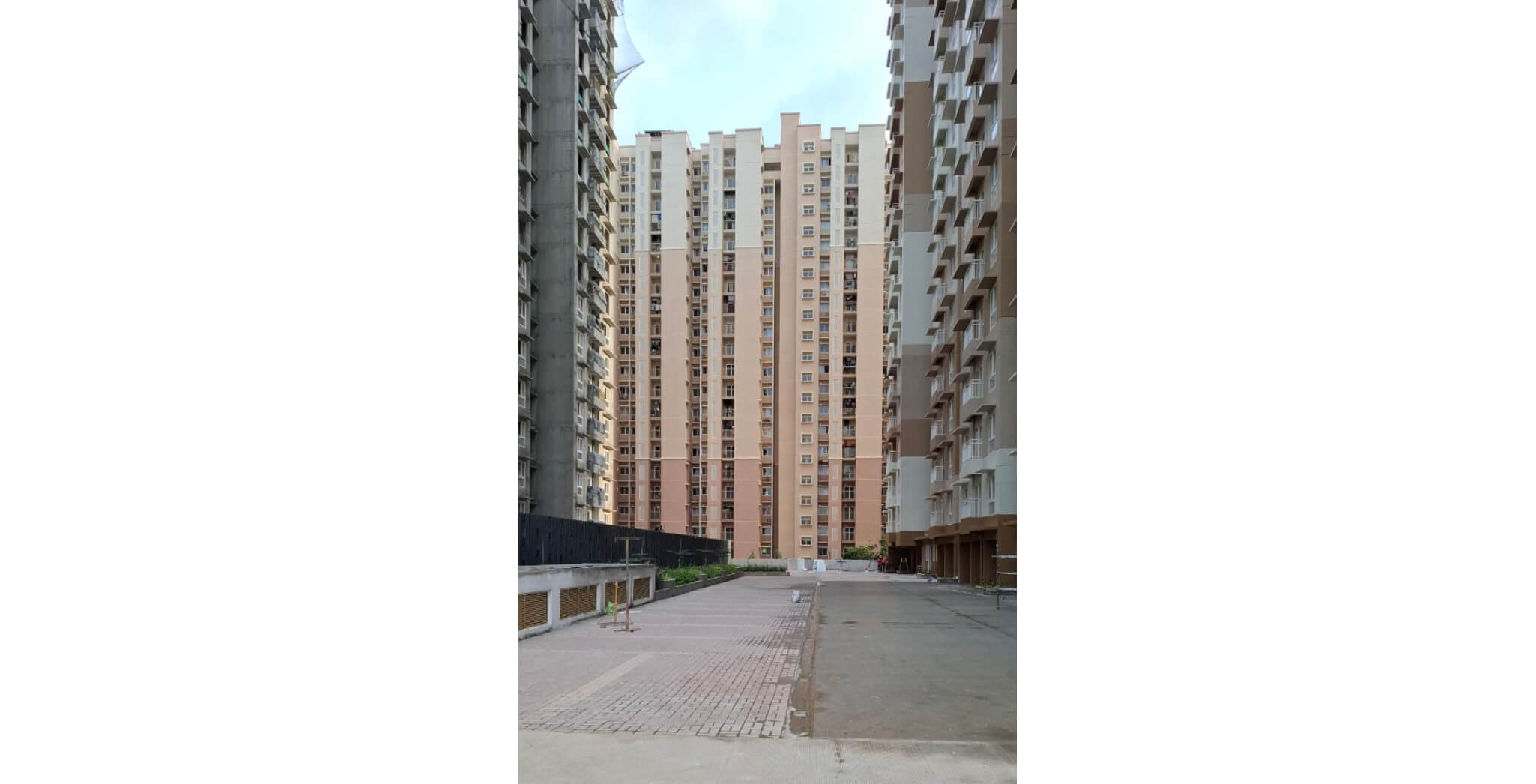

East face( between E and D tower) driveway and car parking work is completed
Oct 2025

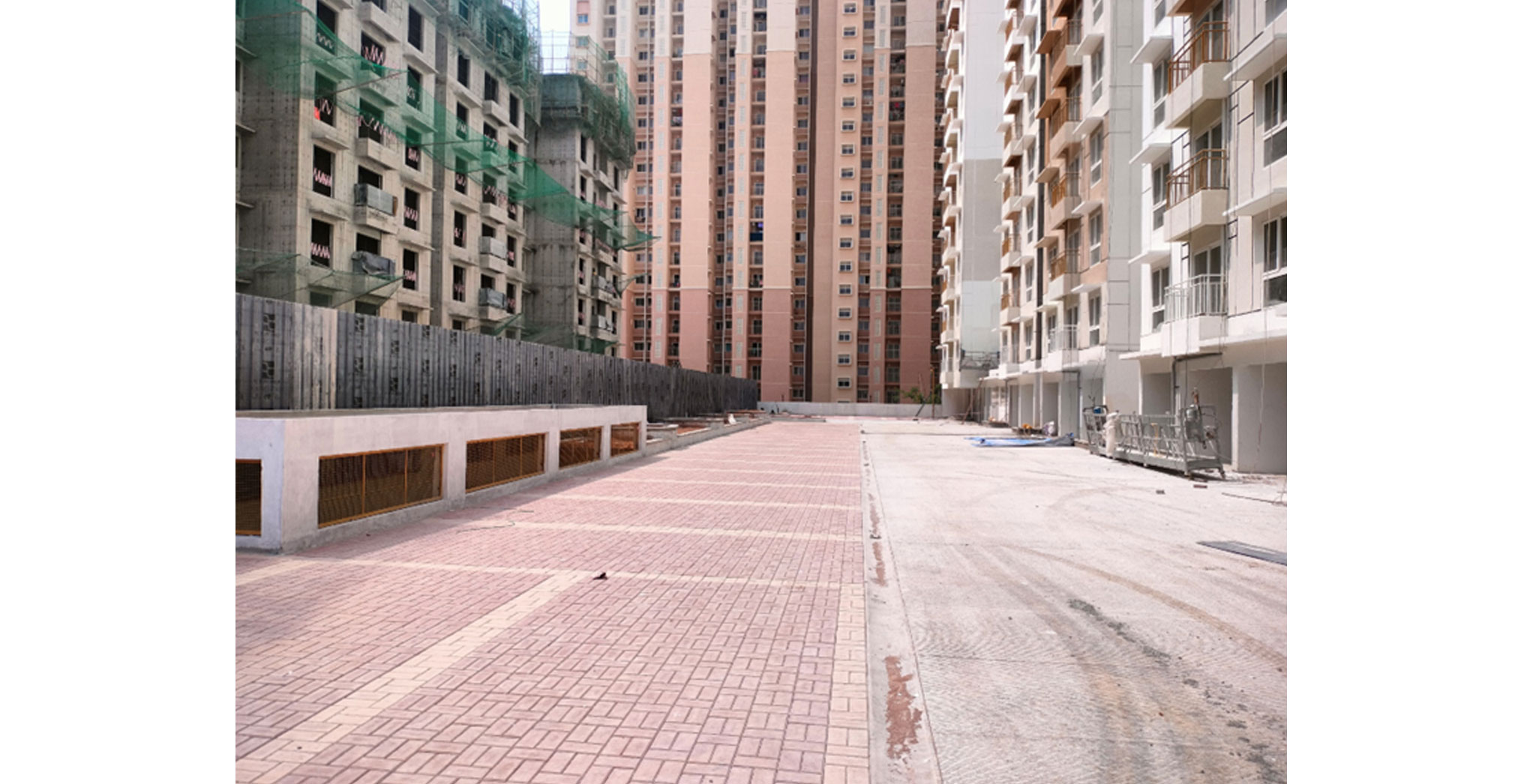

Podium Central Courtyard Area Hardscape and Softscape Work in progress
Oct 2025

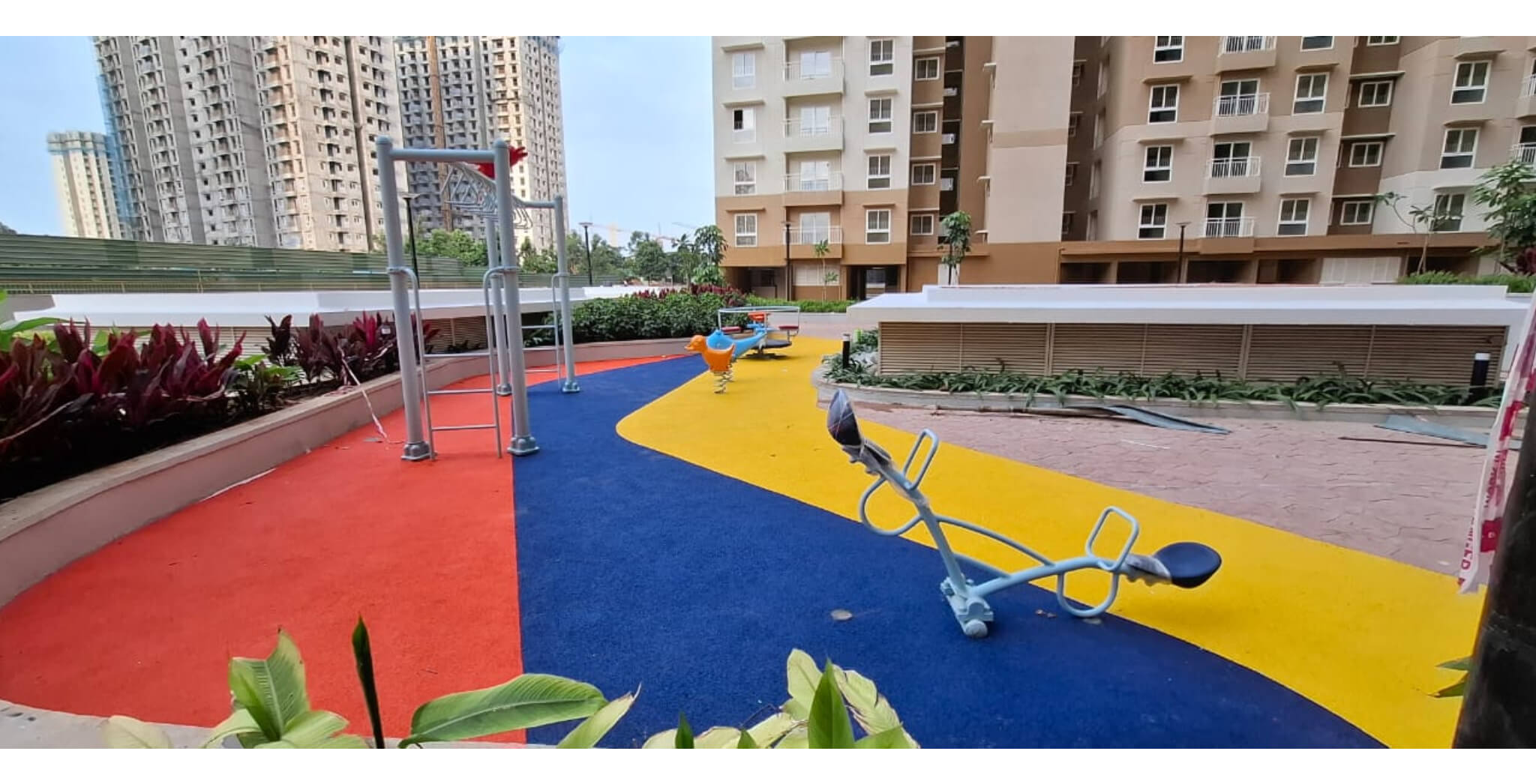

Kids play area flooring and play area equipment work is completed
Oct 2025
Podium Central Courtyard Area Hardscape and Softs cape work in progress
Oct 2025
