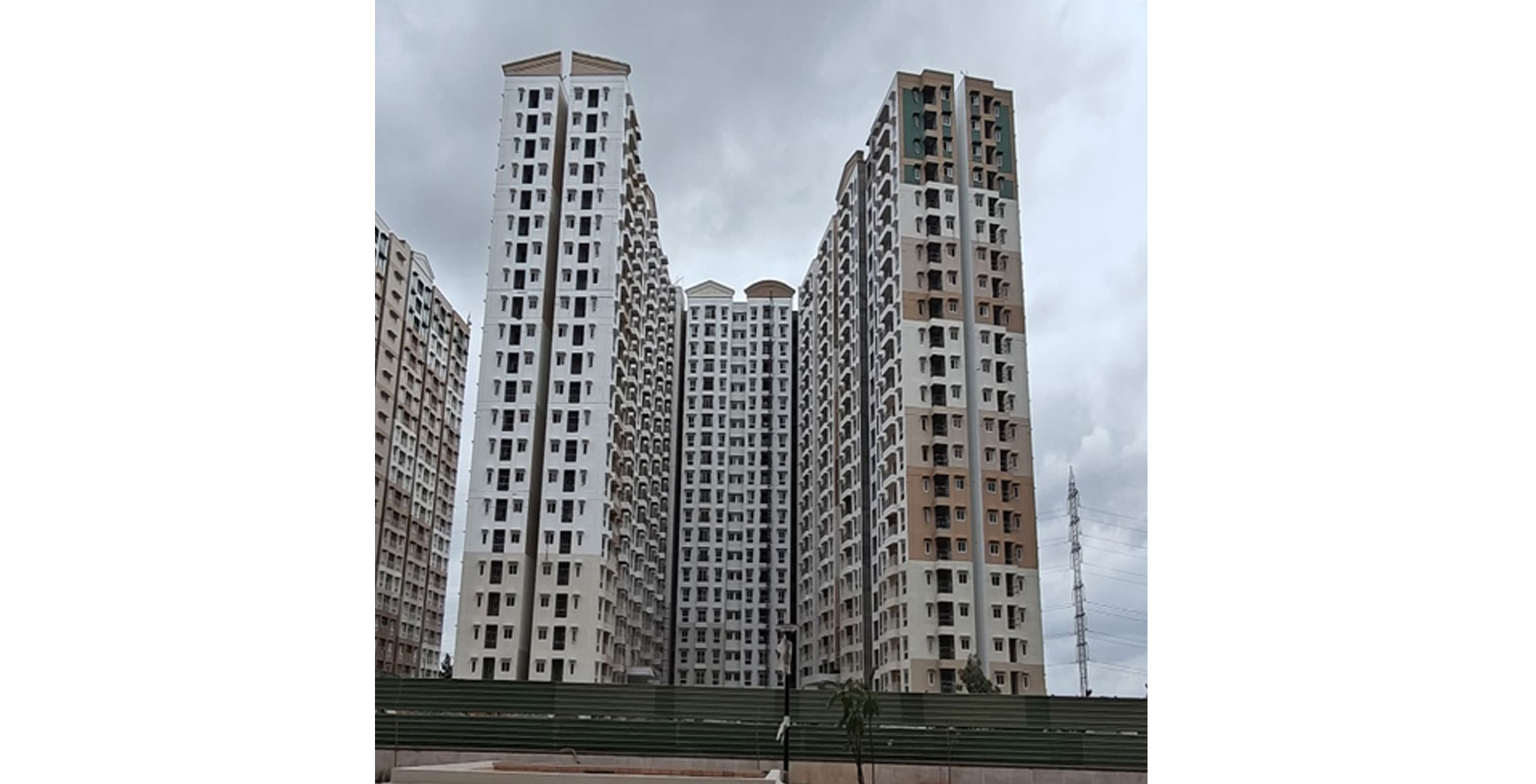

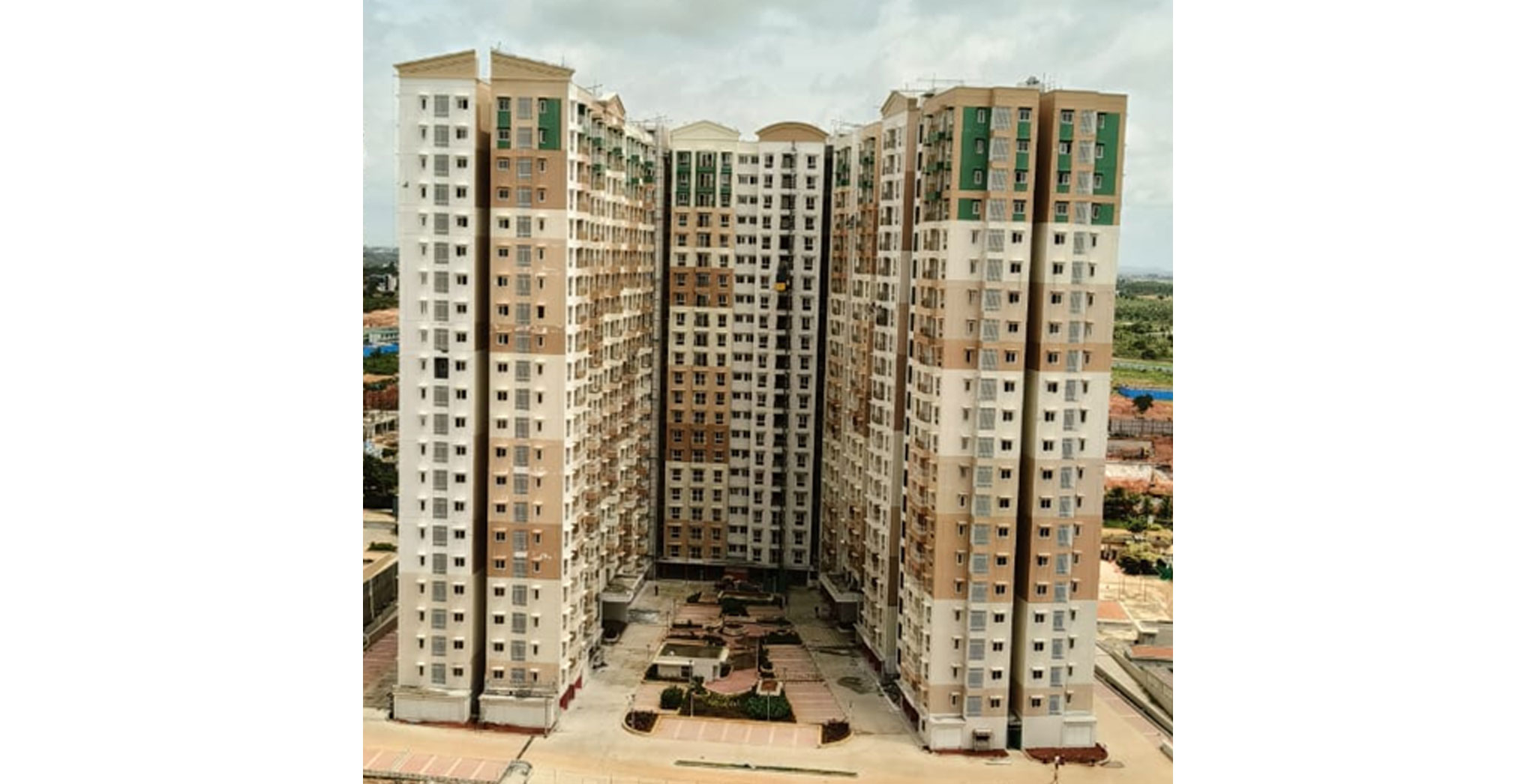

Status Images of Luminaire

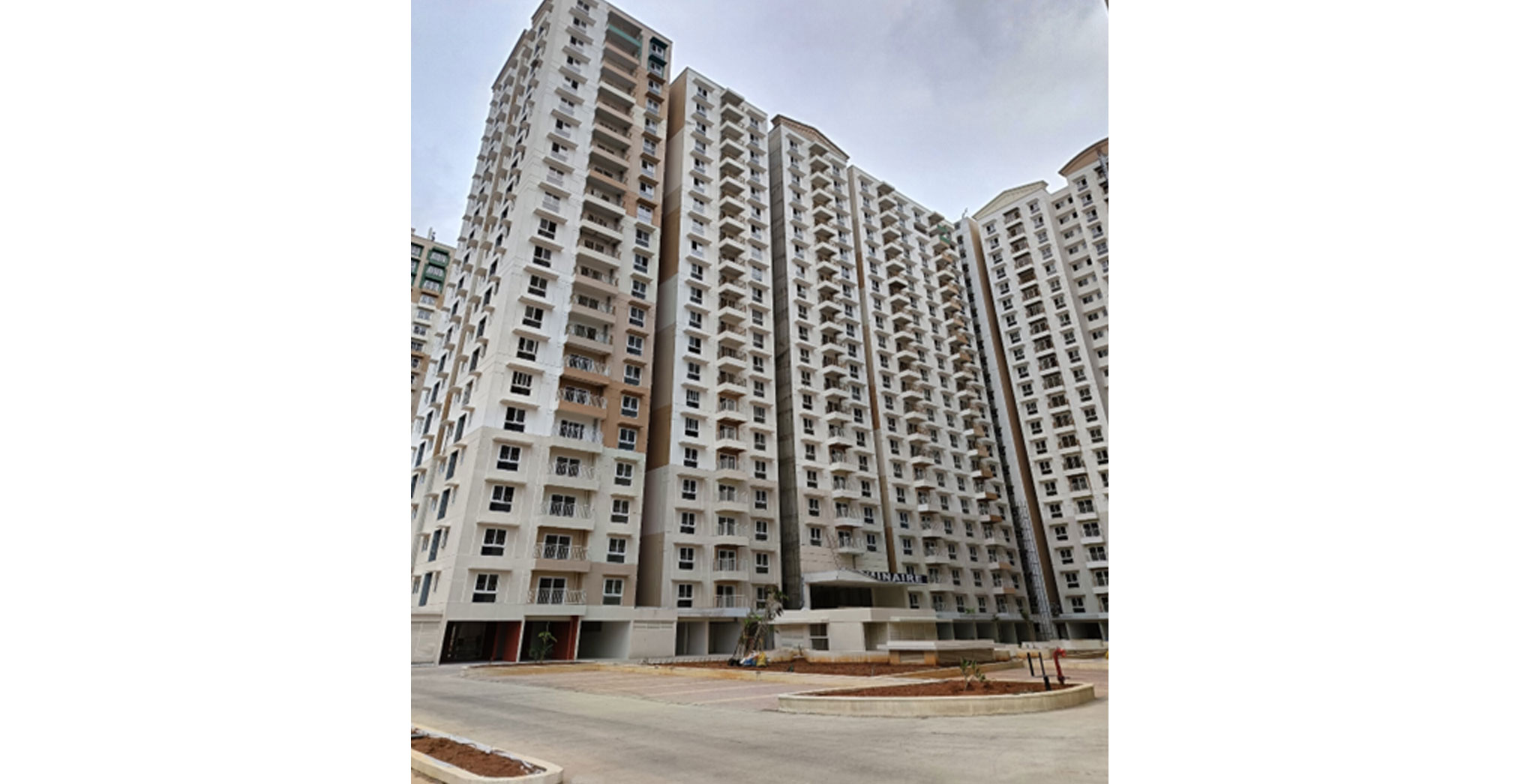

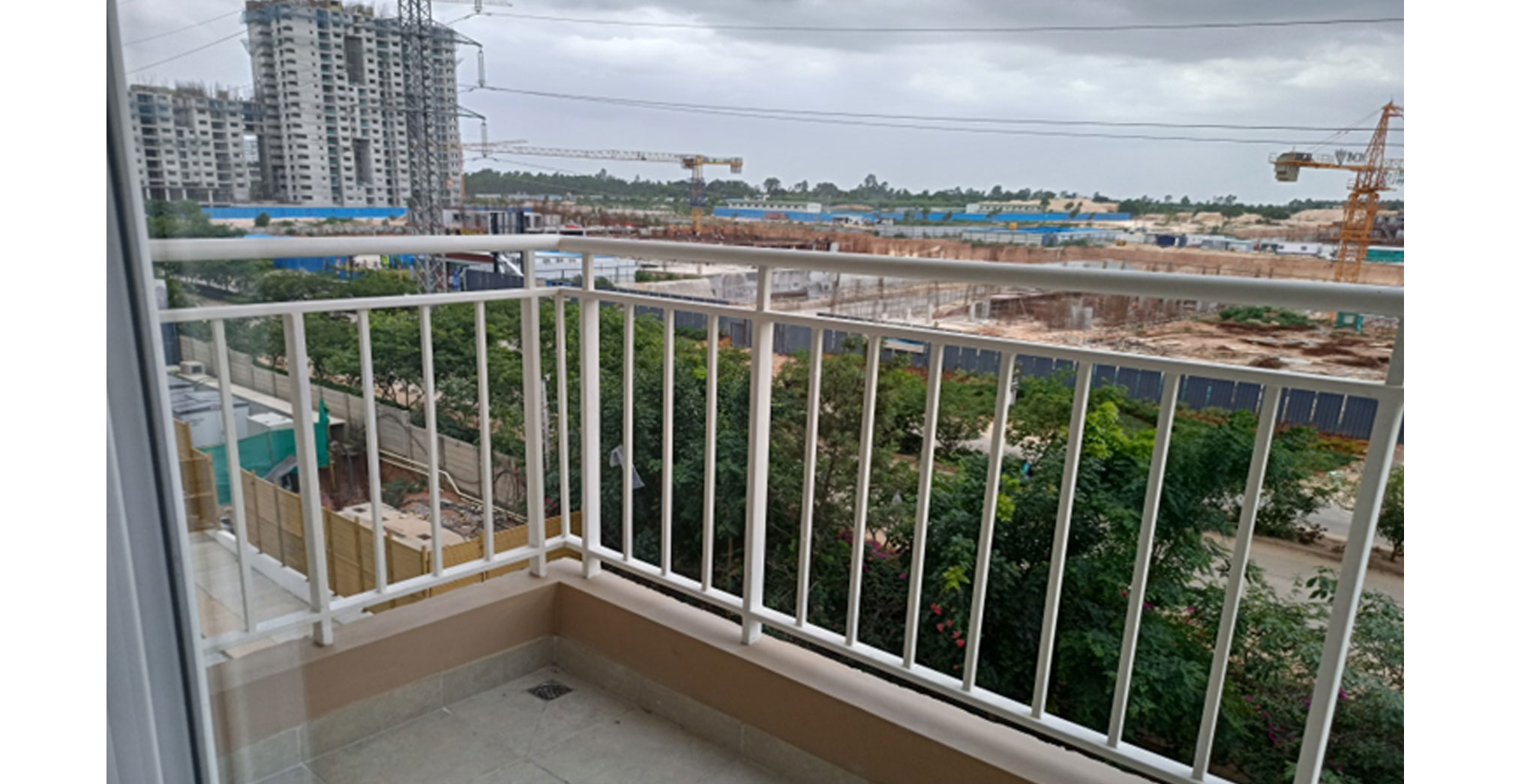

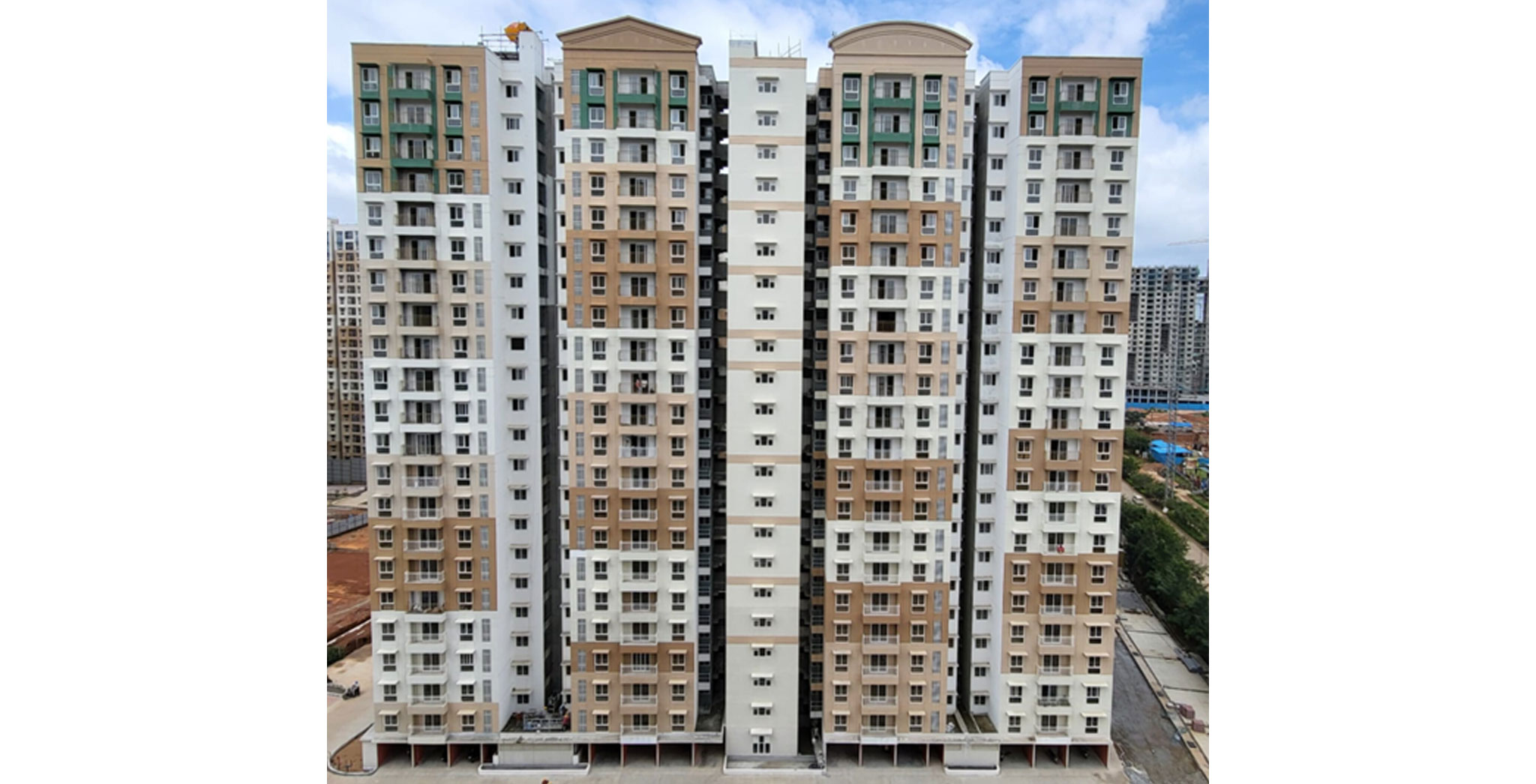

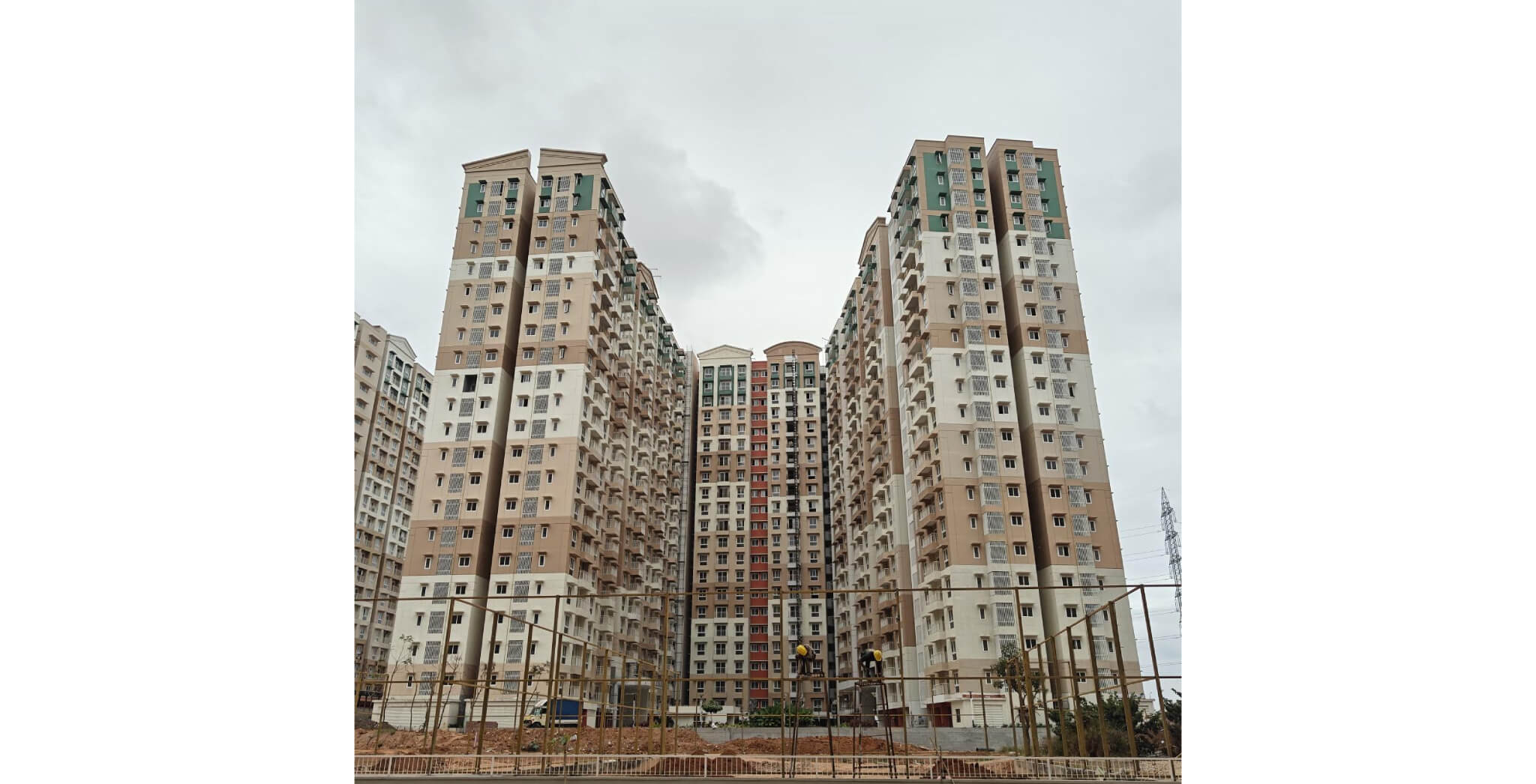

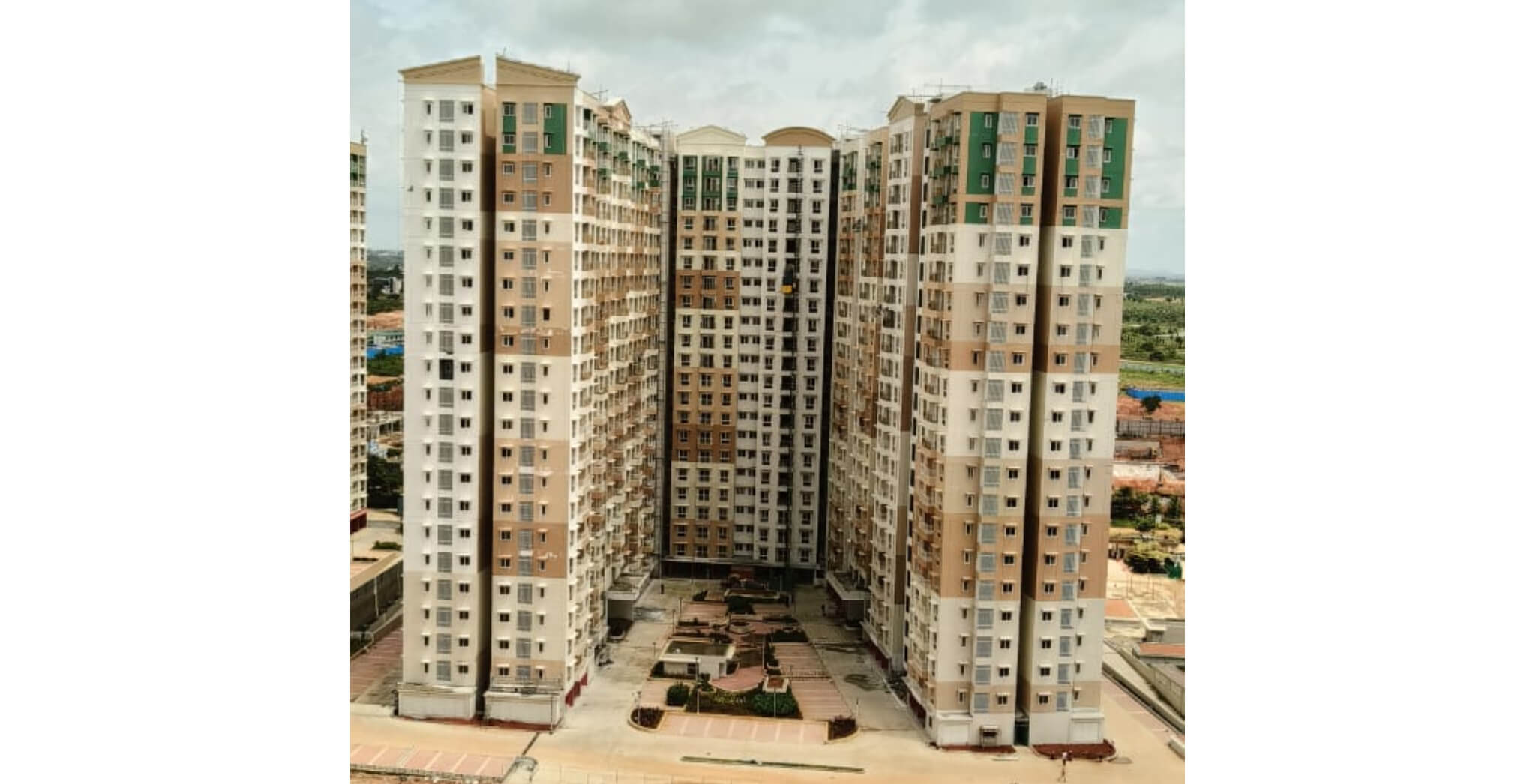

Front View - External painting Works
Dec 2025

DRAG

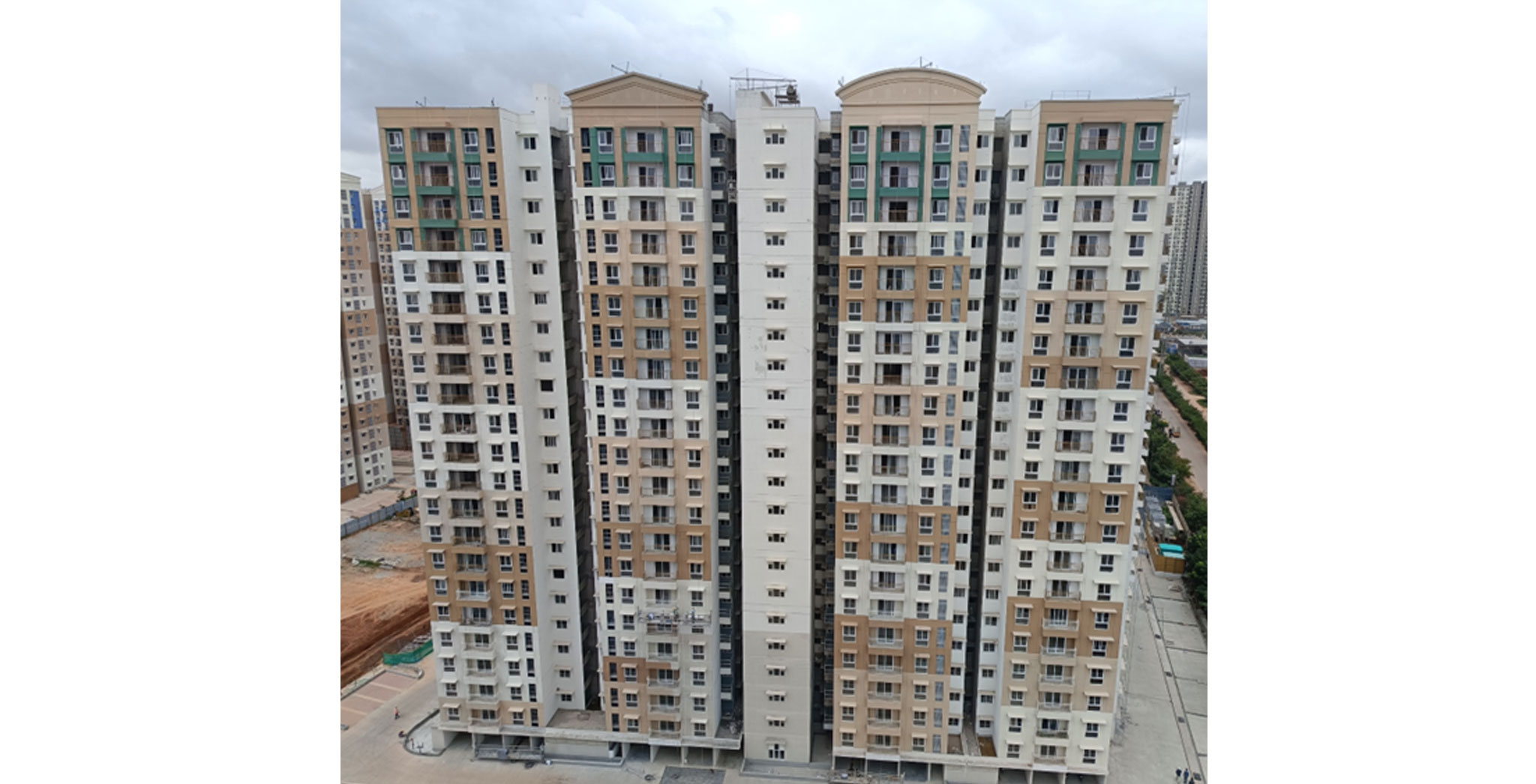

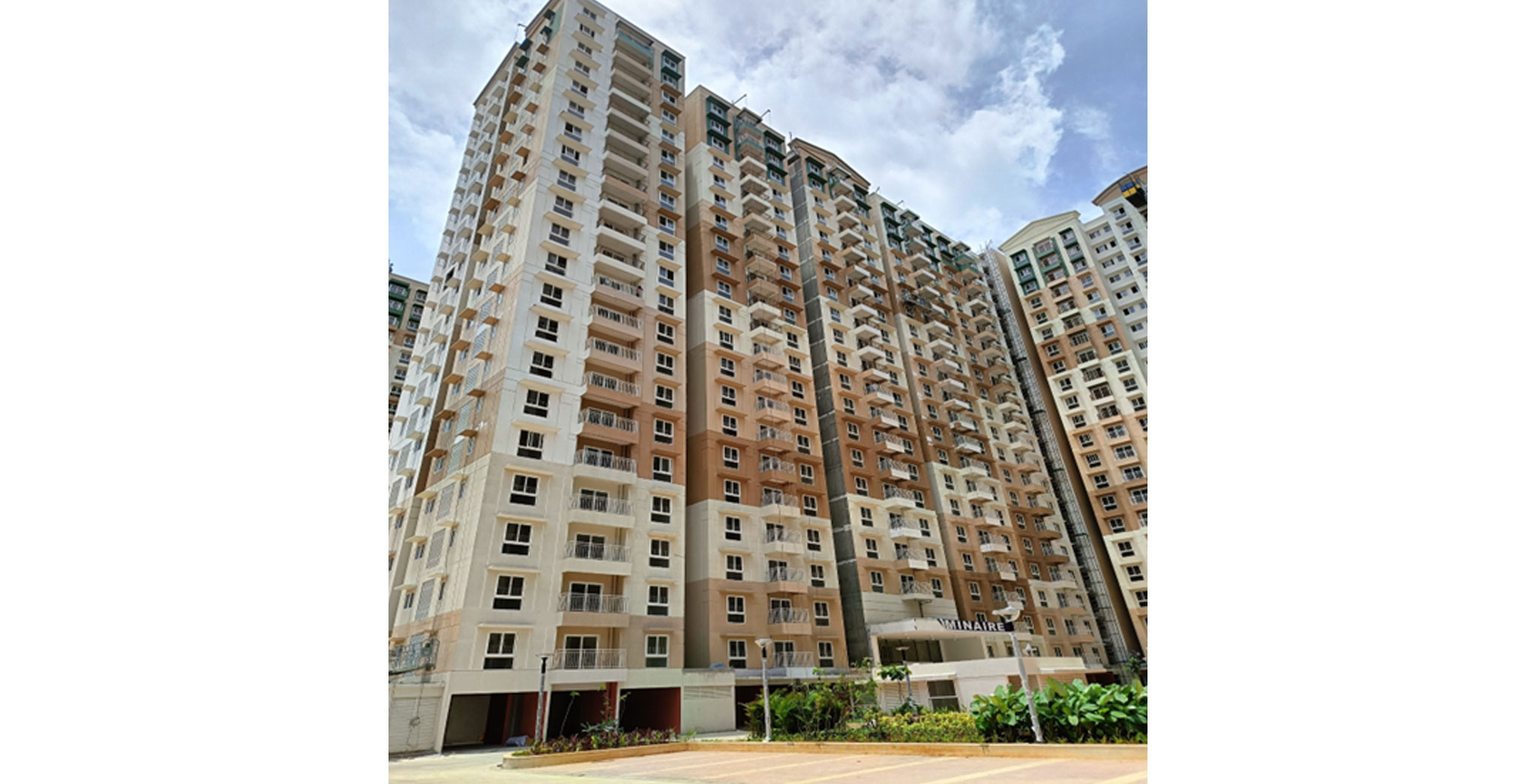

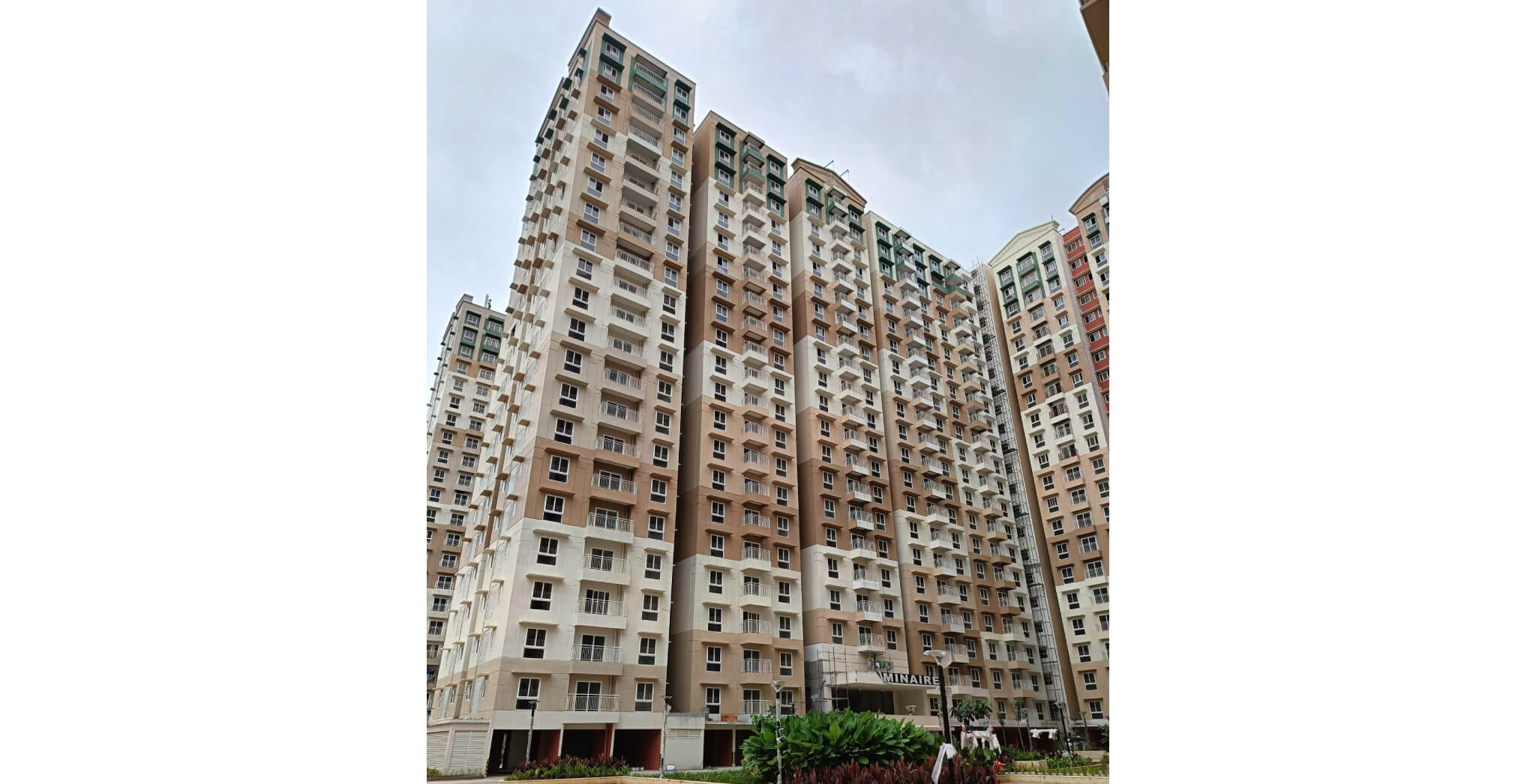

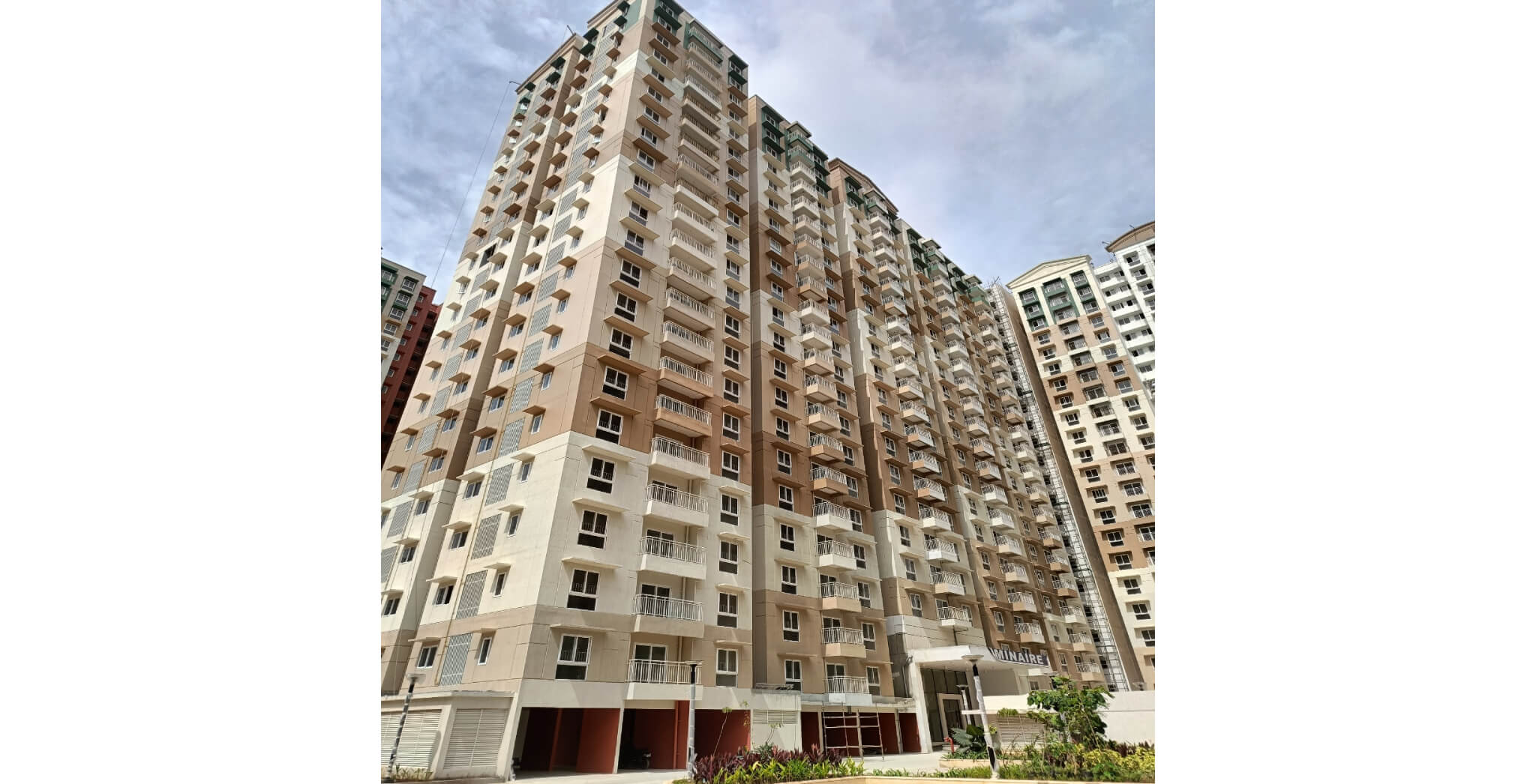

Wing A - Painting Work
Dec 2025

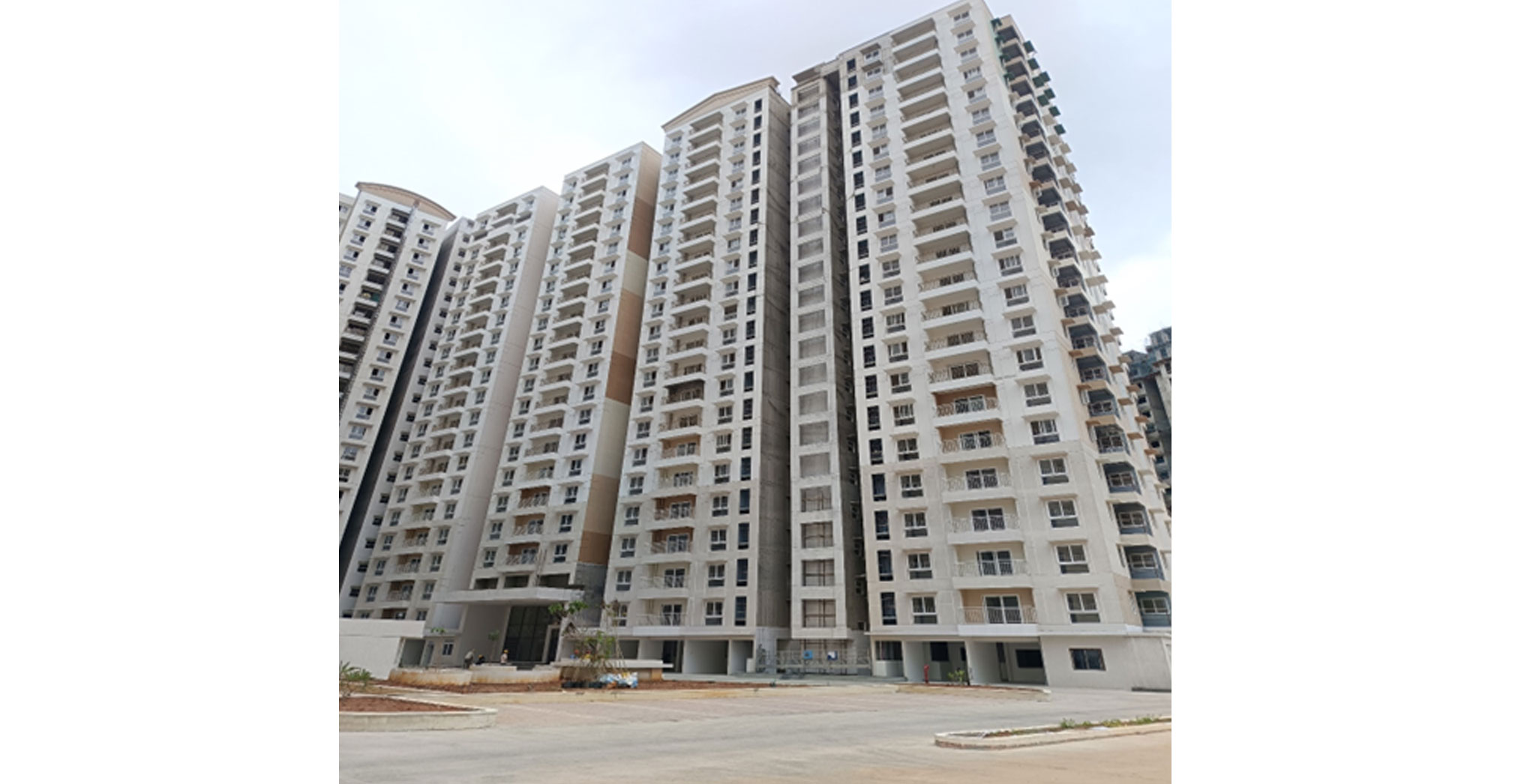

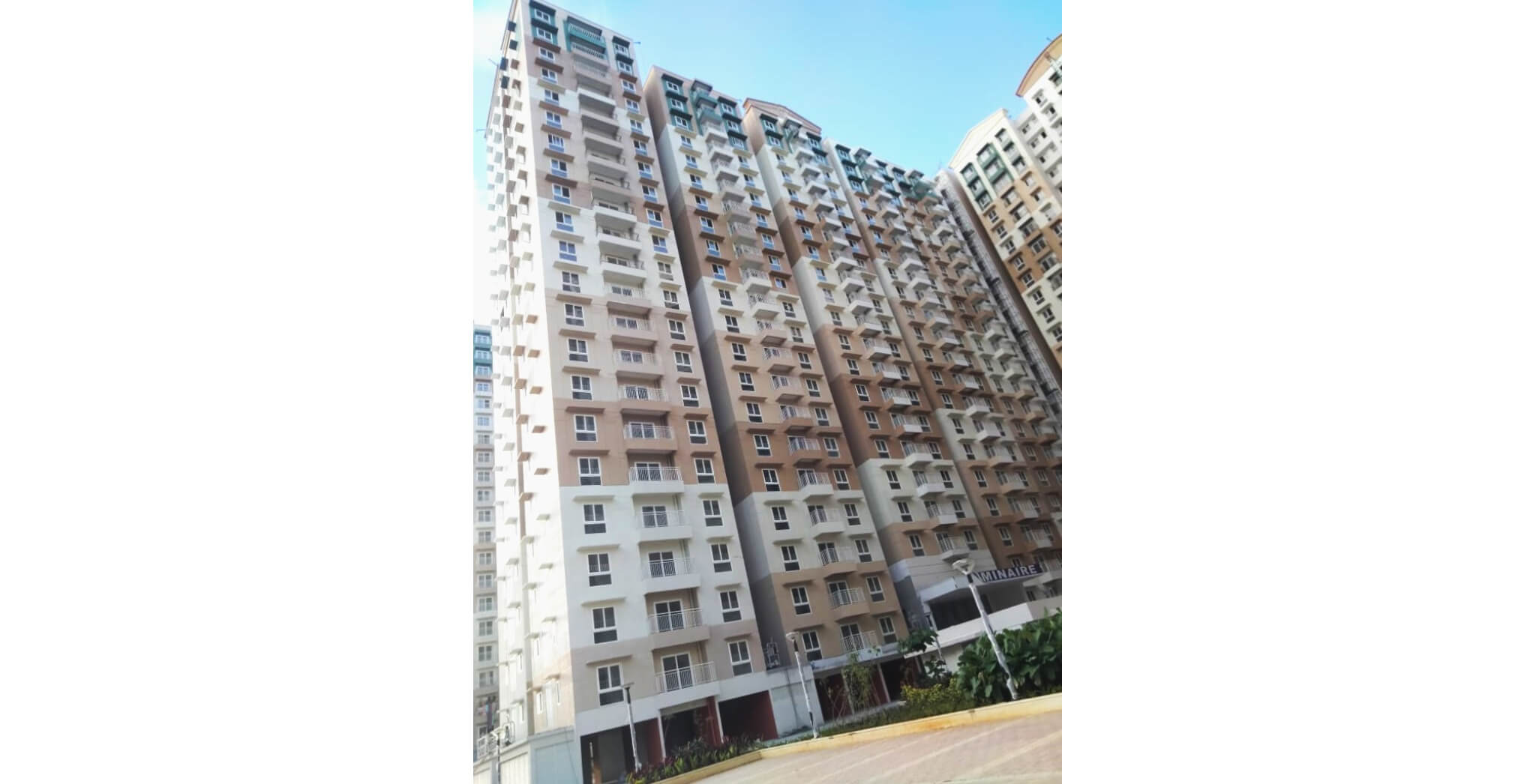

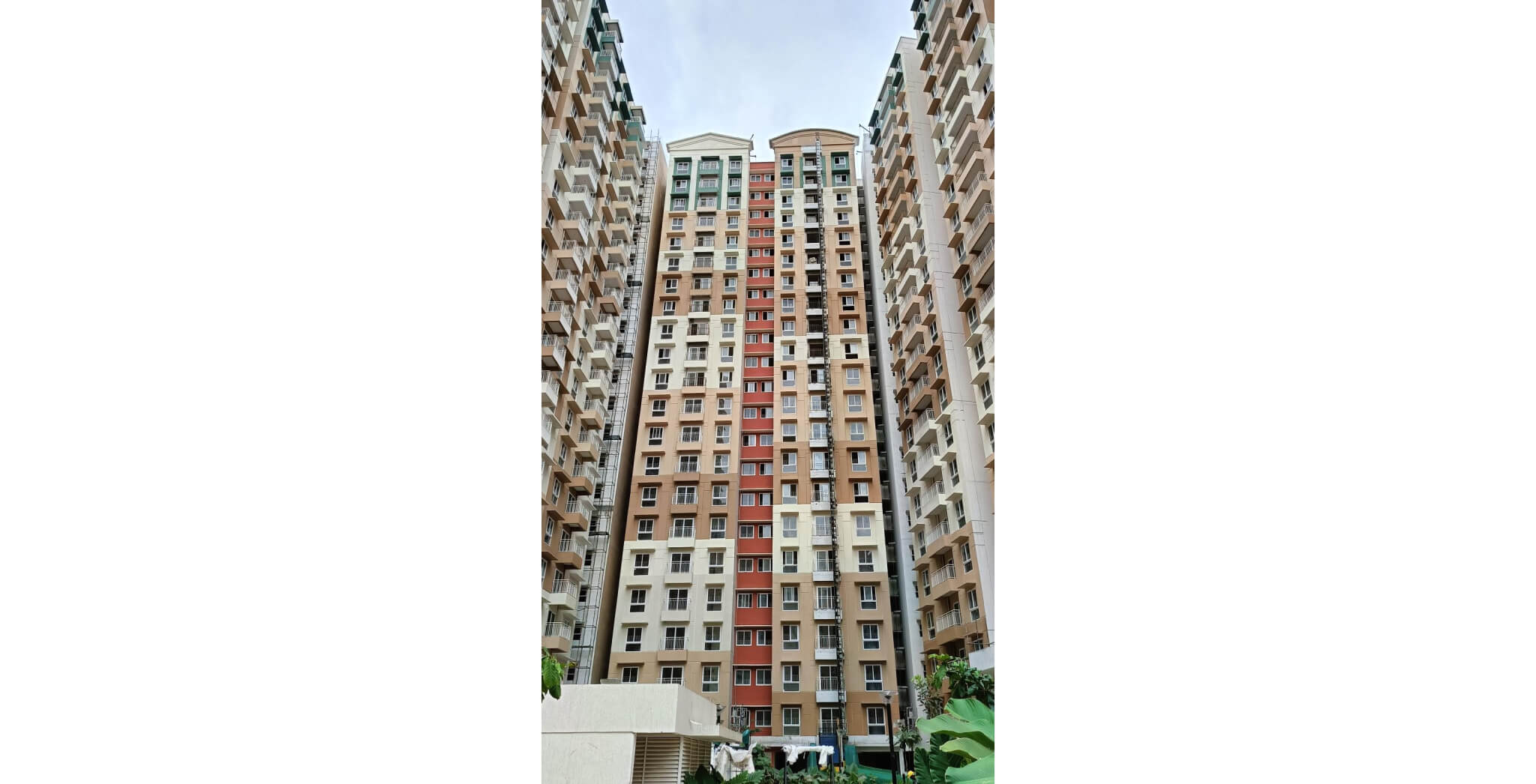

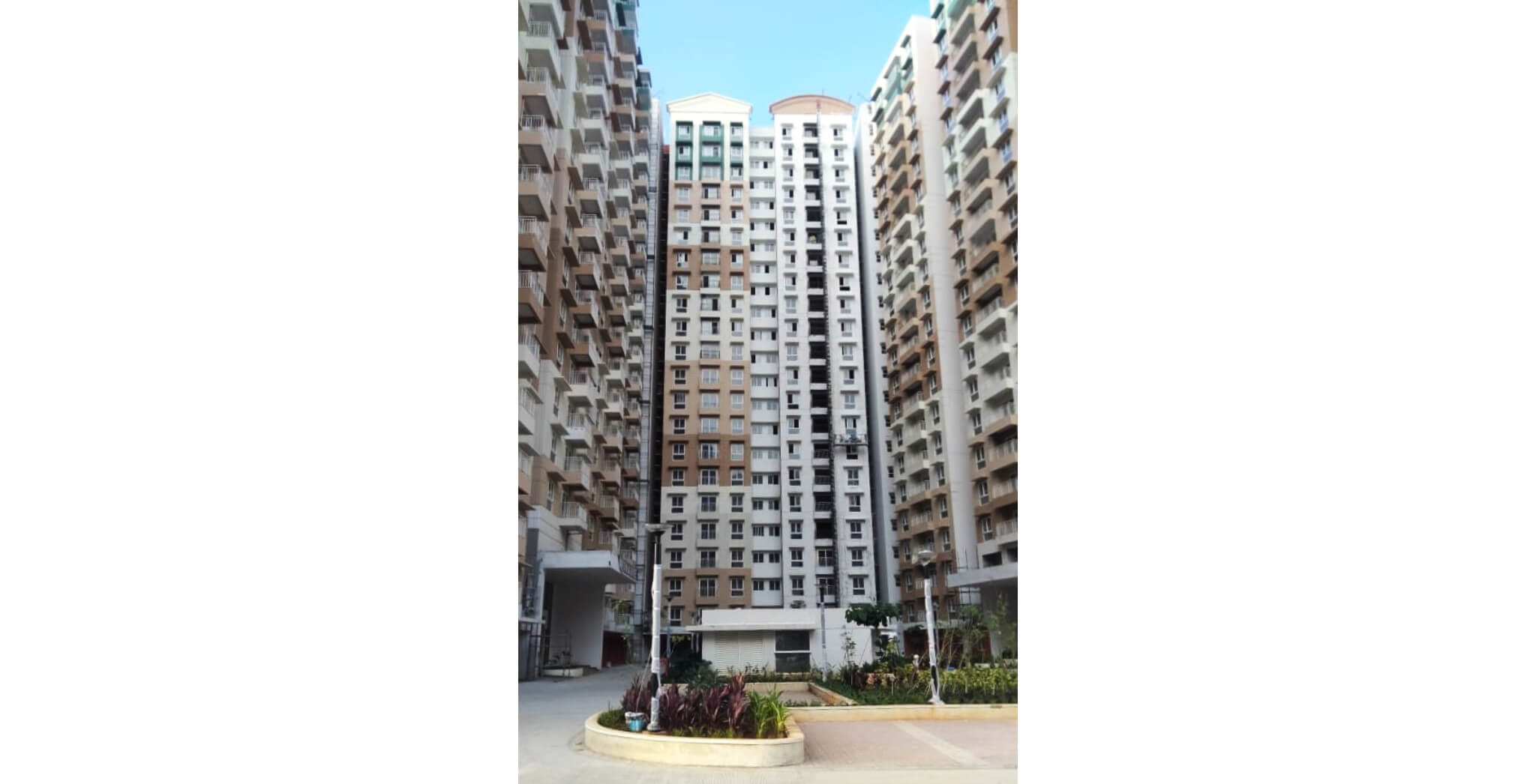

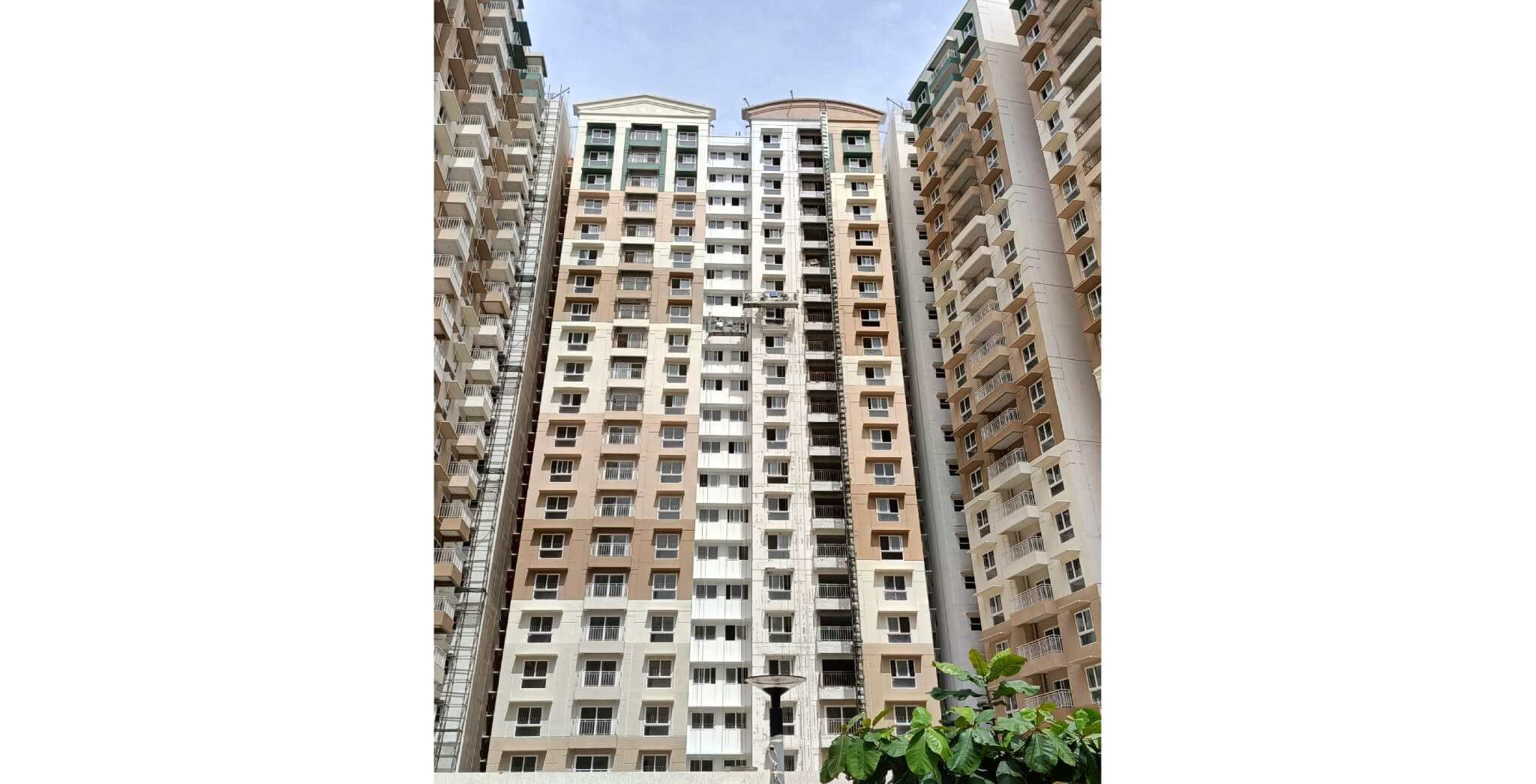

Wing B - Above Terrace level painting work
Dec 2025

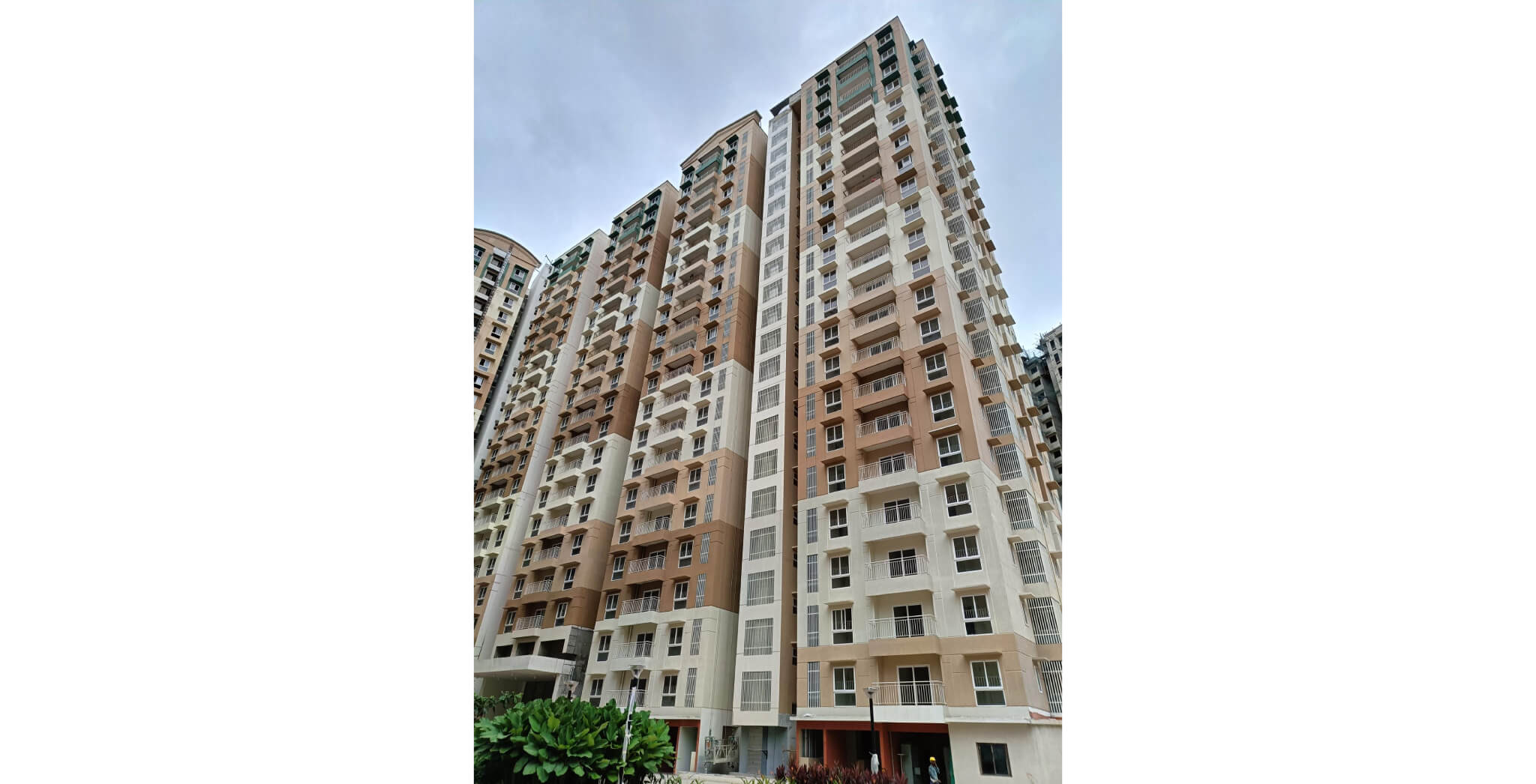

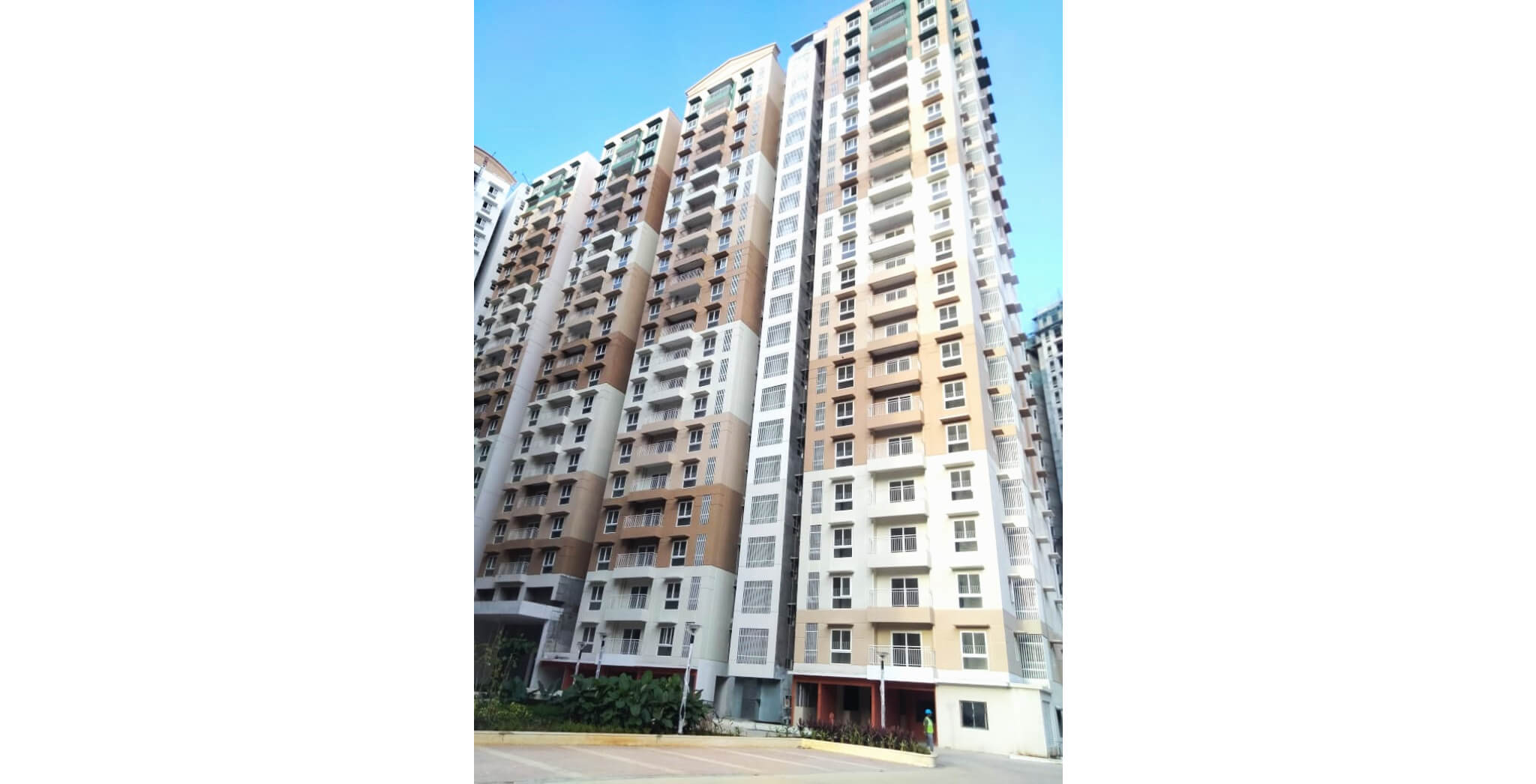

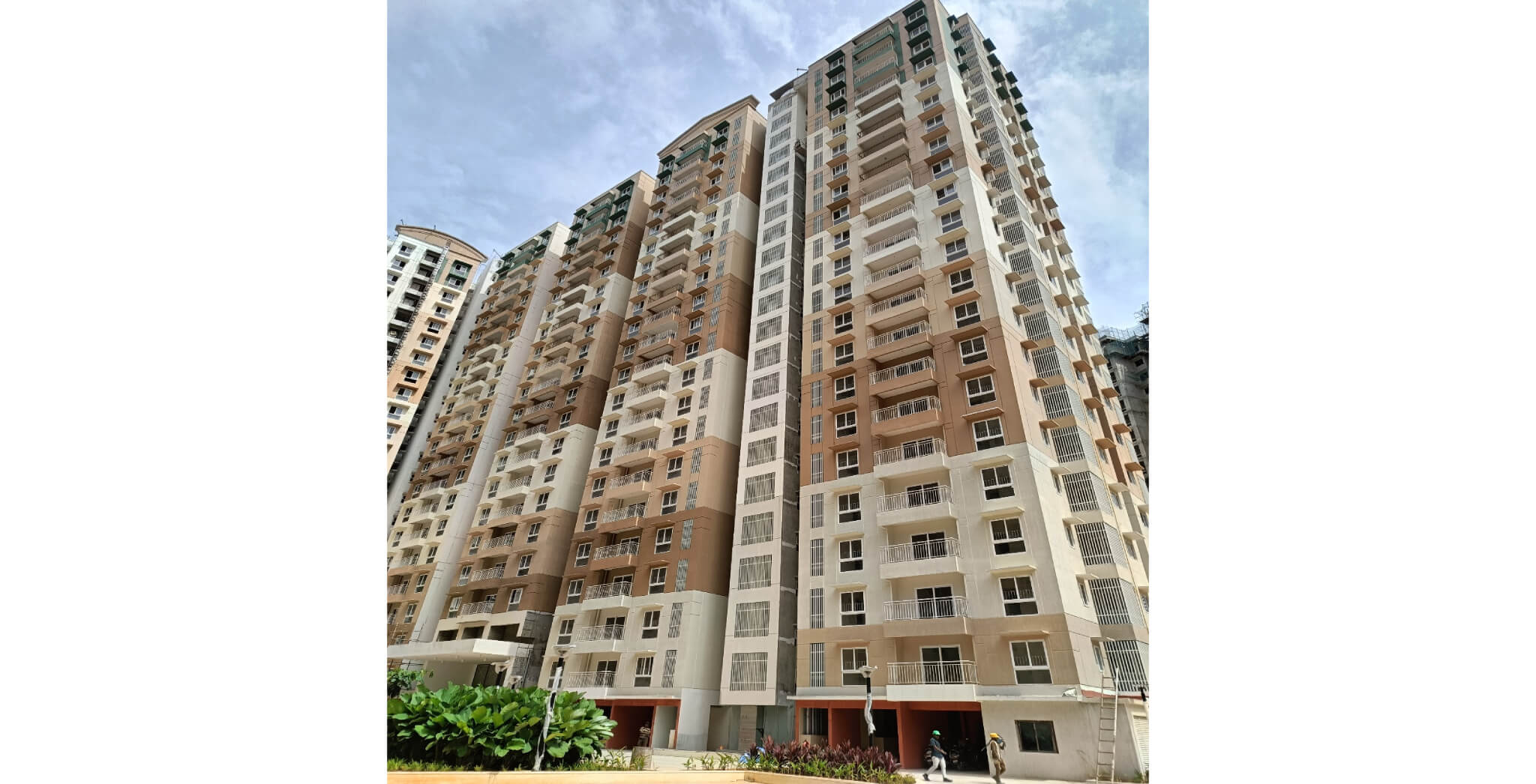

Wing C - Above Terrace floor level painting work
Dec 2025

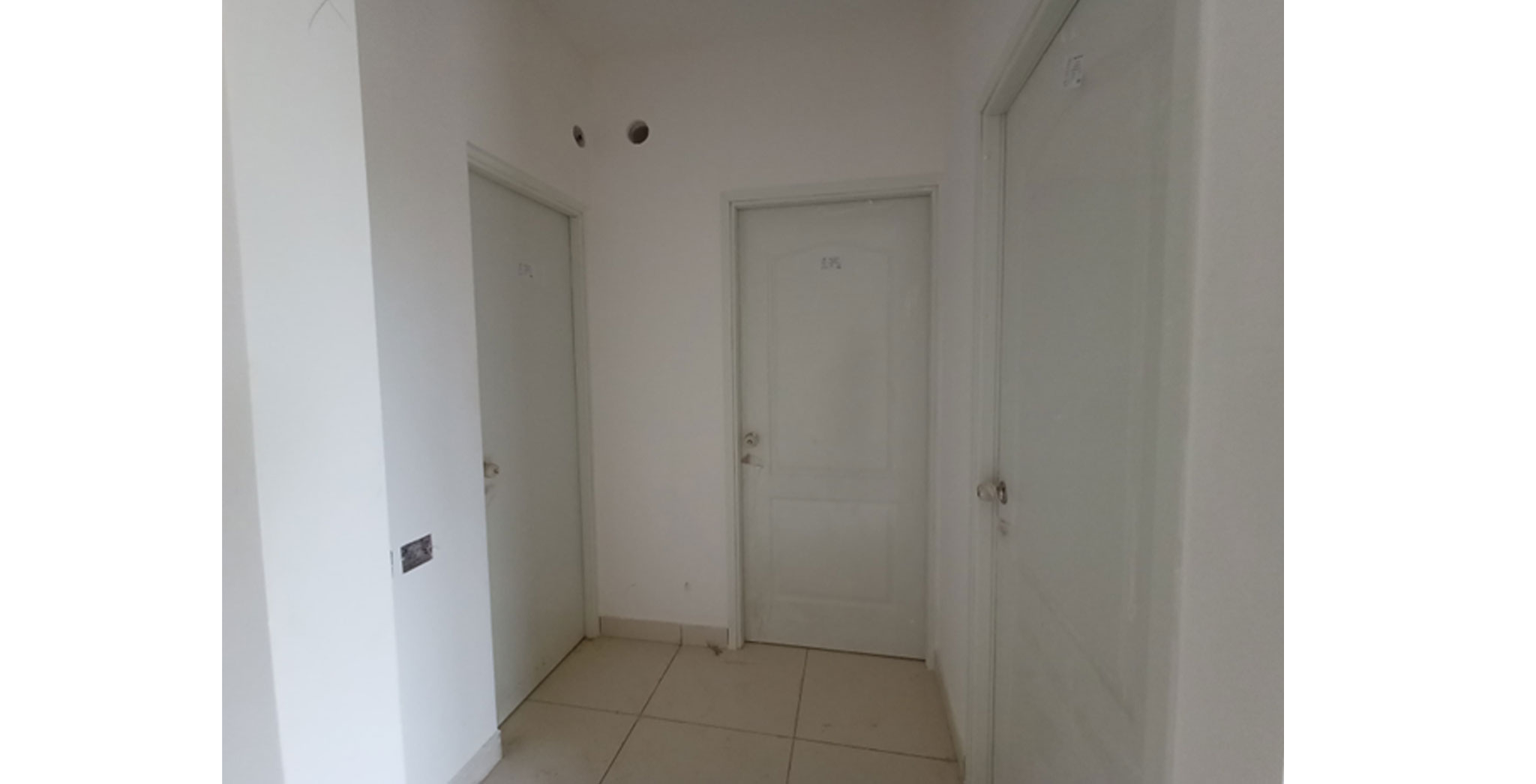

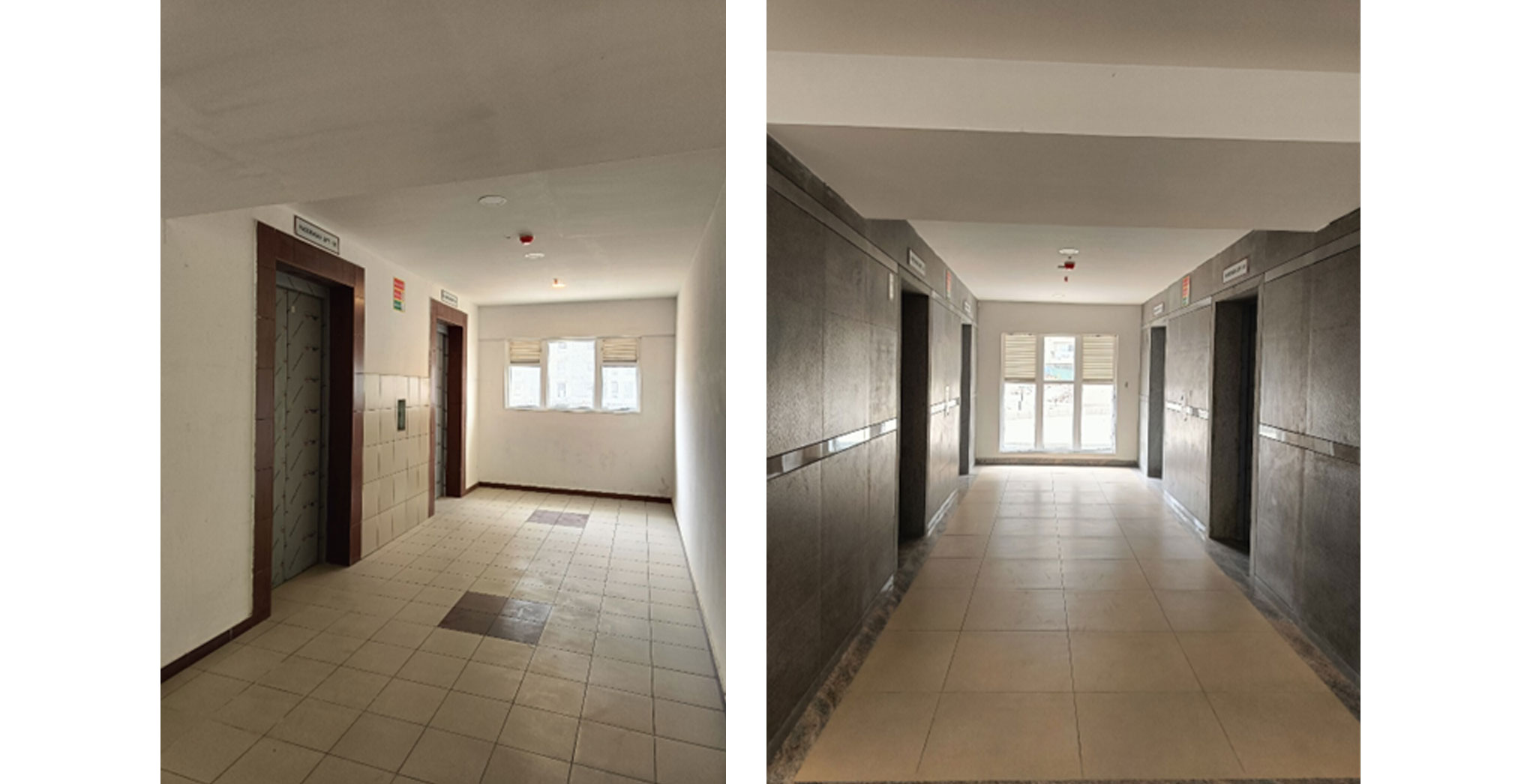

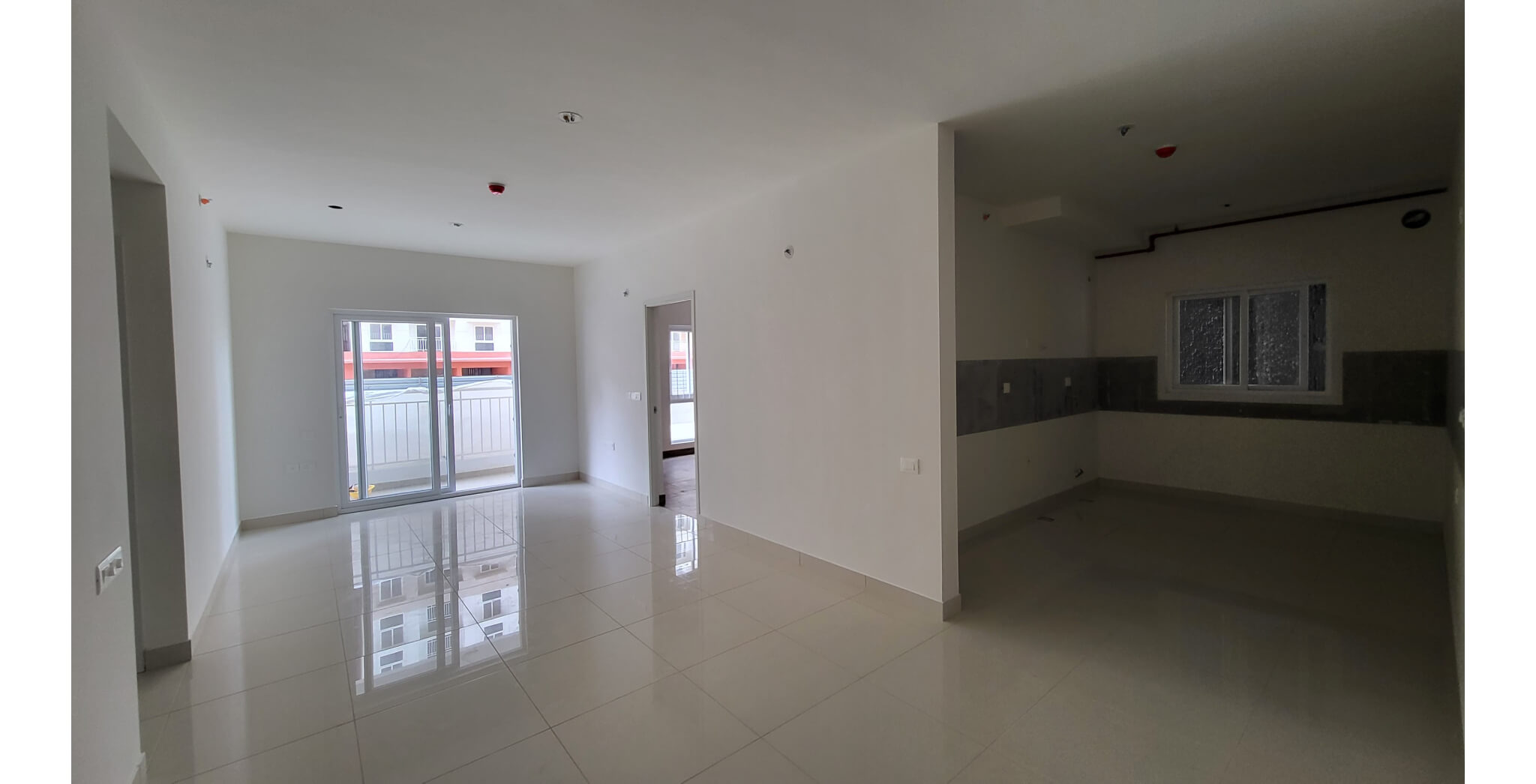

Internal flats finishing work
Dec 2025

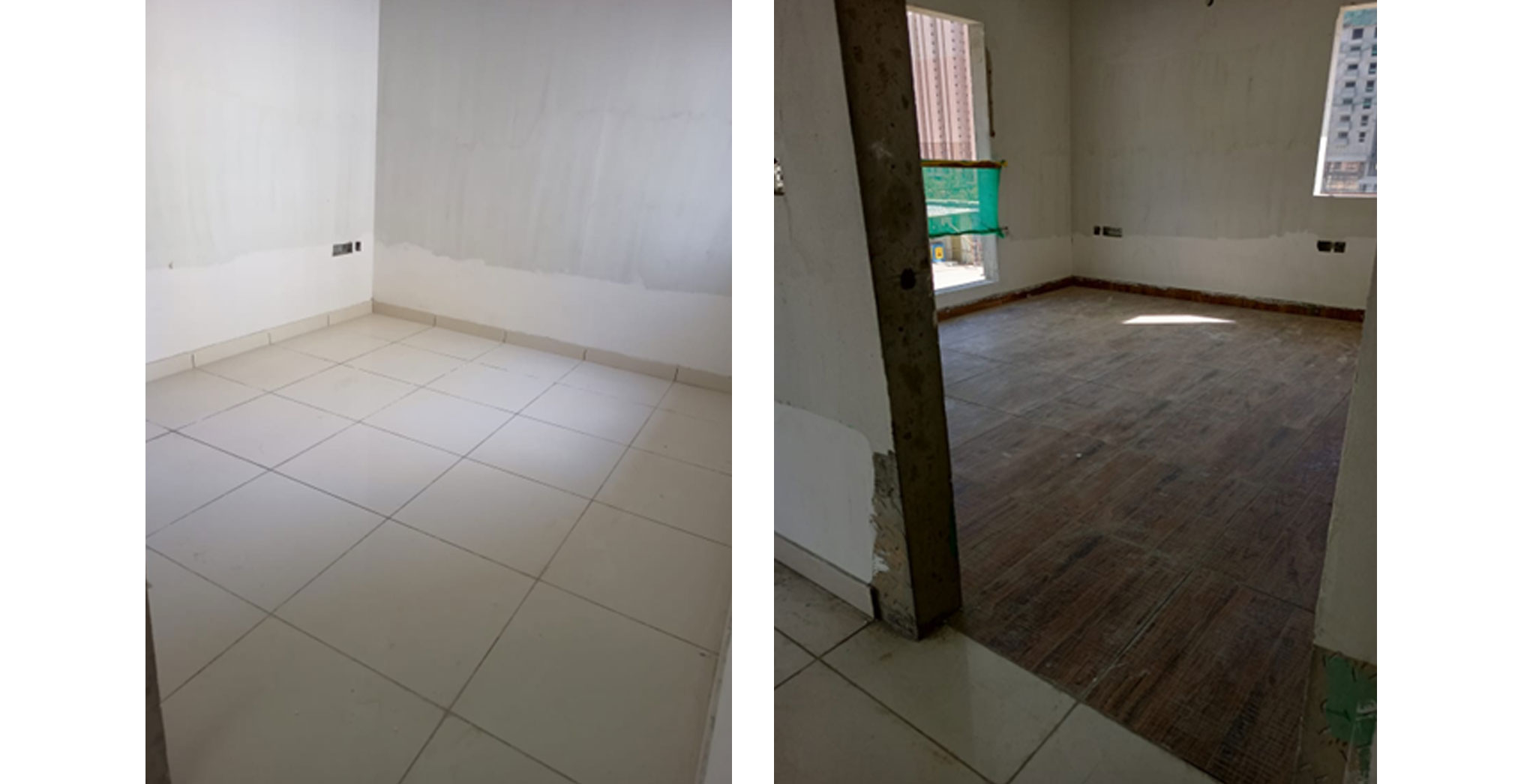

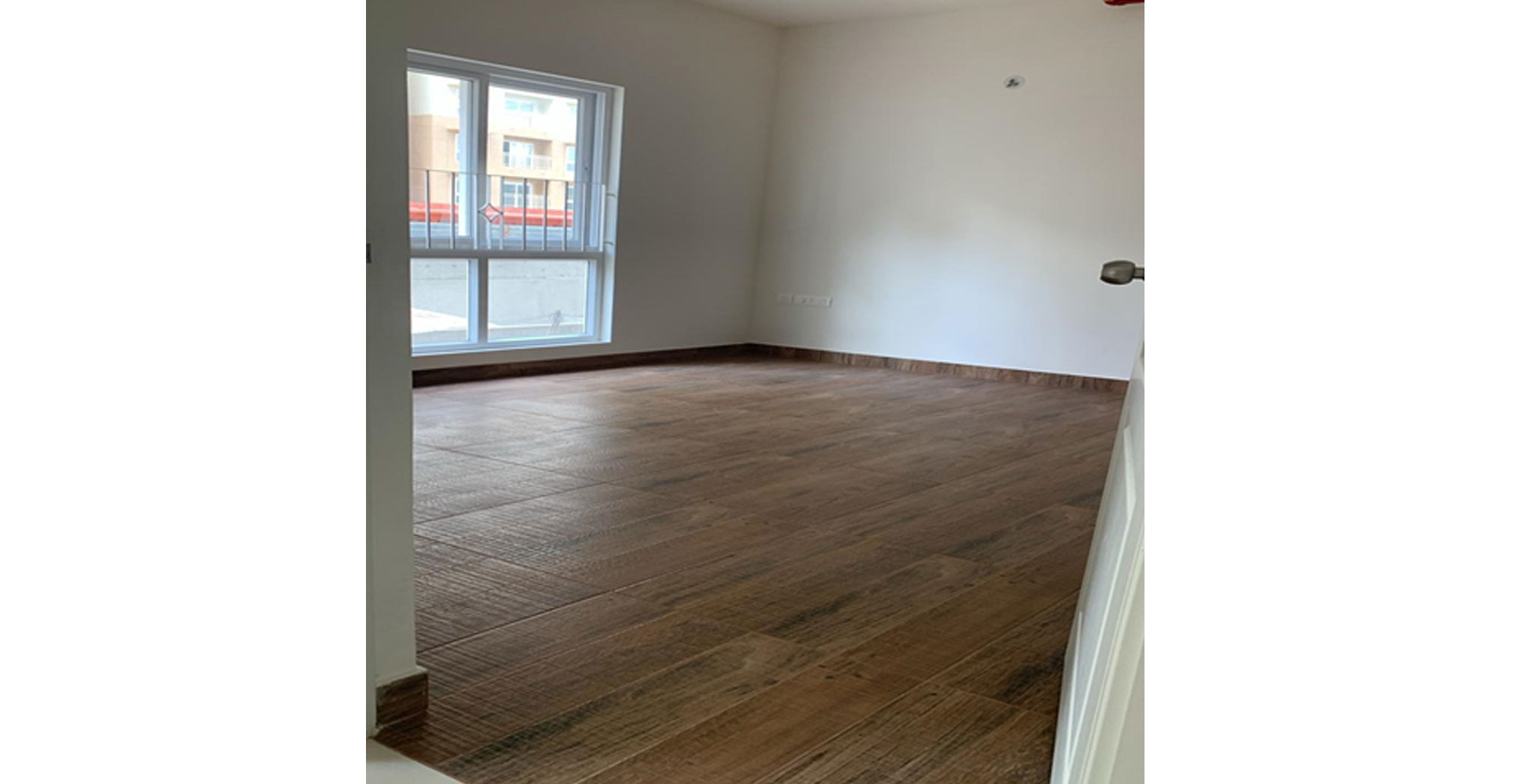

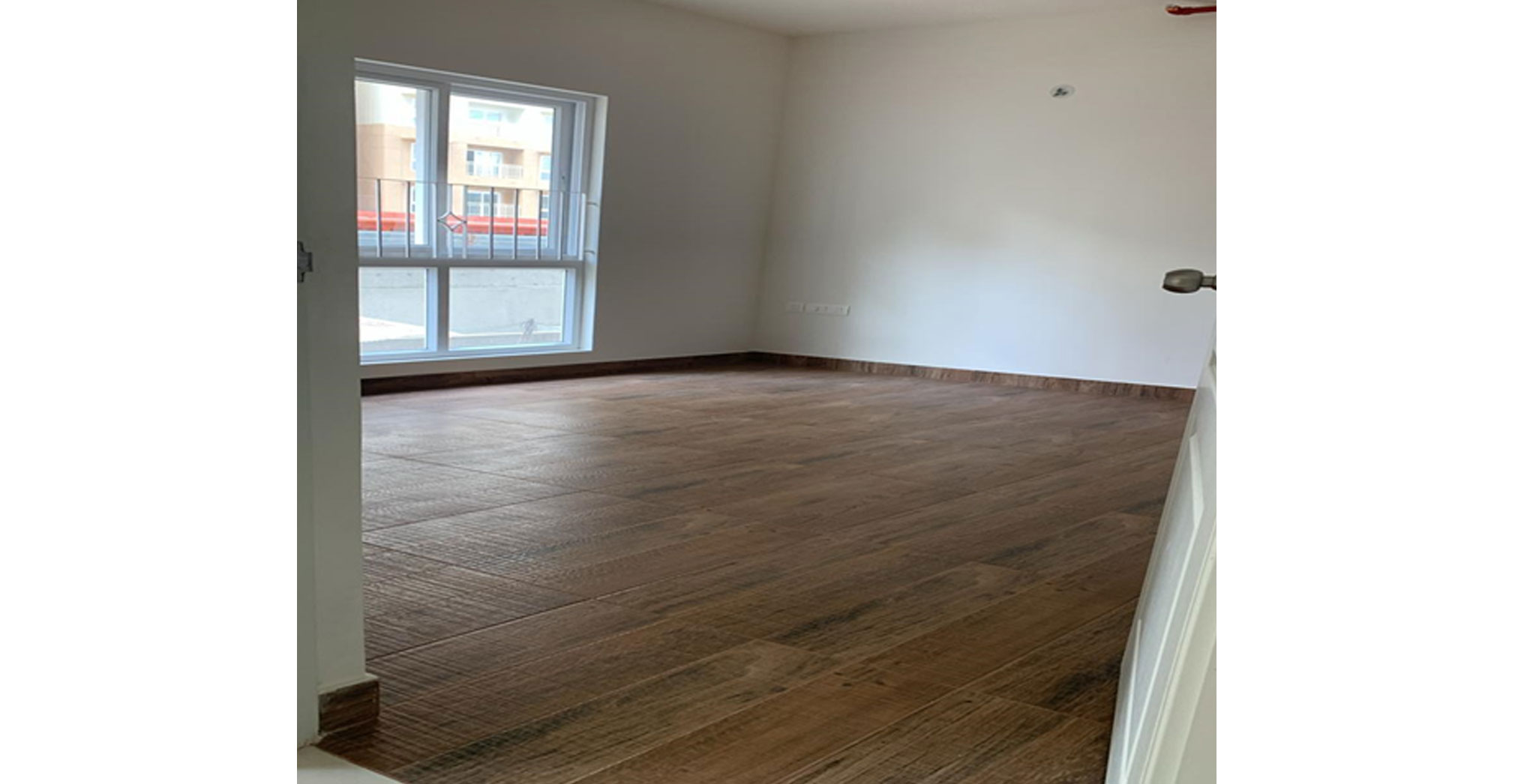

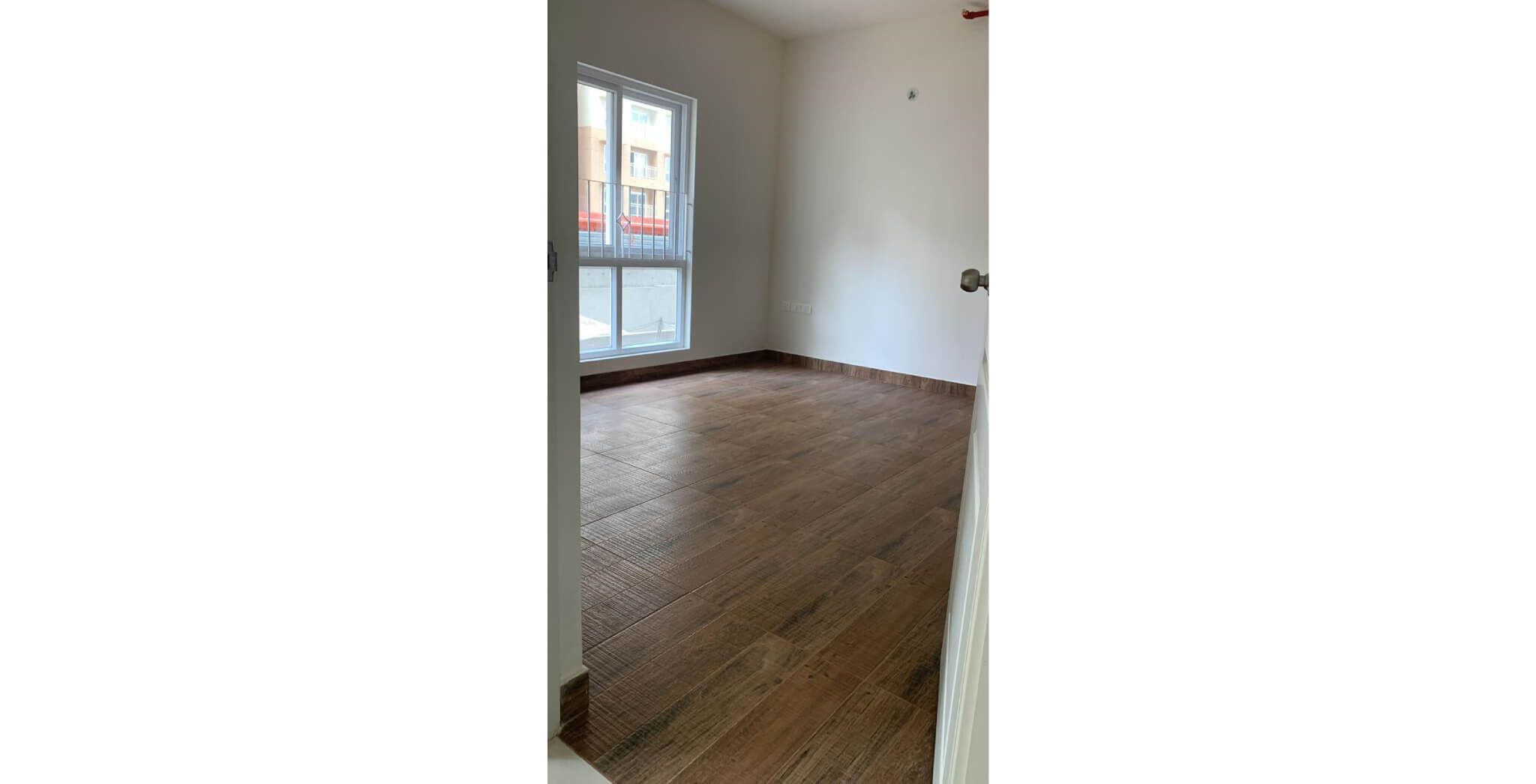

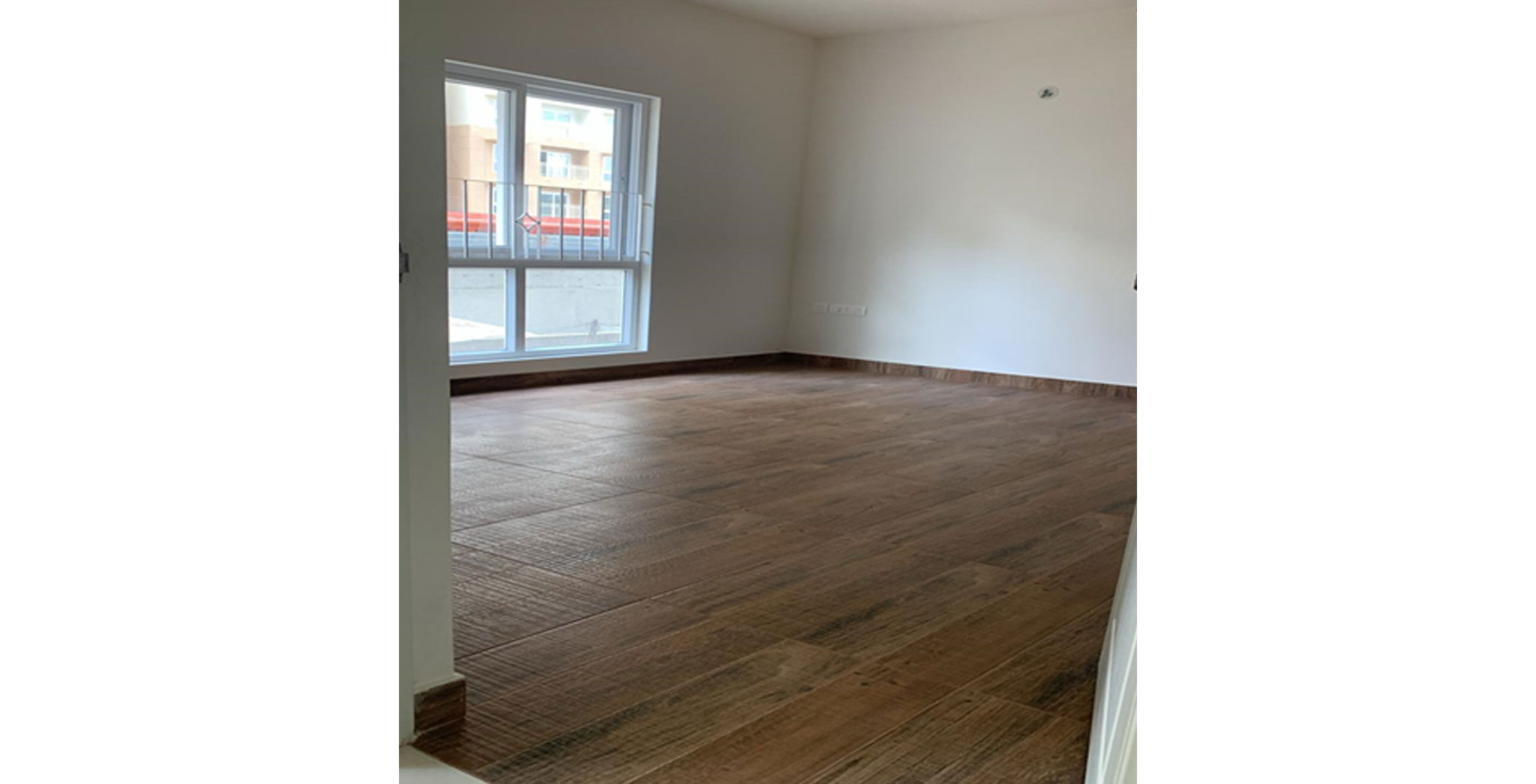

Flooring
Dec 2025

Internal Painting work
Dec 2025

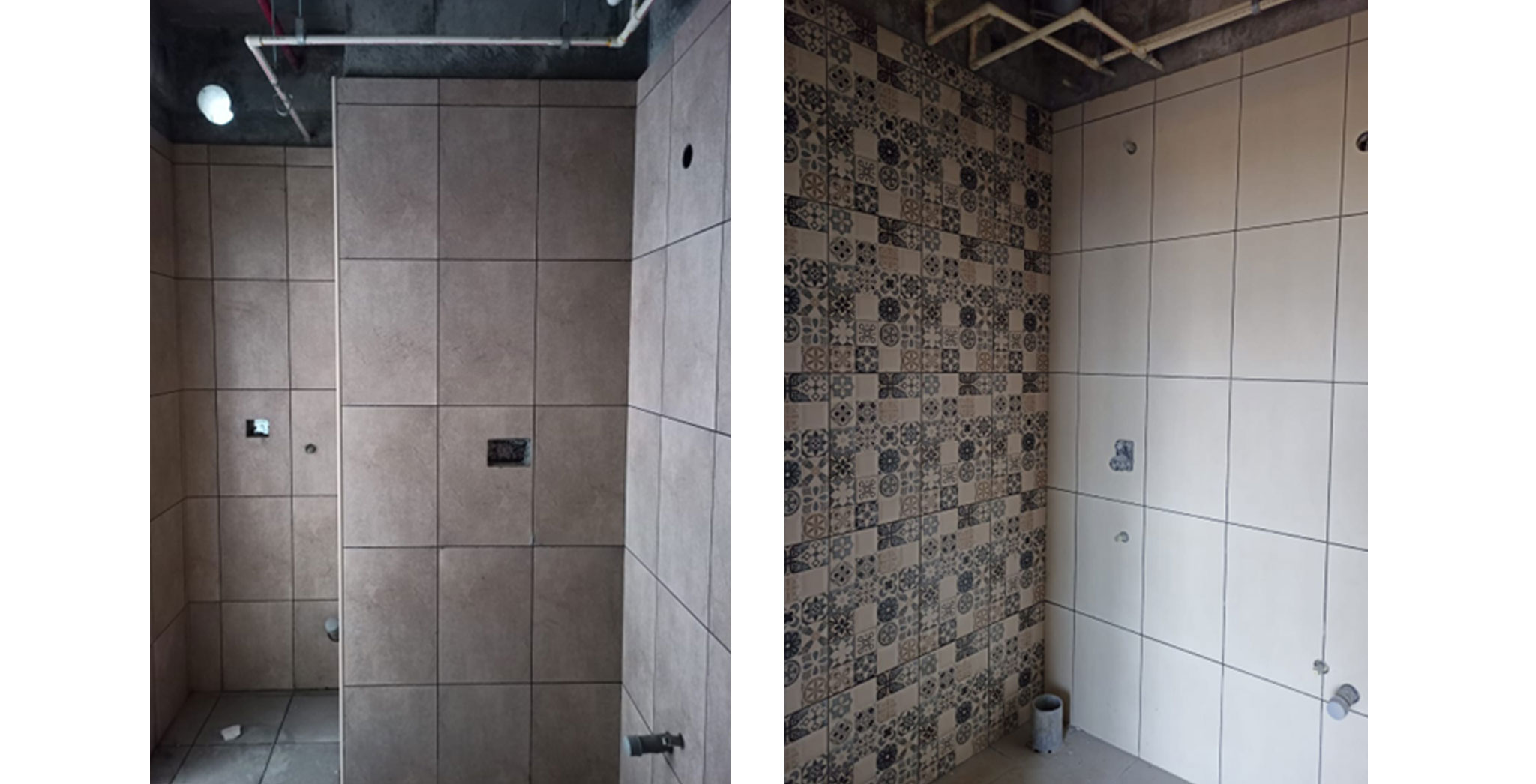

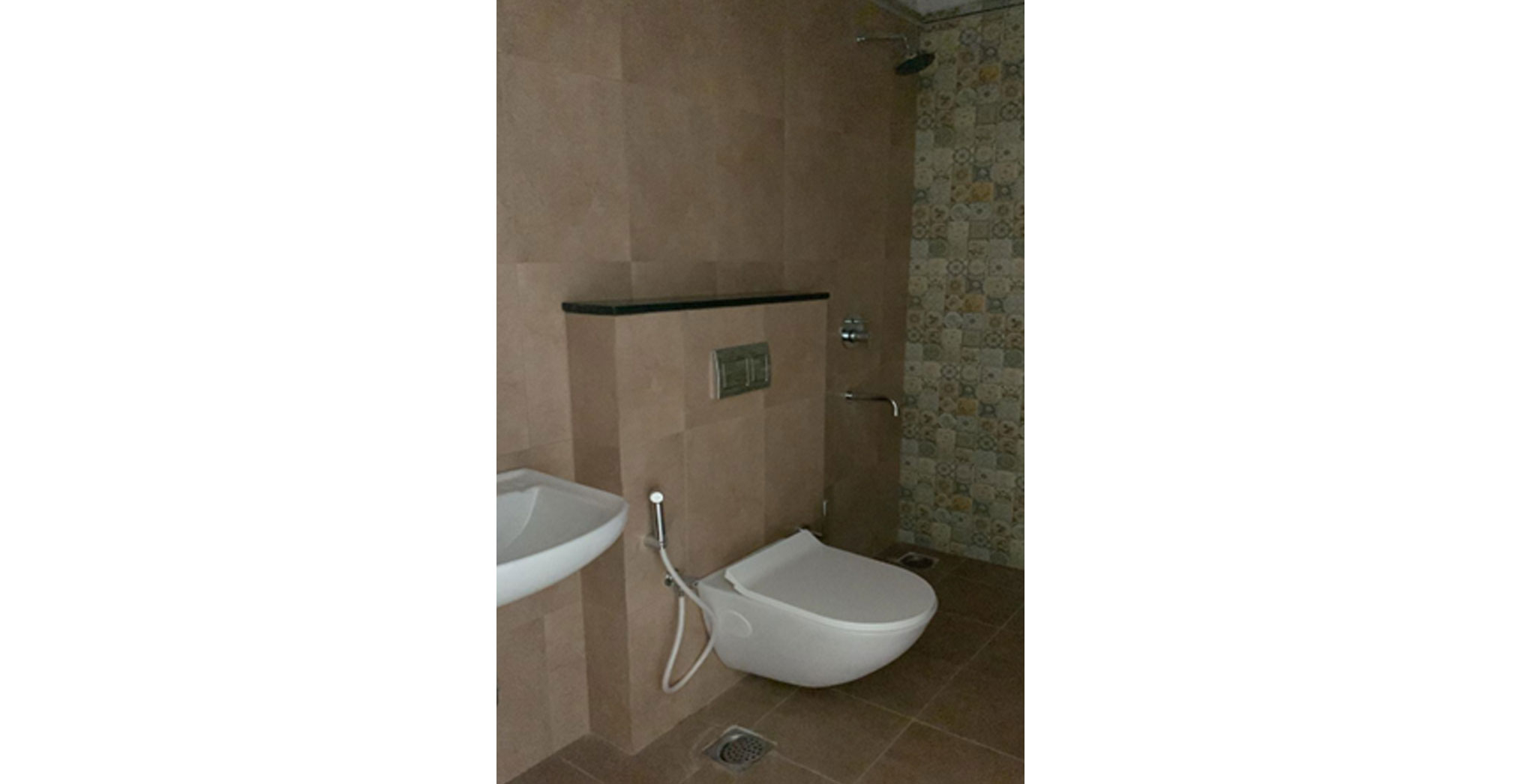

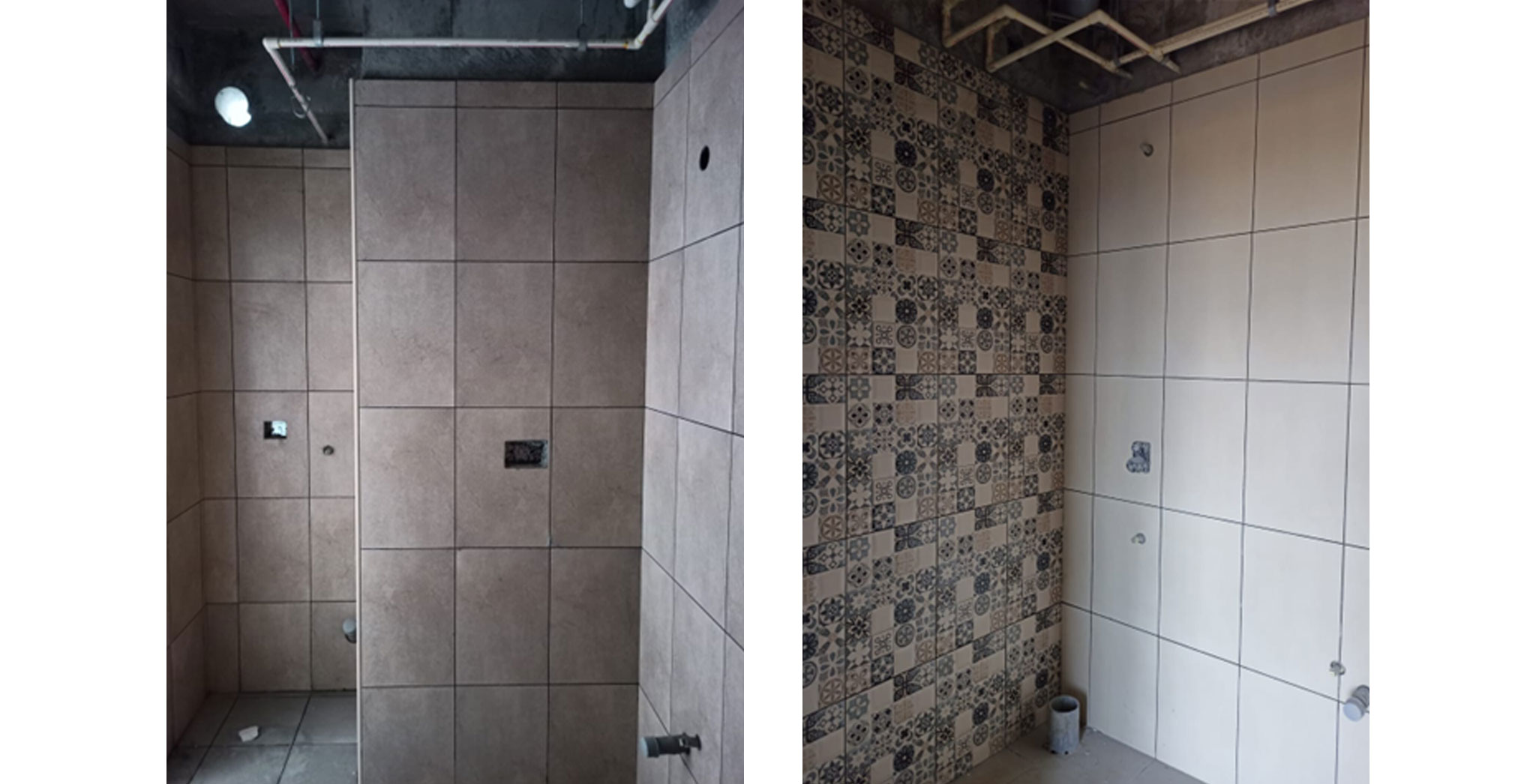

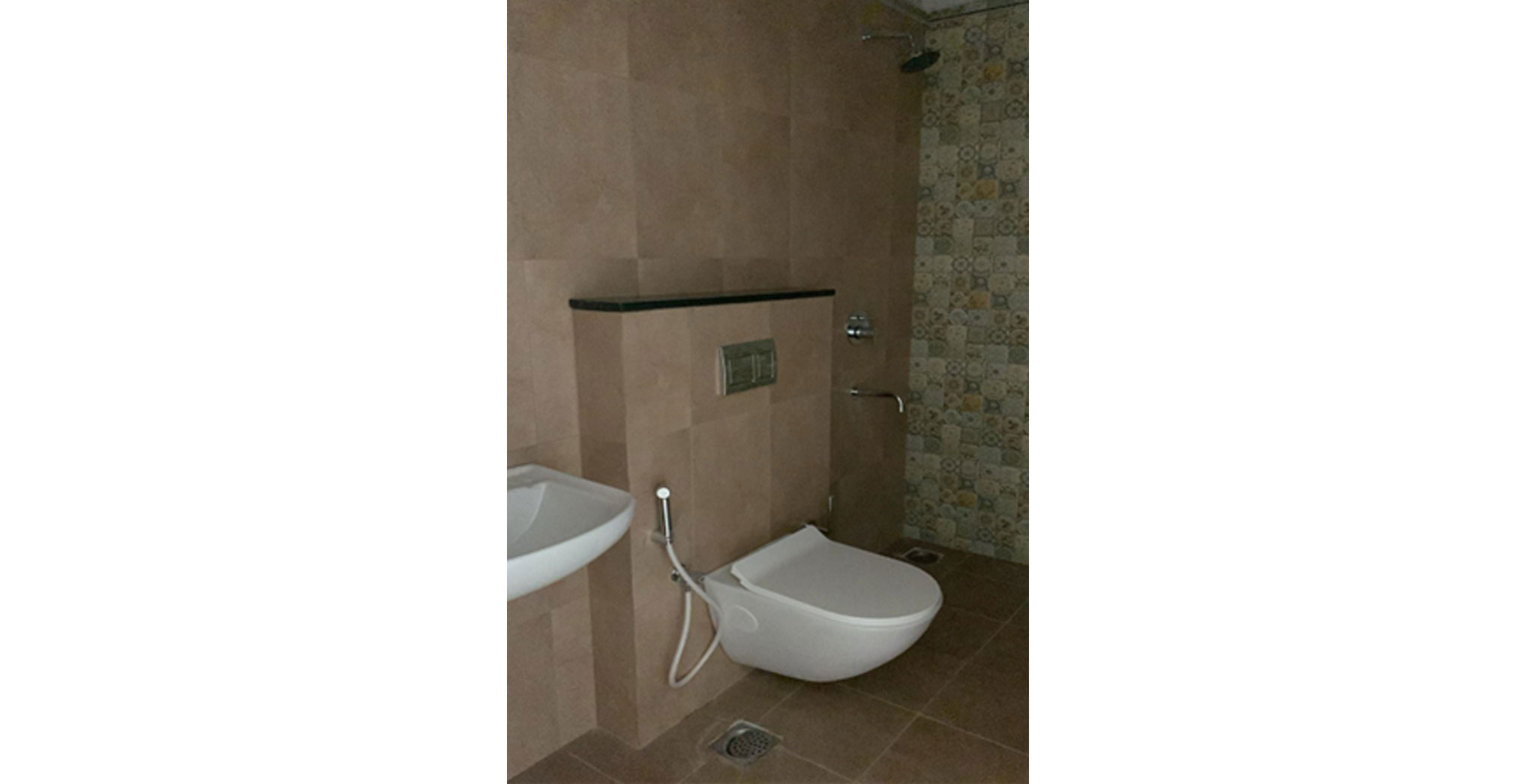

Sanitary fixtures work
Dec 2025

Balcony railing work
Dec 2025

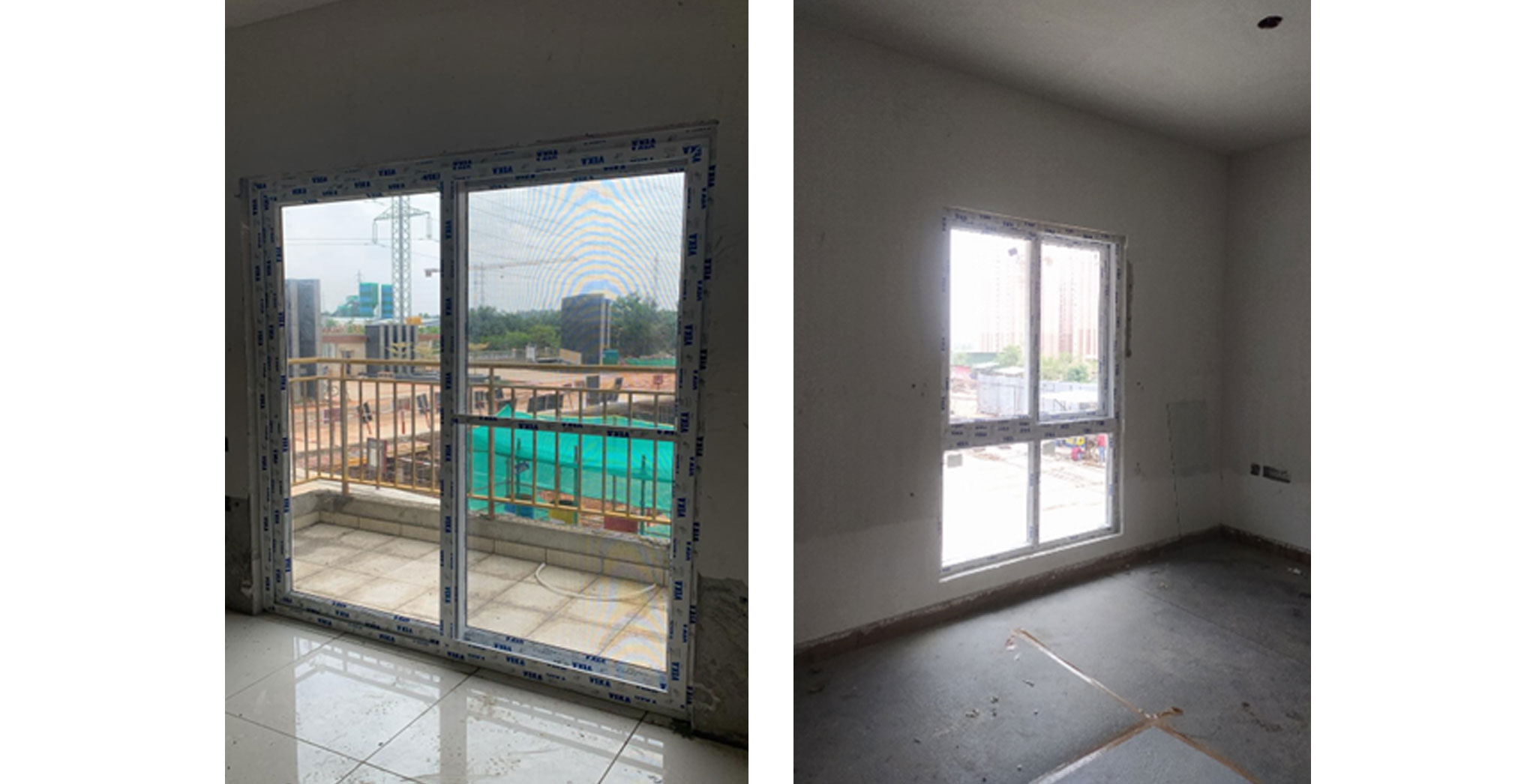

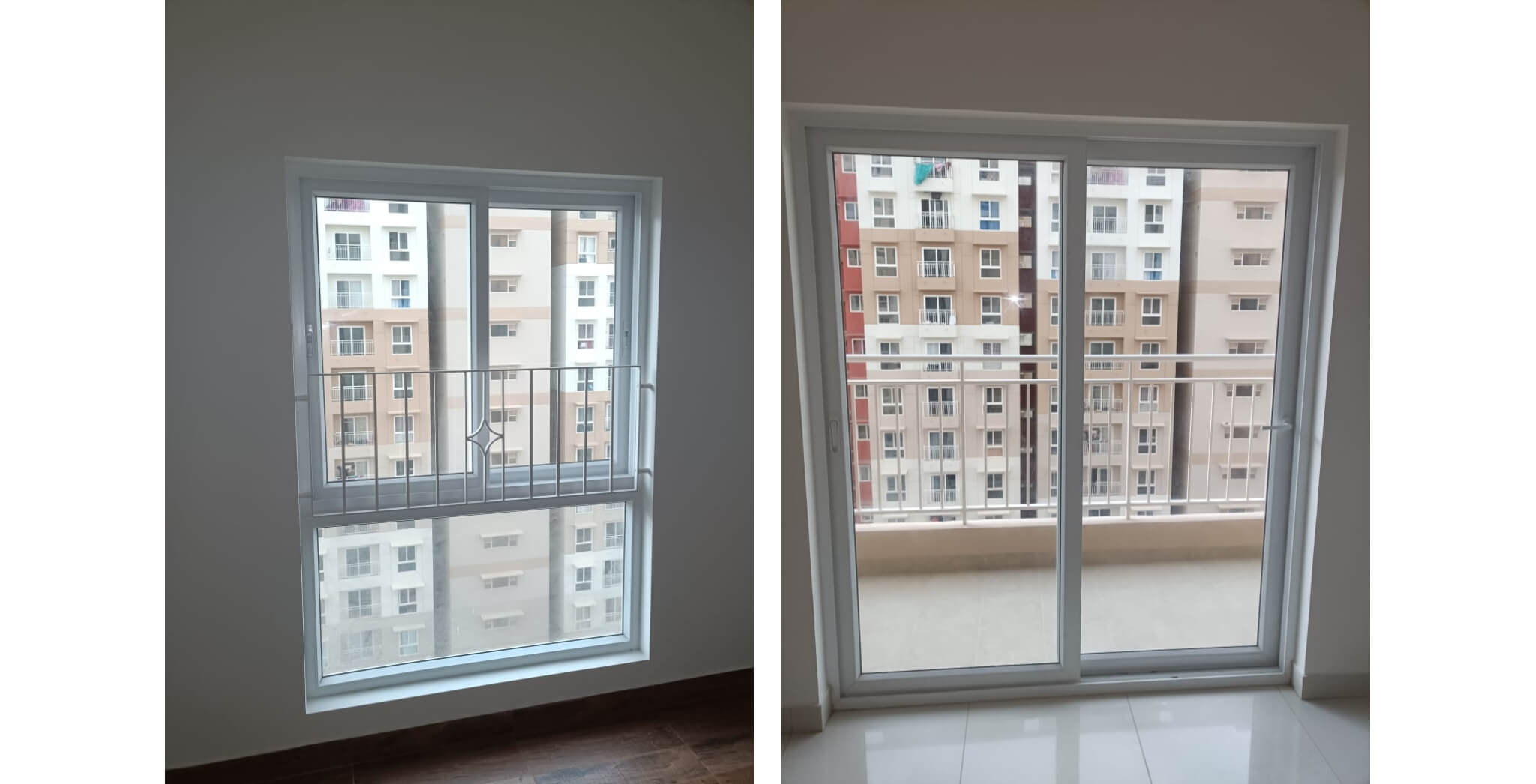

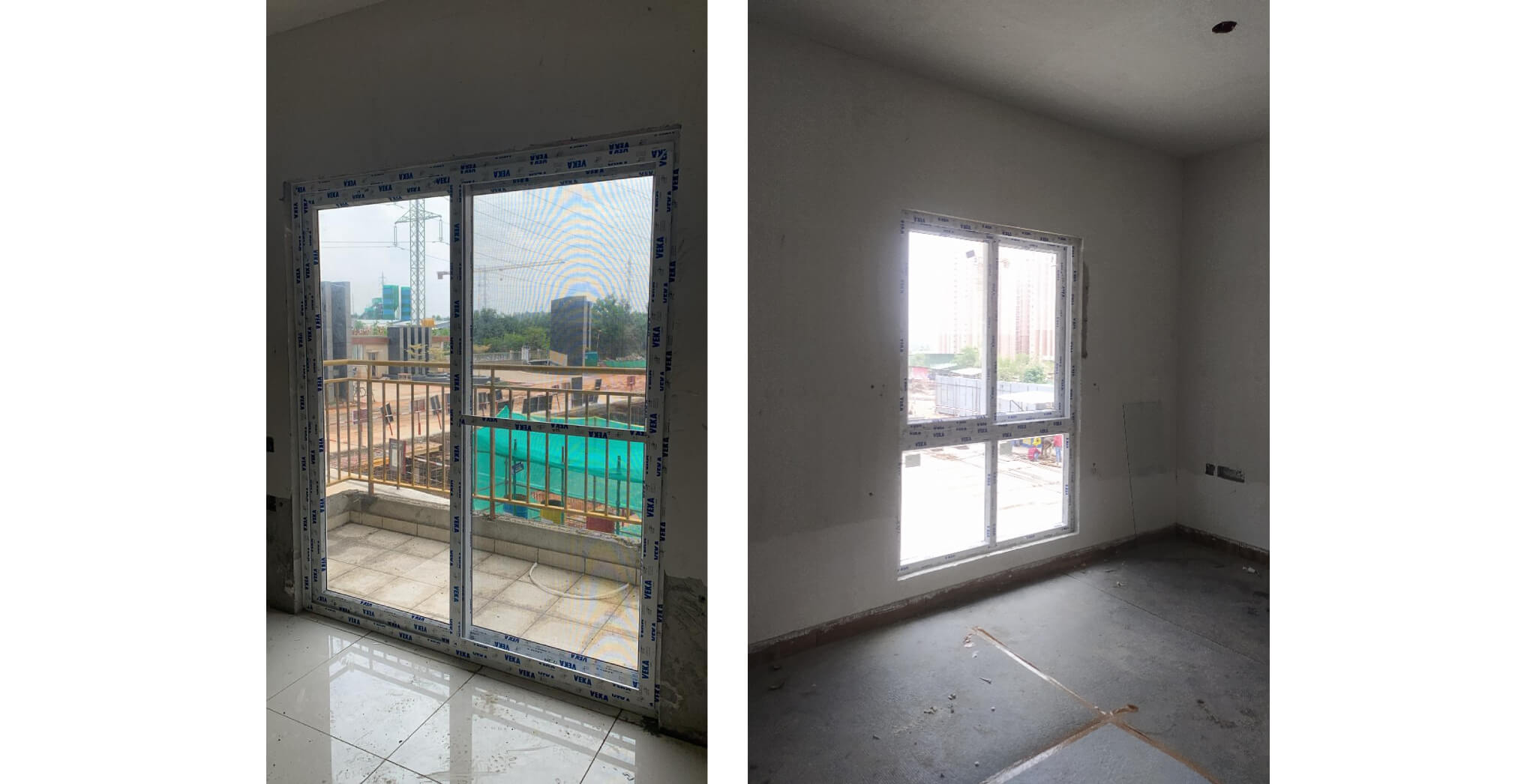

UPVC doors and windows
Dec 2025

Fixing of doors
Dec 2025

External painting work
Dec 2025

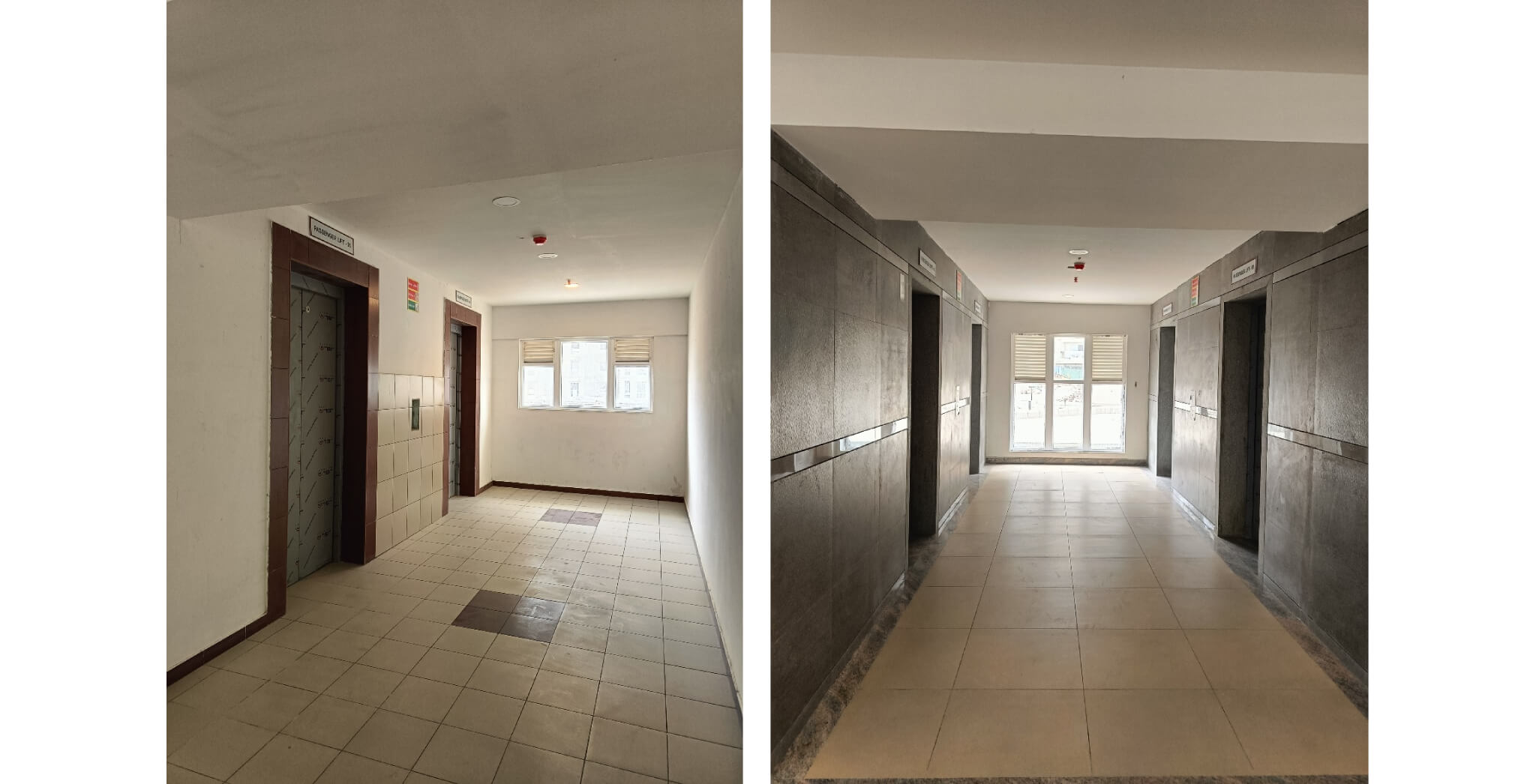

Lift installation completed
Dec 2025

Basement finishing work in progress
Dec 2025

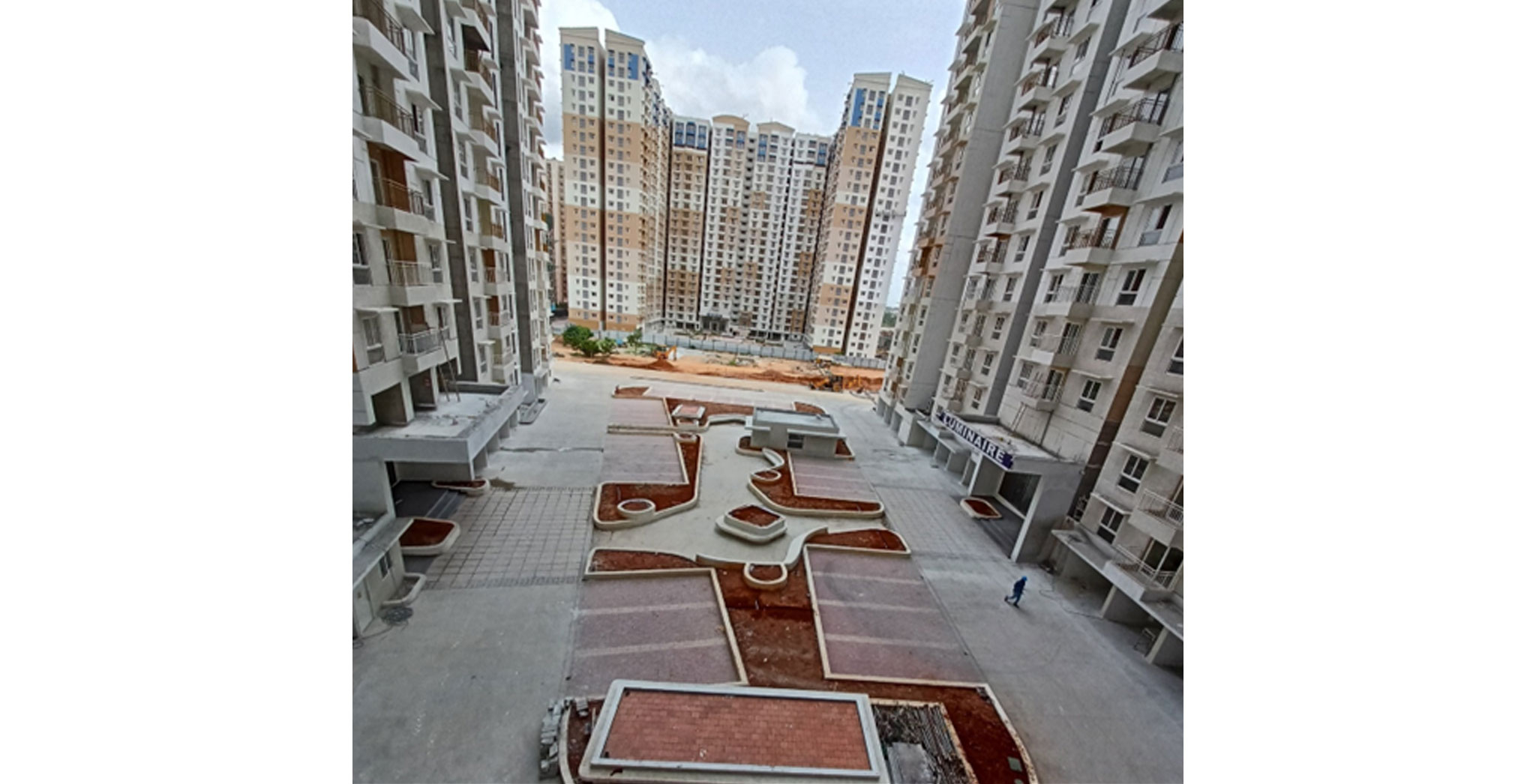

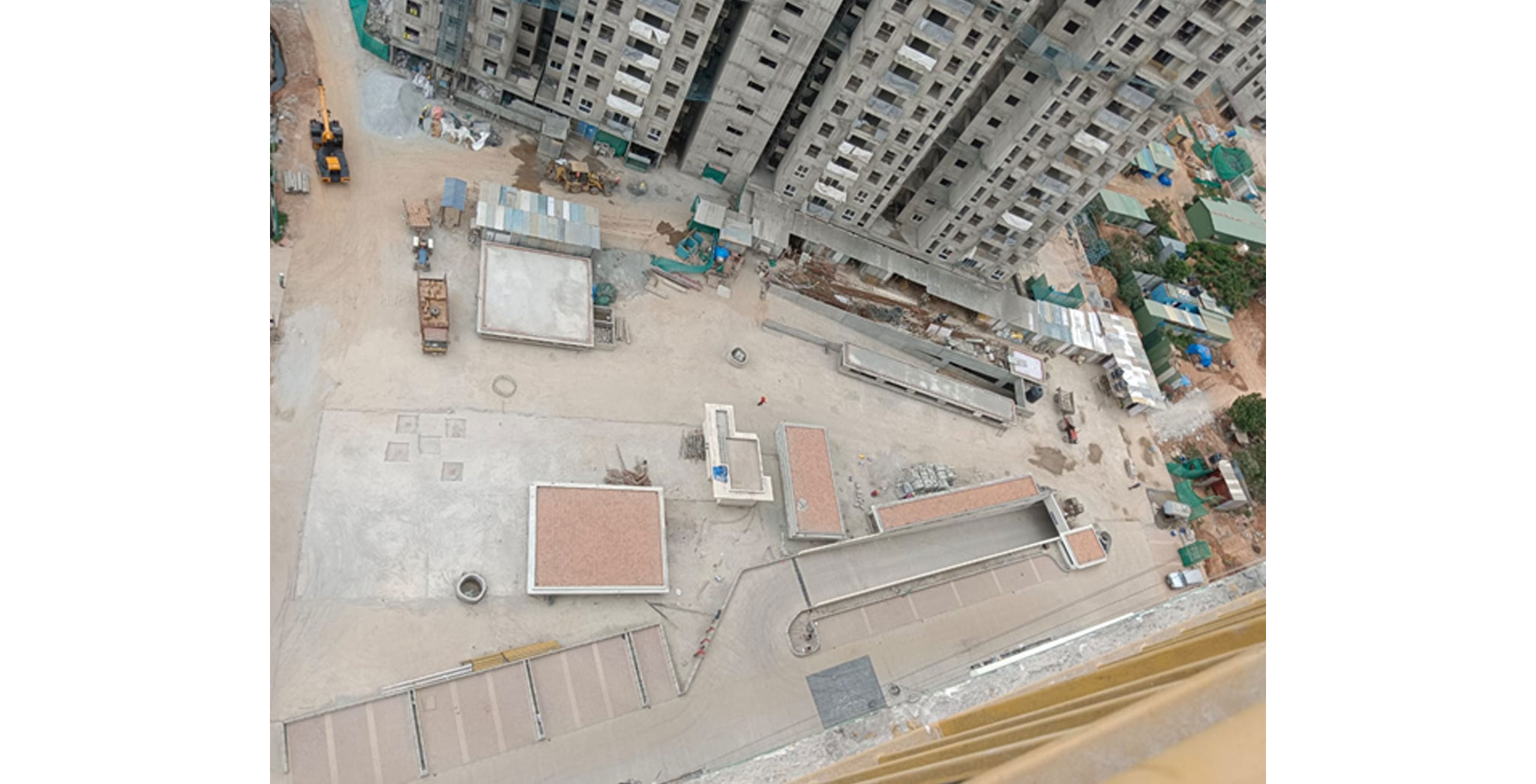

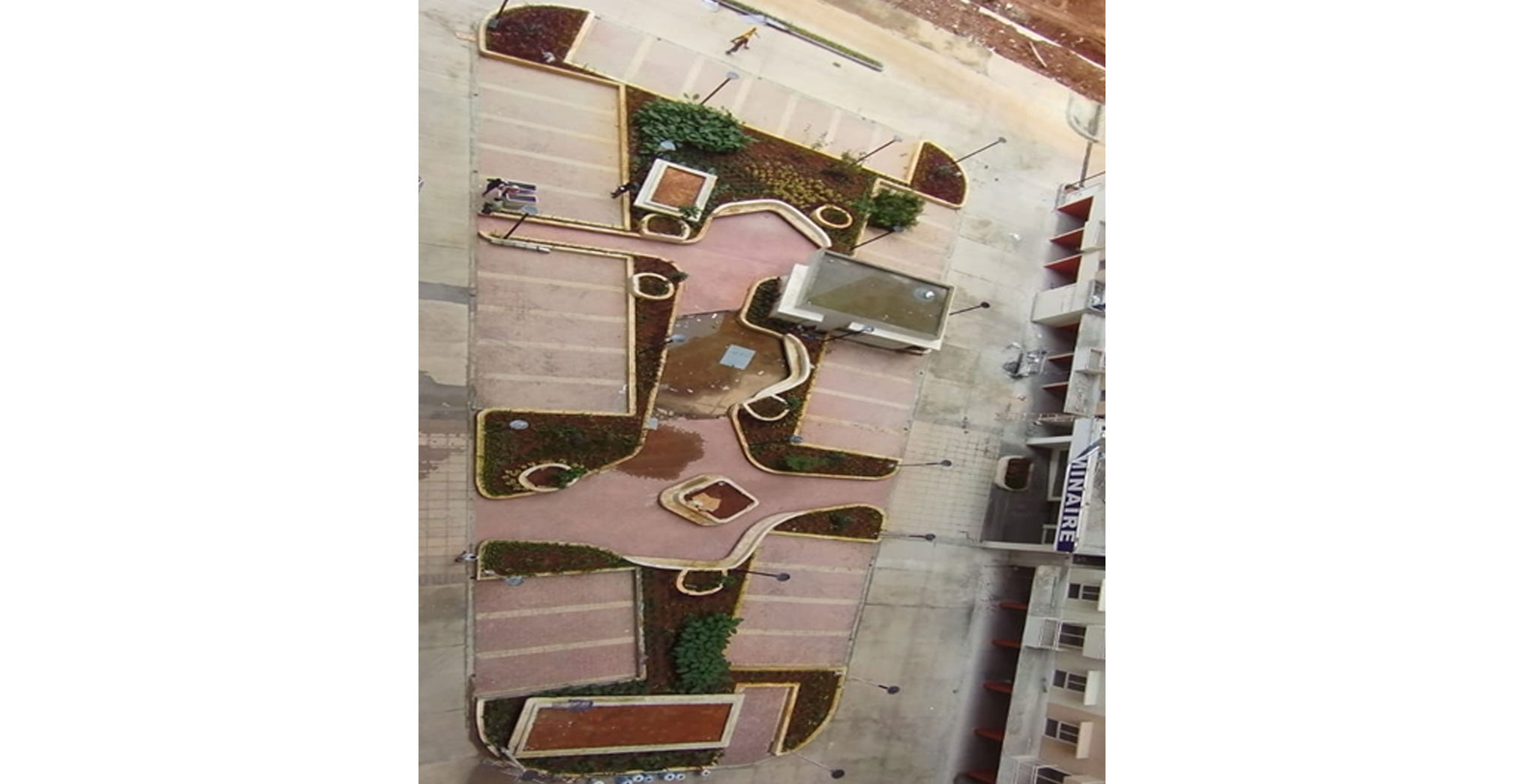

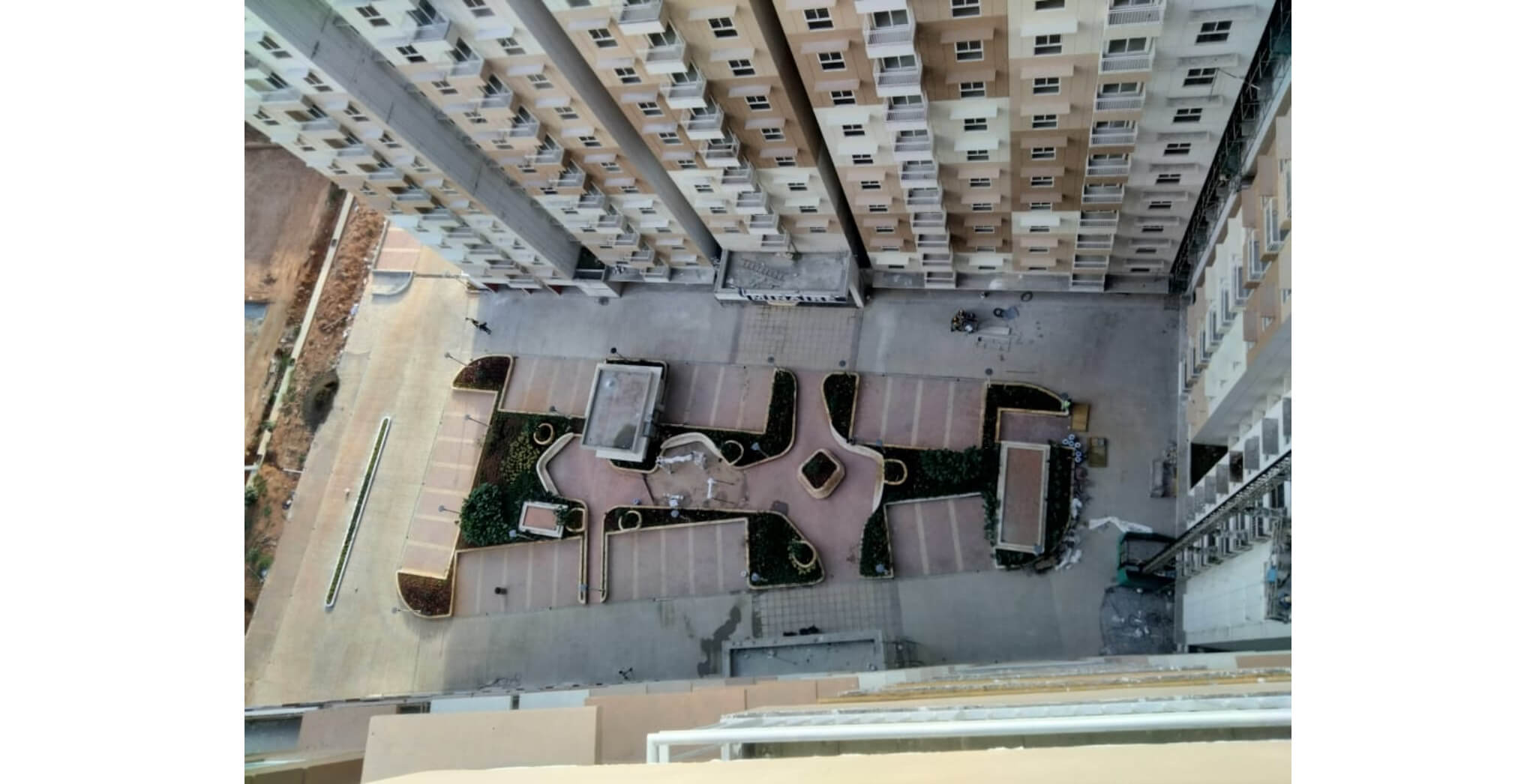

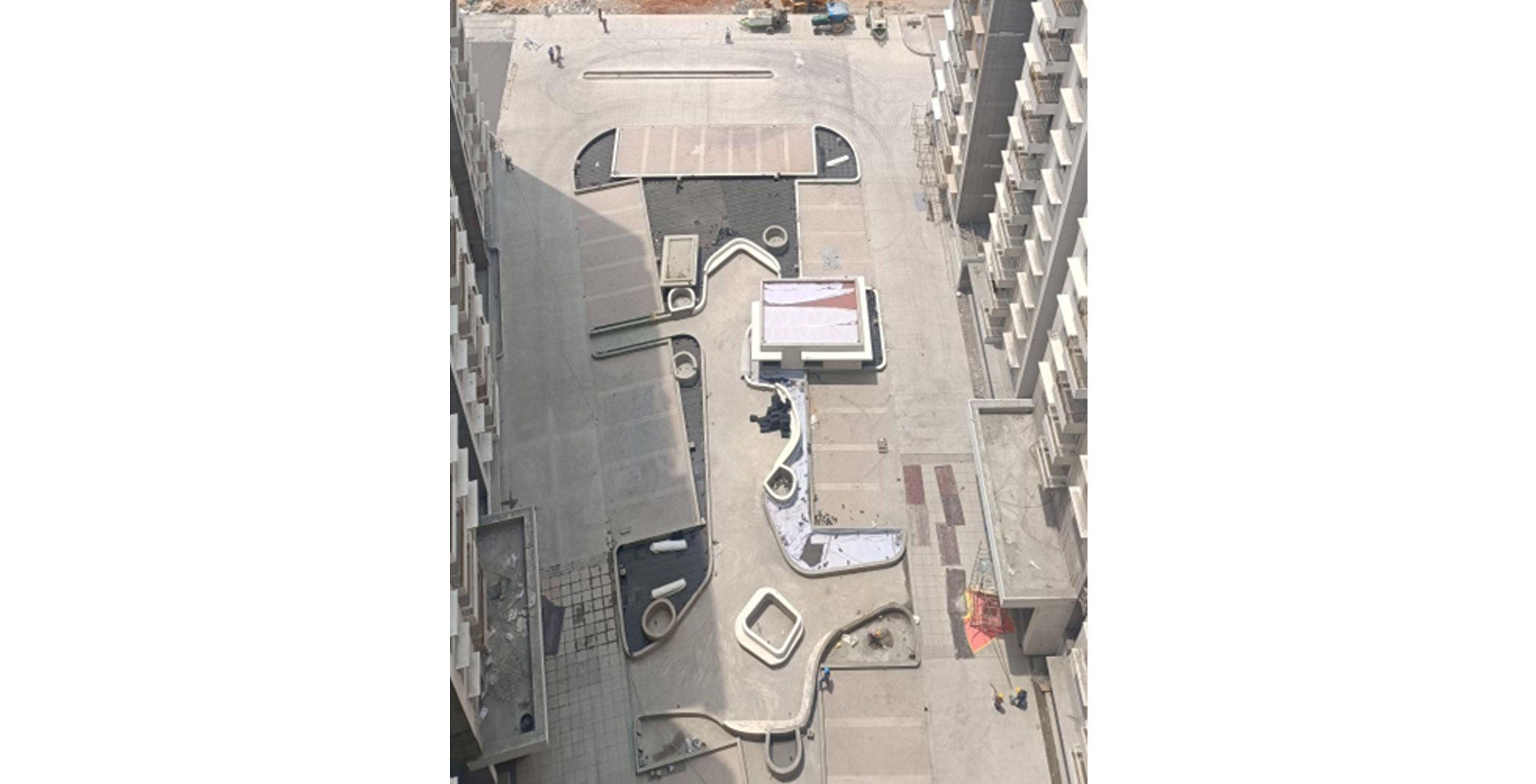

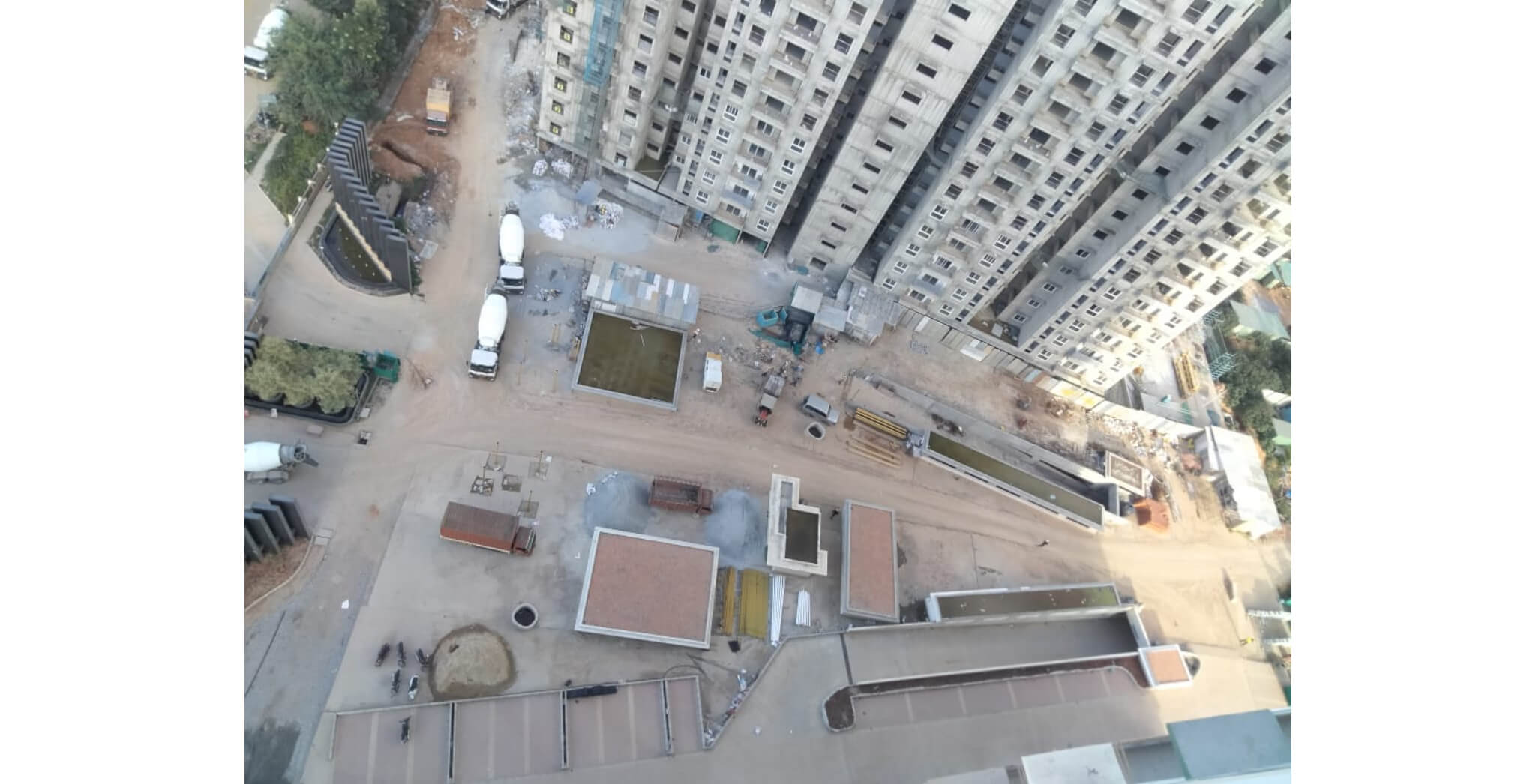

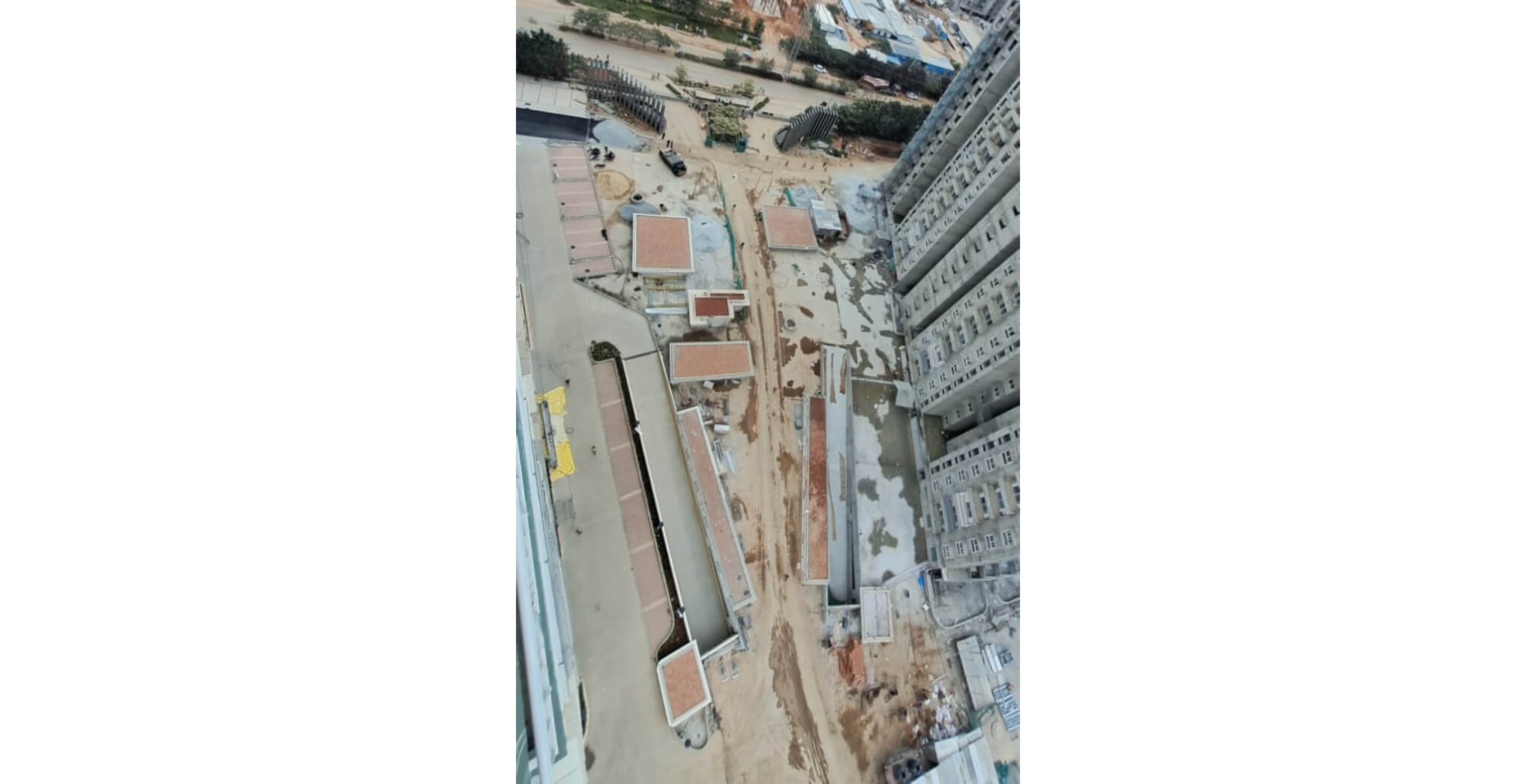

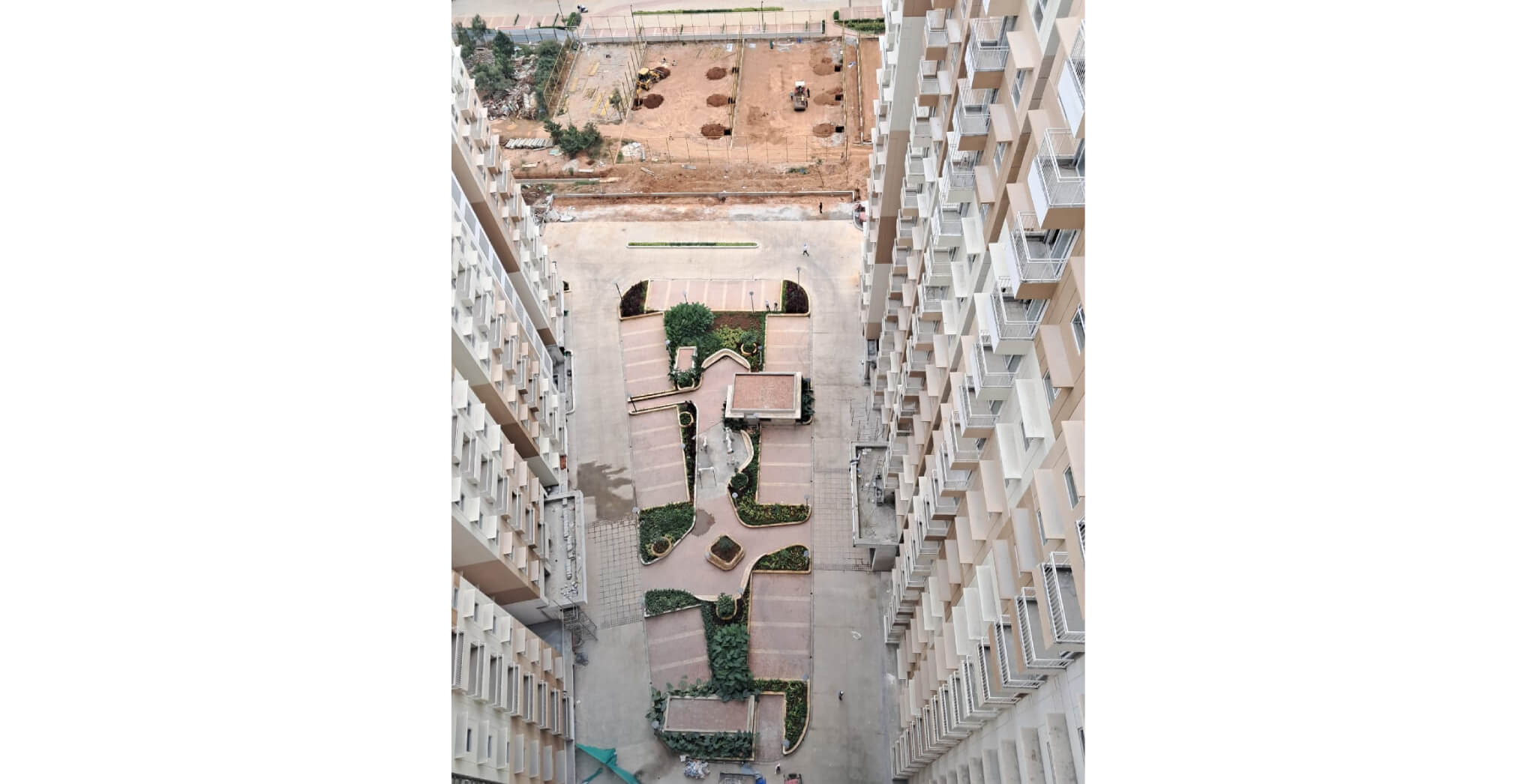

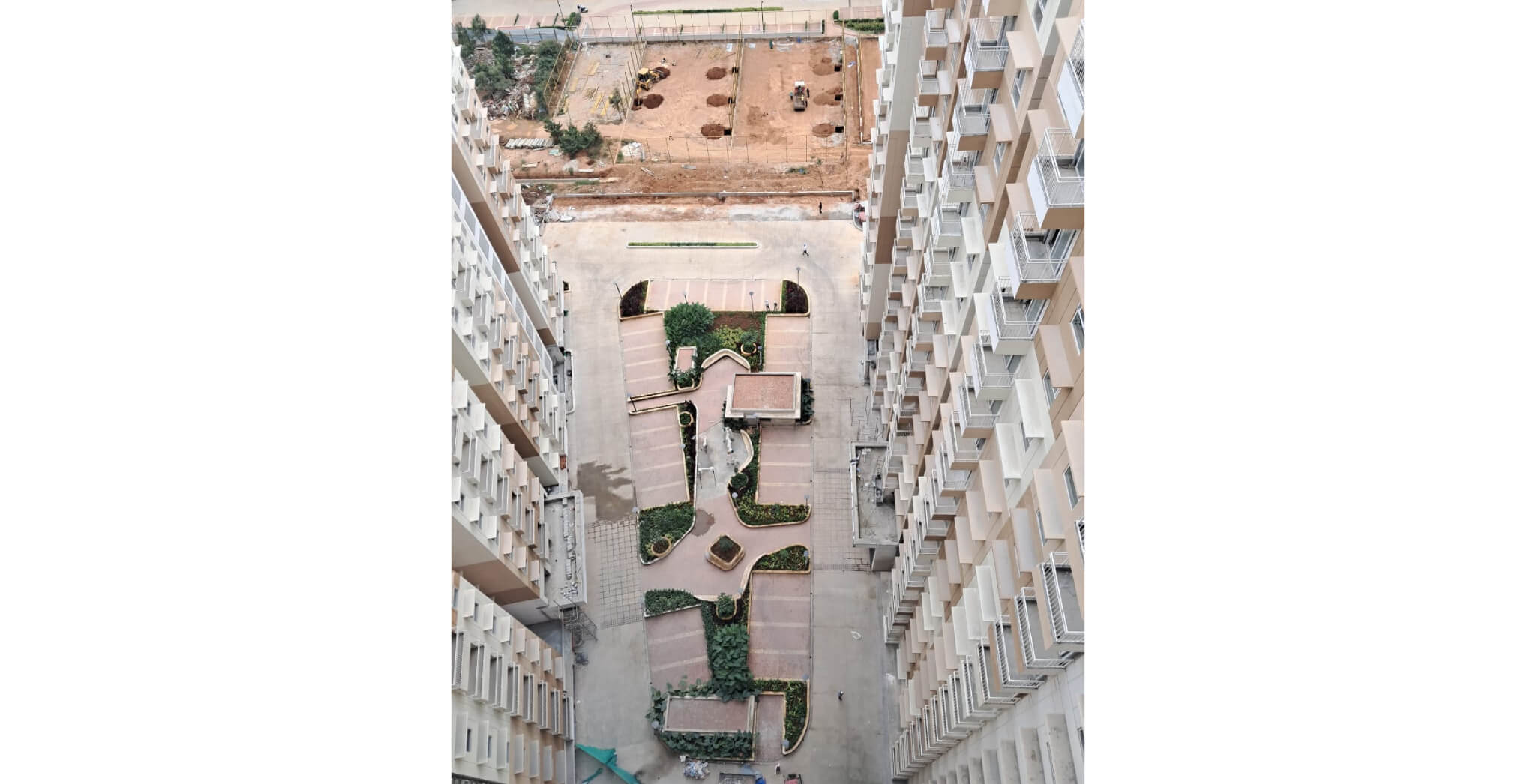

Central podium completed
Dec 2025

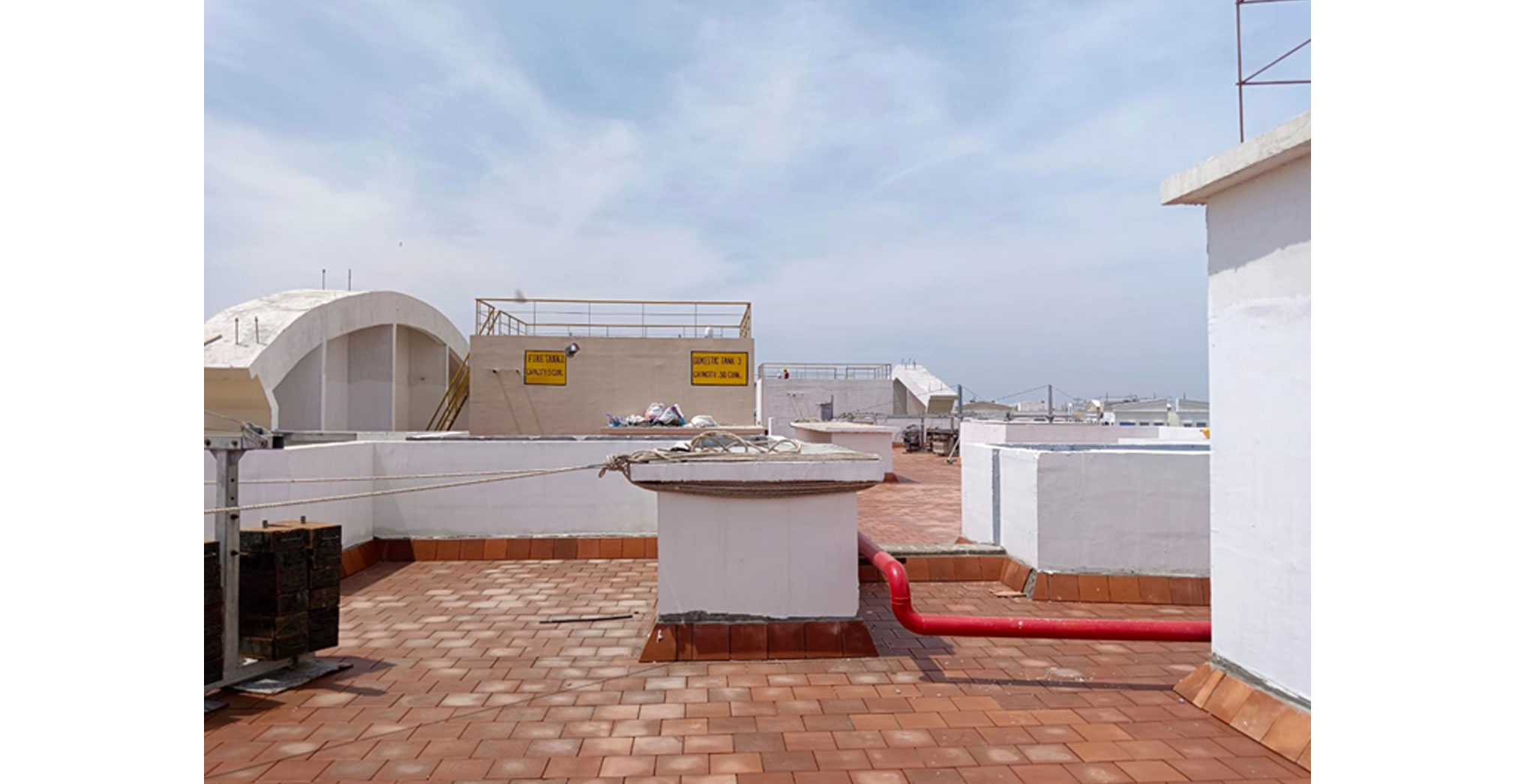

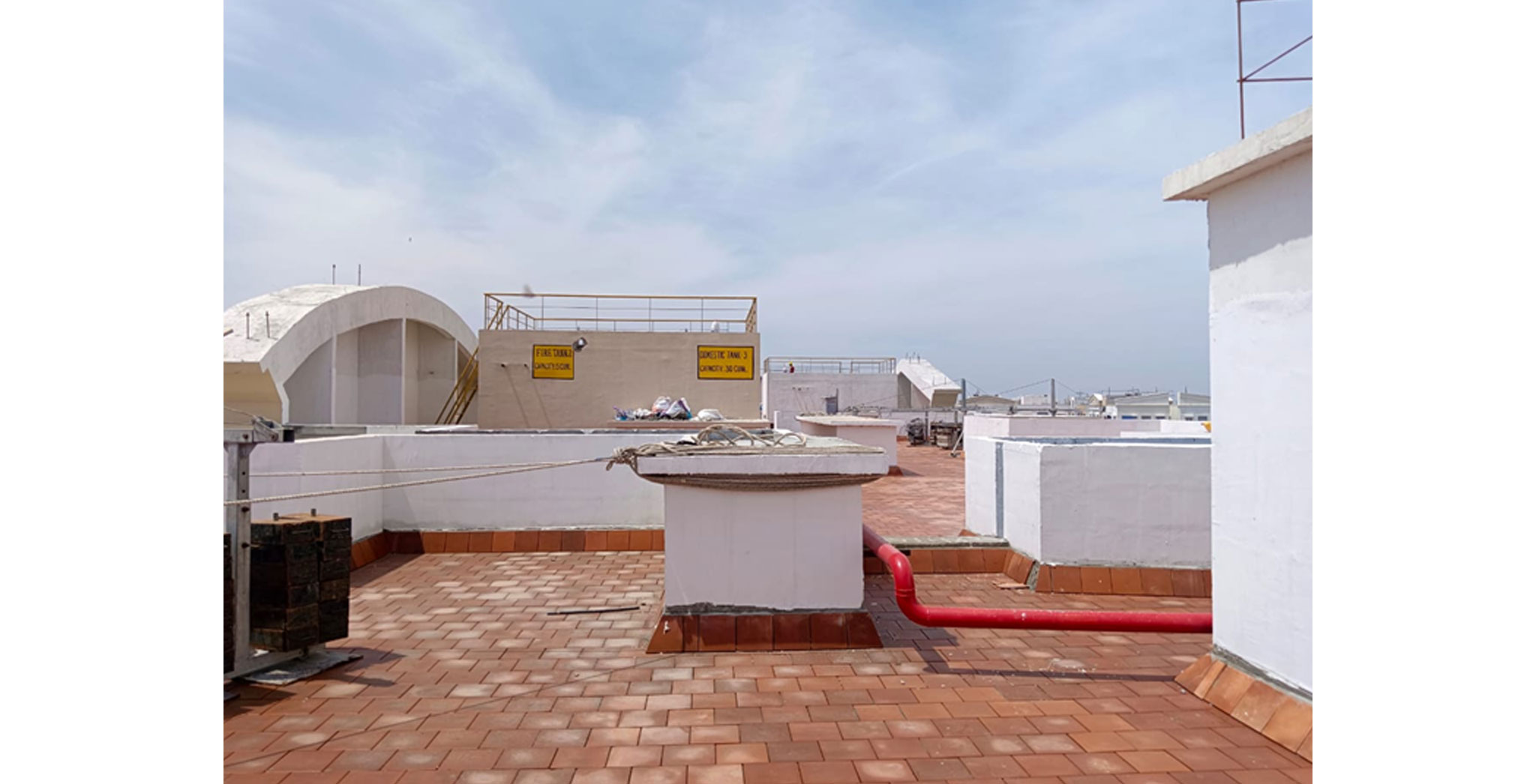

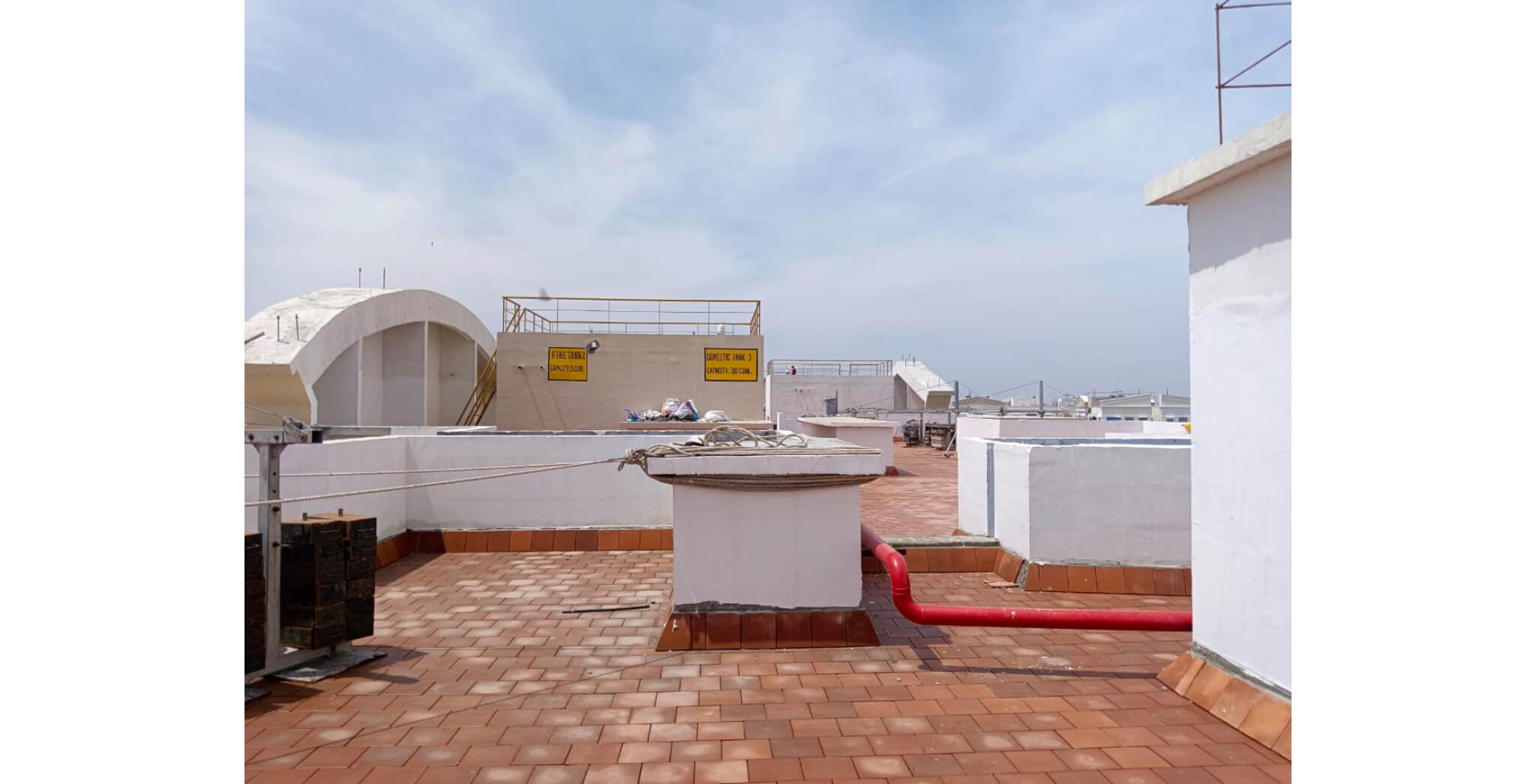

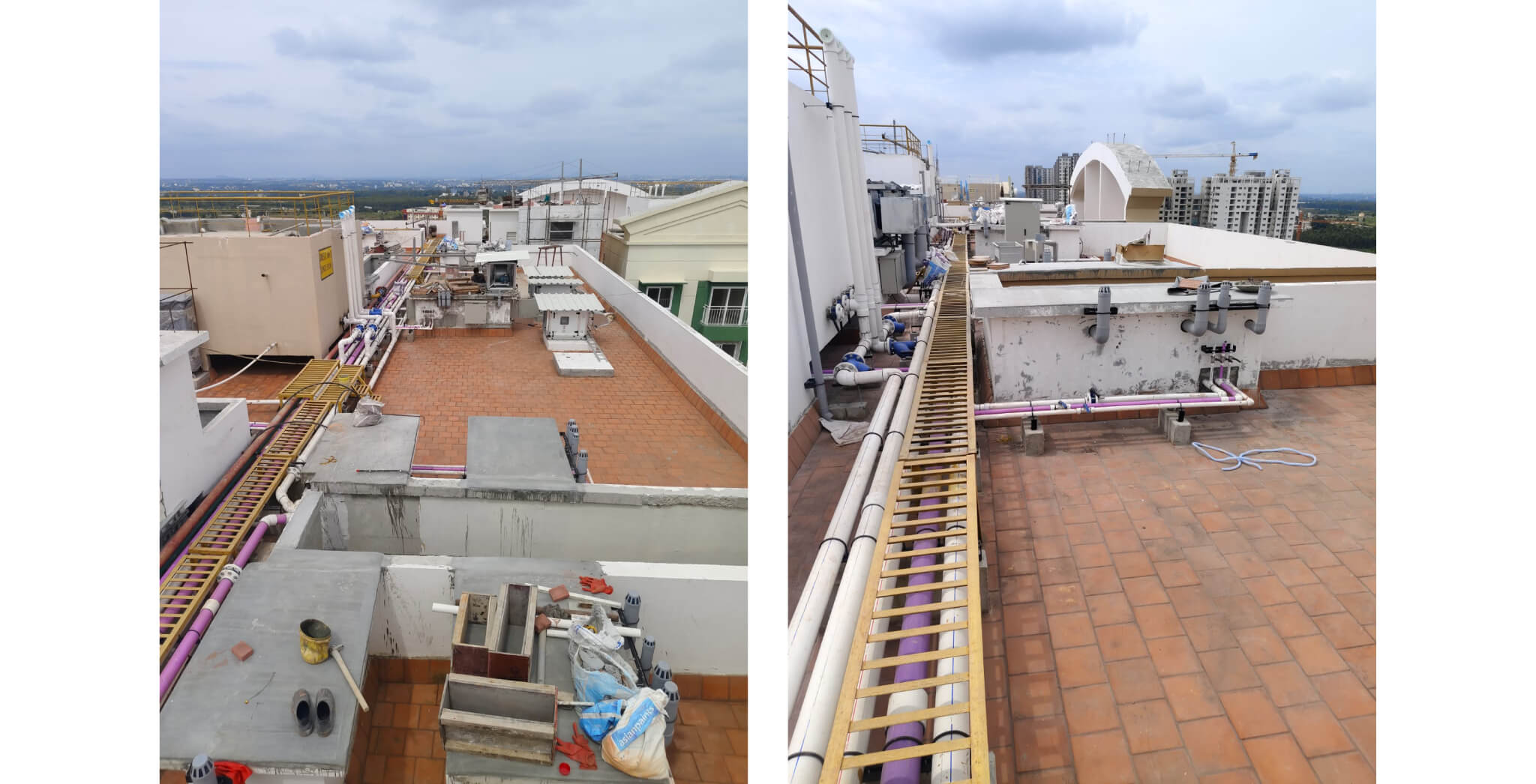

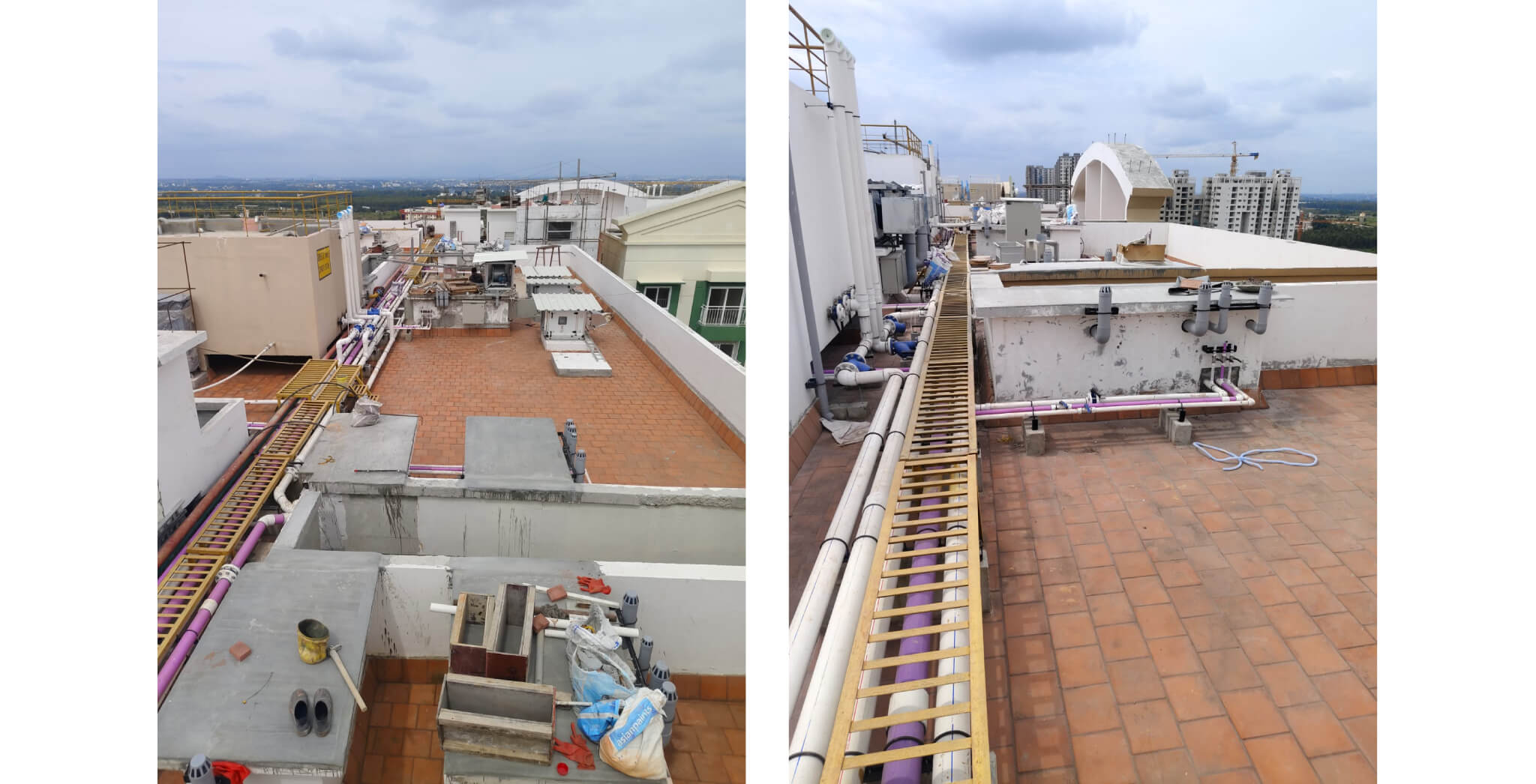

Above terrace painting and services work in progress
Dec 2025
